TeamBoard ProScheduler

Report

Reports allow users to gather and analyze key data, such as capacity, scheduled hours, logged hours, etc., from various plans, including team, project, and program levels. These insights help track performance, monitor workloads, and support better decision-making.

Reports can be customized with filters to focus on the most relevant information, and the data can be managed or exported to Excel for further analysis and sharing.

The Report Board offers three distinct sections for data reports: Summary, Chart, and Table.

CleanShot 2025-08-08 at 10.24.39@2x-20250808-032630.jpg
  1. Summary Reports: Provide a high-level overview, focusing on key insights and essential data.

  2. Chart Reports: Use column charts to visually present key metrics like capacity, scheduled, and logged hours, enabling quick comparisons across categories or time periods.

  3. Table Reports: Display detailed data in a structured, row-and-column format, offering an in-depth view.

Filter options

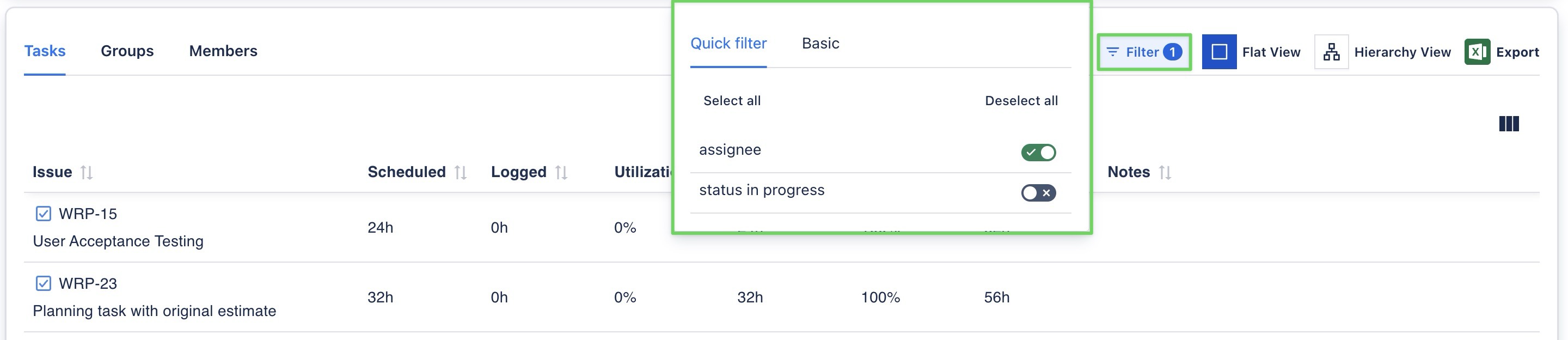

The following filters allow you to customize the data displayed in the Report:

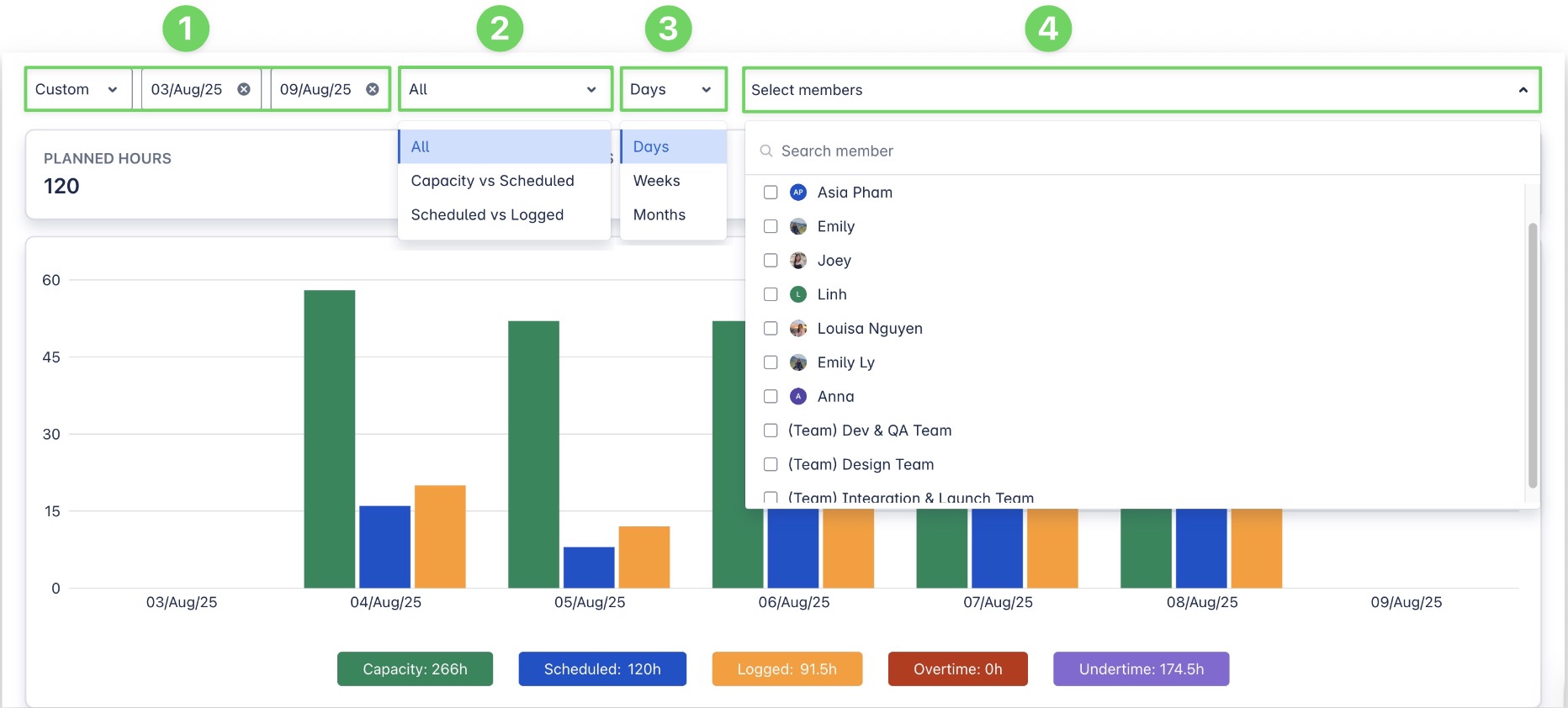

CleanShot 2025-08-07 at 13.13.15@2x-20250807-061327.jpg

Options

Description

  1. 📅 Date range picker: Choose a specific date range to view relevant data.

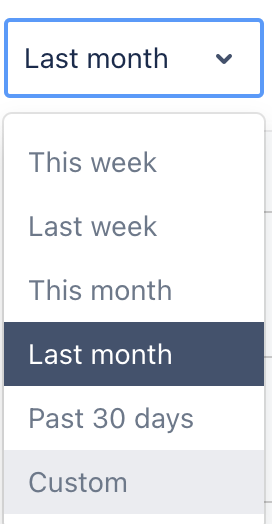

Dynamic range: Select a relative time frame (e.g., This week, Last 30 days). The range updates automatically over time.

Fixed range: Set a custom date range by selecting a specific start and end date.

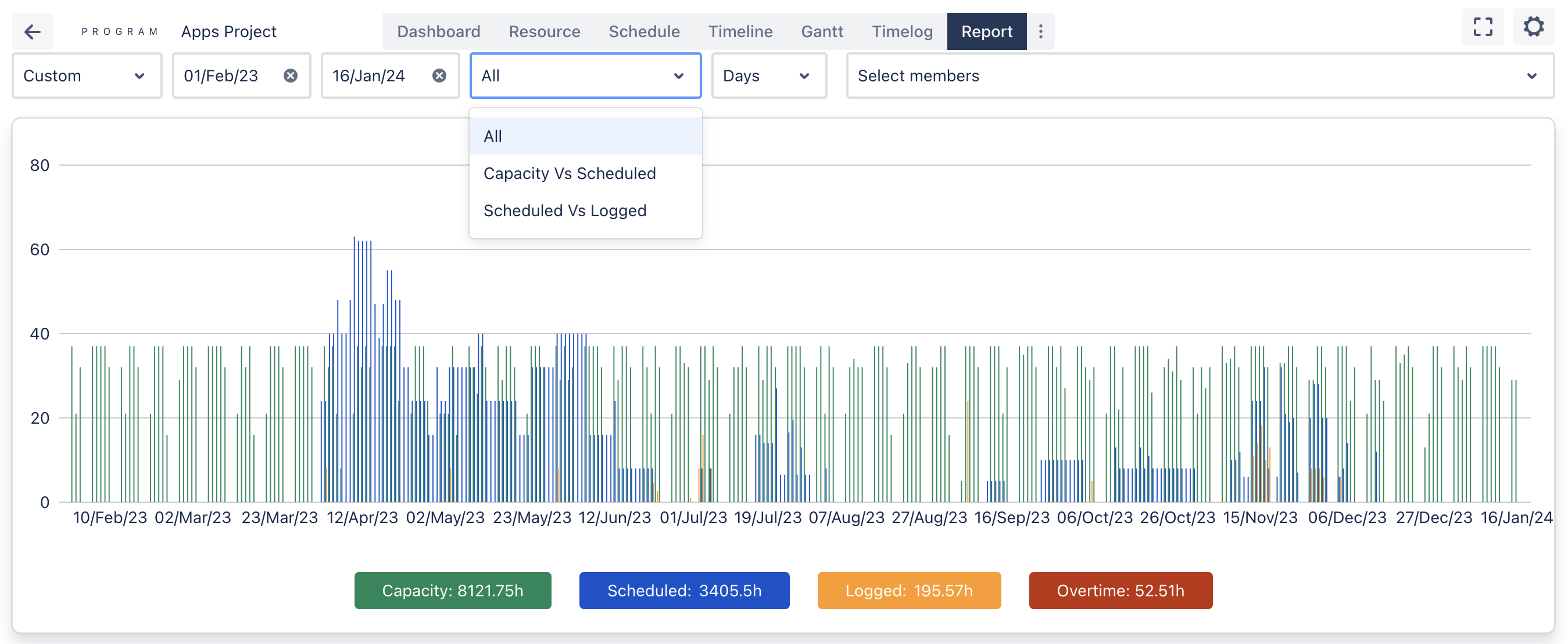

  1. 📊 View type selector: Choose how you want the data to be displayed in the chart.

🟩 🟦 🟧 All: Shows capacity, scheduled, and logged hours together for full visibility.

🟩 🟦 Capacity vs Scheduled: Compares how much time was available (capacity) vs. how much was planned (scheduled).

🟦 🟧 Scheduled vs Logged: Compares planned hours against actual time spent.

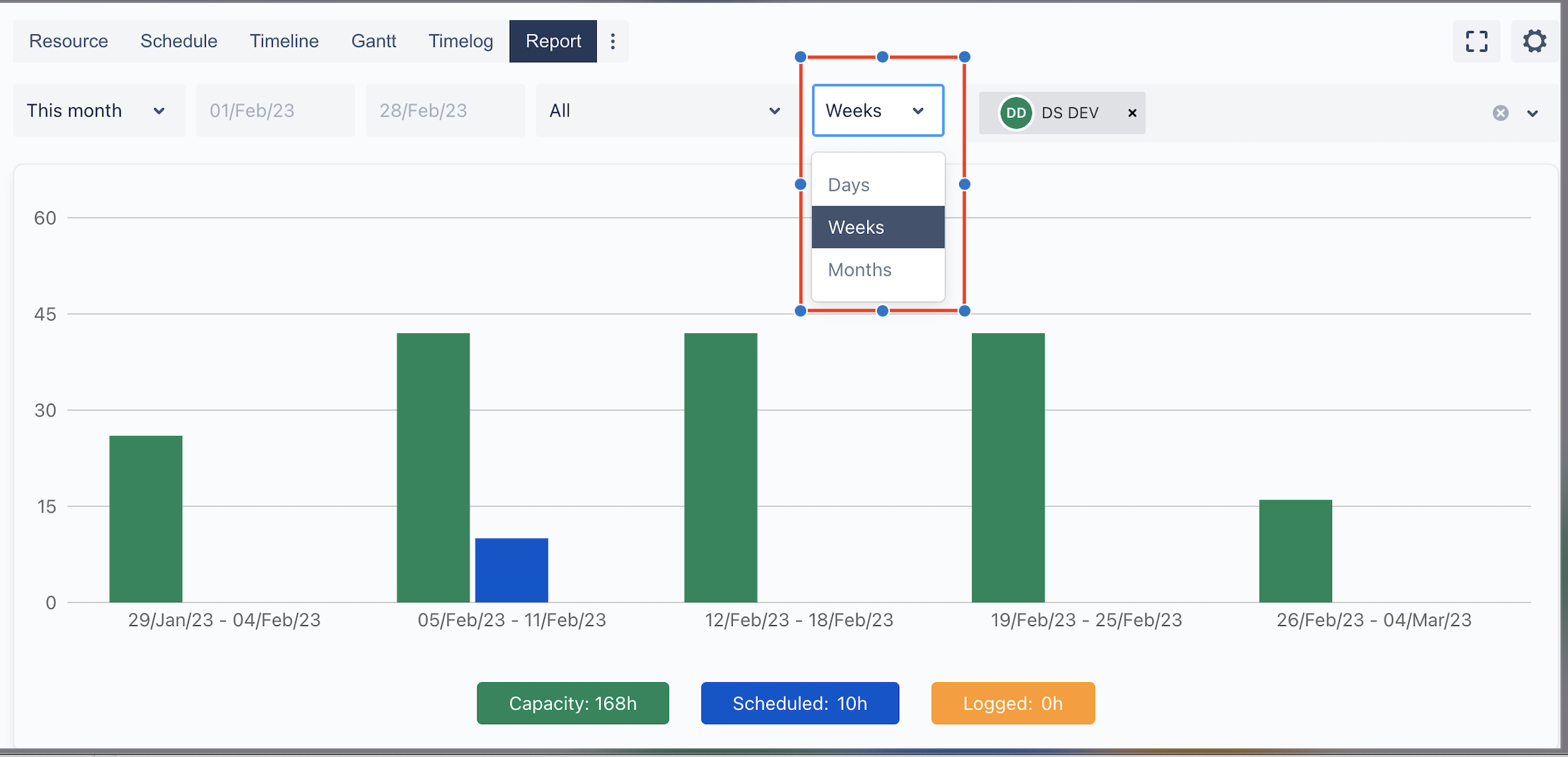

  1. 🕒 Time unit selector: Choose the time period for grouping the data in the chart.

📅 Days: View data broken down by each day.

📆 Weeks: View weekly summaries.

🗓️ Months: View monthly totals.

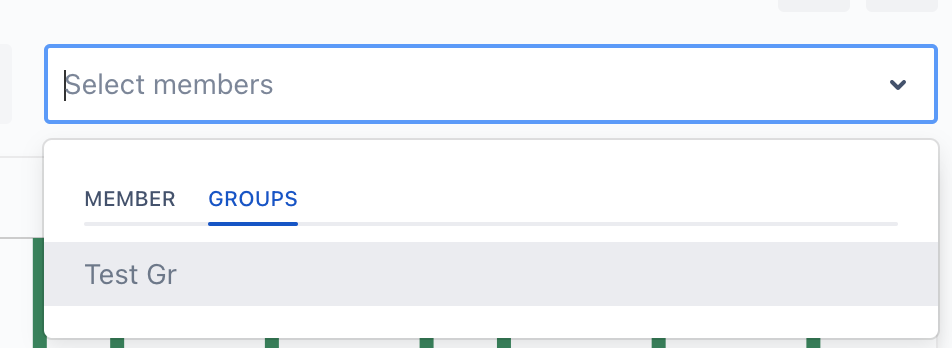

  1. 👥 Member/Team Filter: Choose members or groups that you would like to see in the report.


🔍 Search by name

👤 Select individual members

👥 Select entire teams

Summary Report

The Summary Report offers a concise yet comprehensive overview of key project metrics. It serves as a snapshot of critical data, helping project managers and stakeholders quickly assess the status and scope of ongoing efforts.

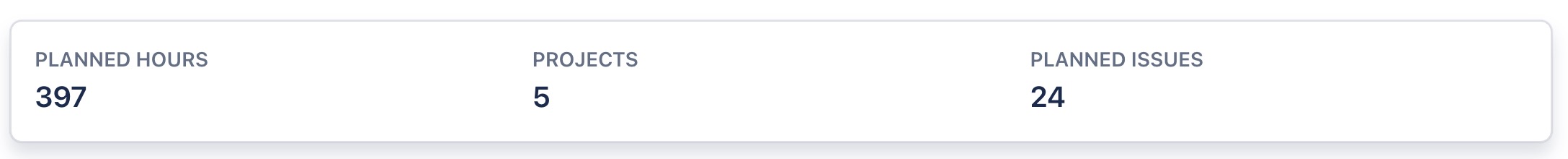

CleanShot 2025-08-08 at 11.27.29@2x-20250808-042737.jpg

This report includes important metrics such as:

  • Planned hours: Refers to the total estimated time allocated for completing all scheduled tasks across the entire project.

  • Projects: In the context of the program or team, this metric indicates the total number of projects included in the report.

  • Planned issues: Refers to the number of tasks that have been planned for completion within the project.

Chart Report

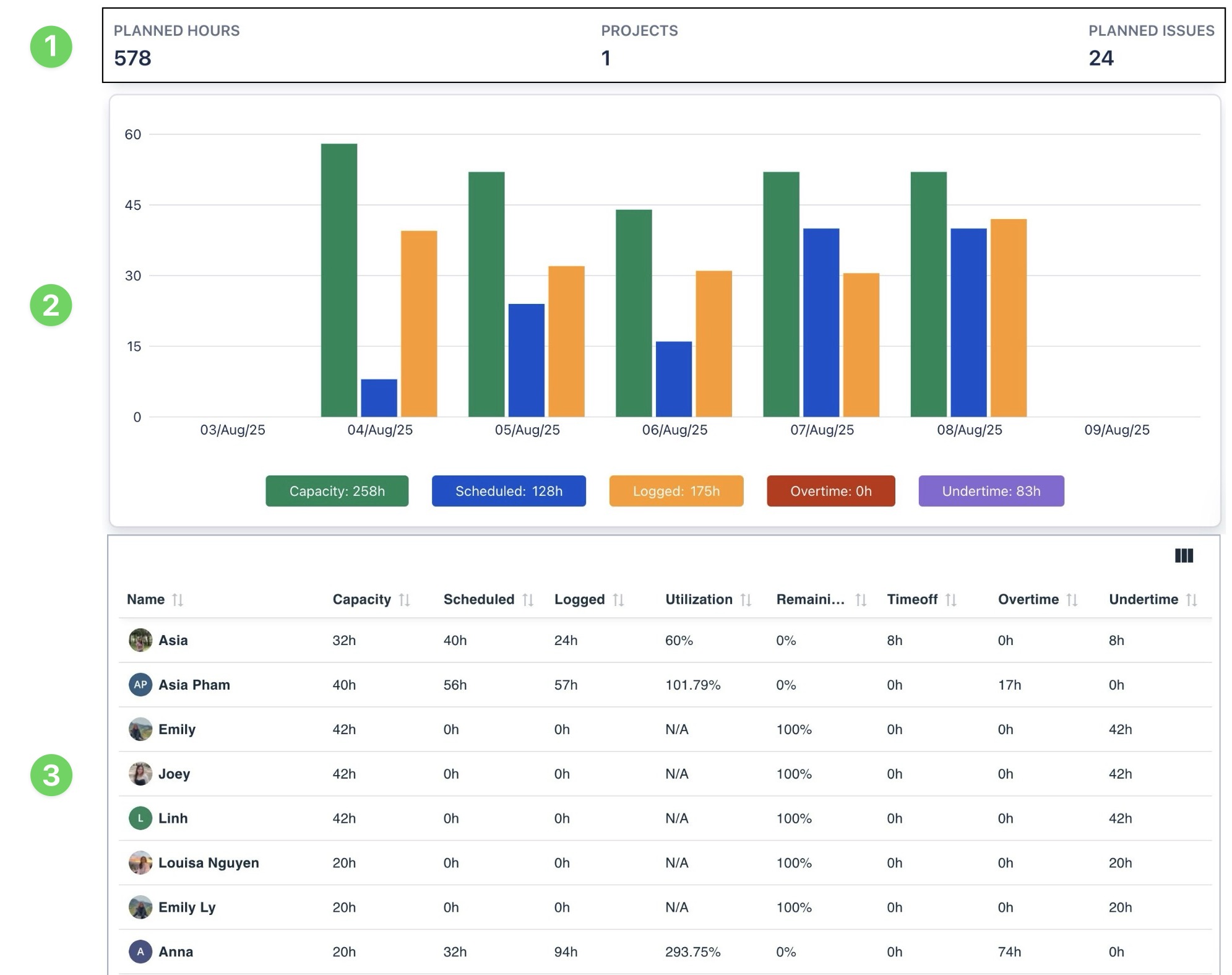

The Chart Report provides a visual overview of key metrics such as capacity, scheduled hours, and logged hours, using column charts for easy comparison across categories or time periods. It also highlights overtime and undertime to help identify resource utilization imbalances and optimize workload management.

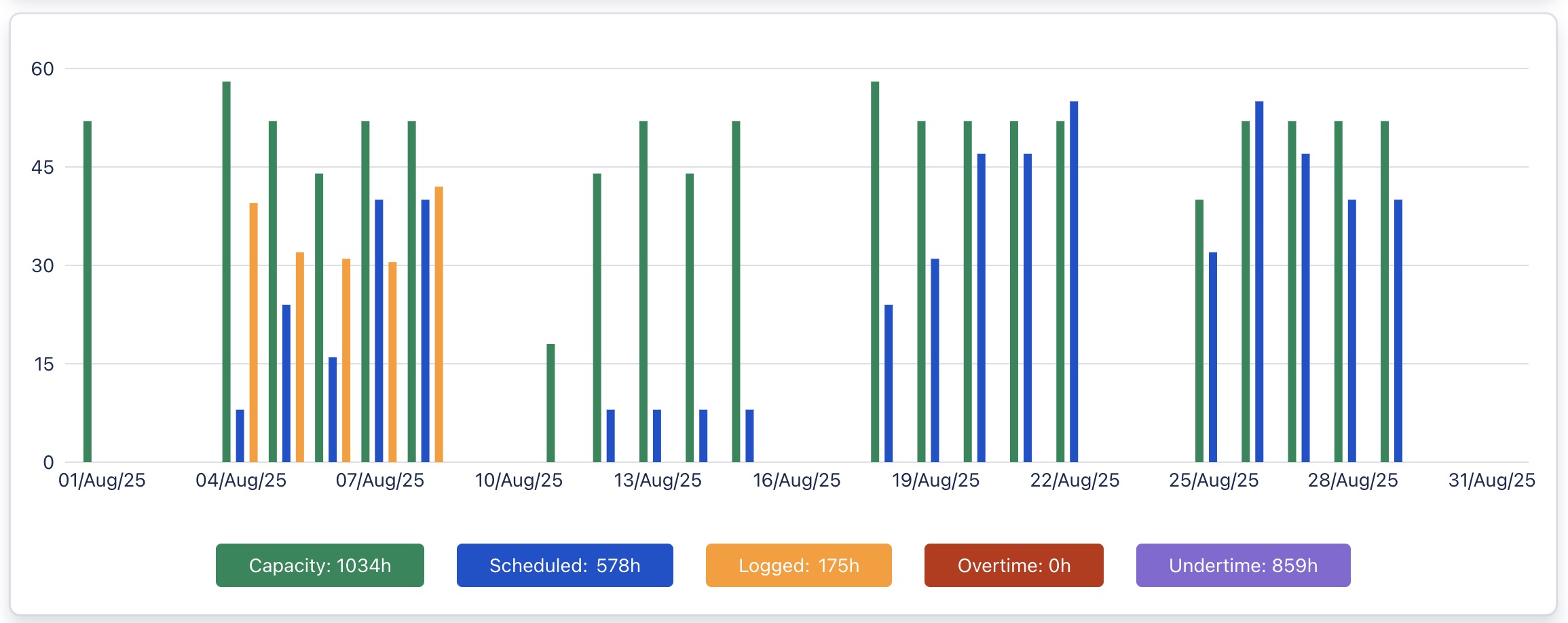

CleanShot 2025-08-08 at 11.30.49@2x-20250808-043059.jpg

This report includes important metrics such as:

  • Capacity: This represents the total available time of resources that can be allocated across all tasks in a given period.

  • Scheduled: Refers to the total estimated time allocated for completing all scheduled tasks across the entire project.

  • Logged: This shows the actual hours worked or logged by the team members.

  • Overtime: This represents the logged hours are more than the capacity.

  • Undertime: This represents the logged hours are less than the capacity.

Overtime | Undertime (h) = Capacity - Logged time

Viewing detailed charts

Hold the pointer over the chart to show the detailed information for each metric.

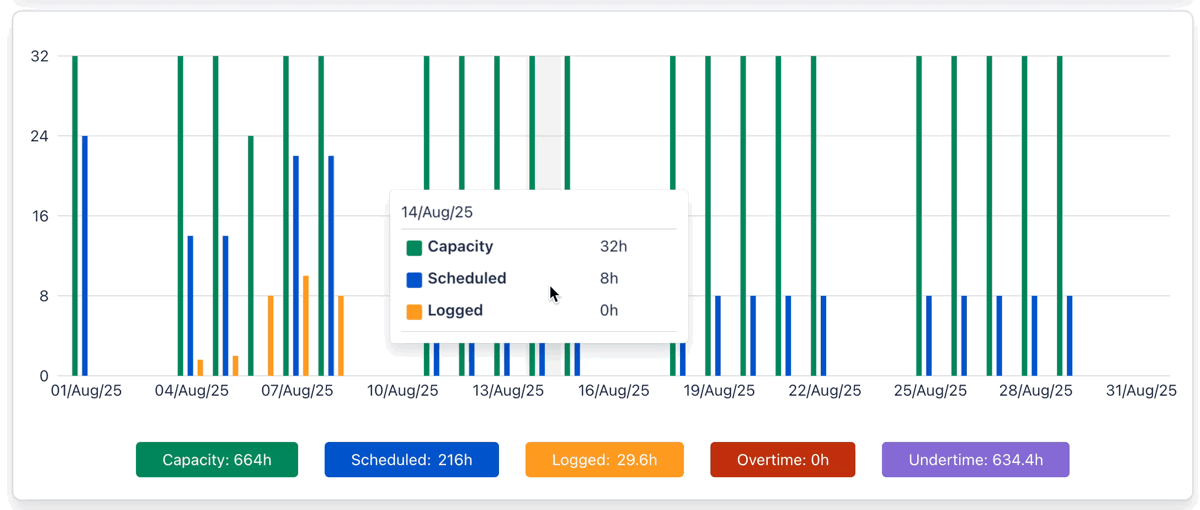

CleanShot 2025-08-08 at 14.31.57-20250808-073211.gif

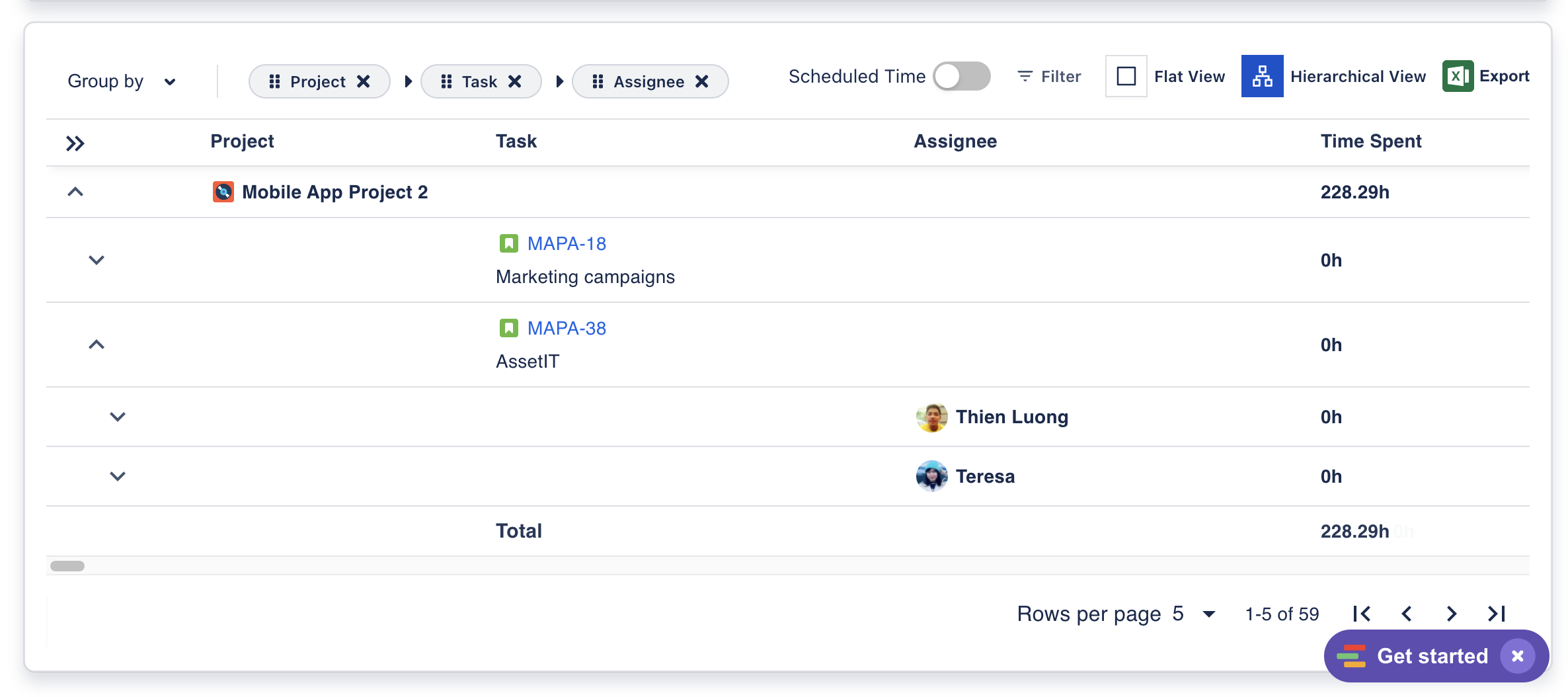

Table Report

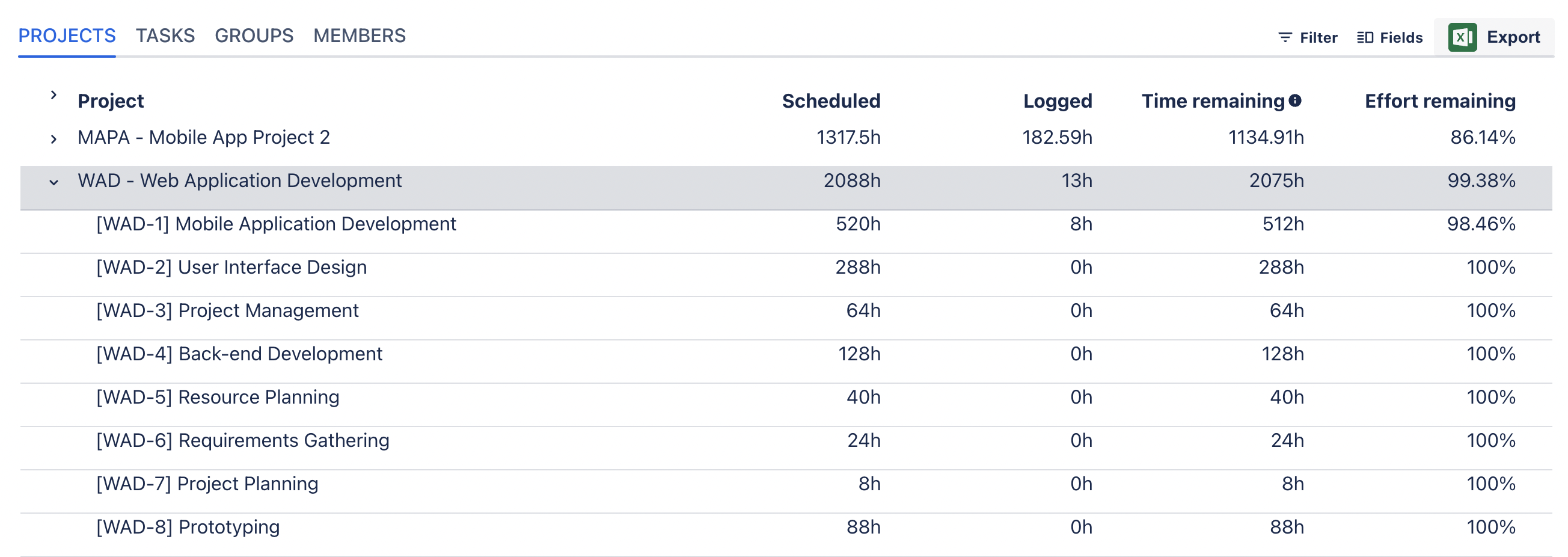

The Table Report provides detailed, tabular views of data, with options for tracking specific aspects like tasks, projects, or assignees.

Tasks

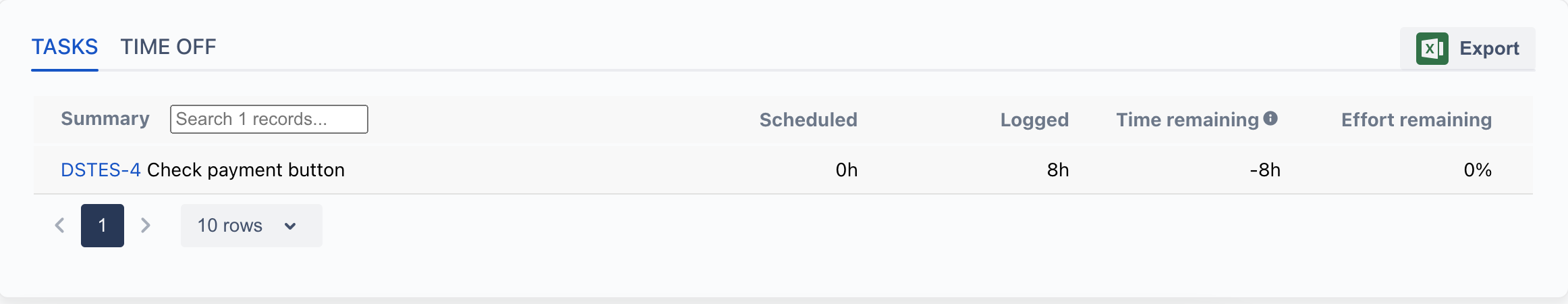

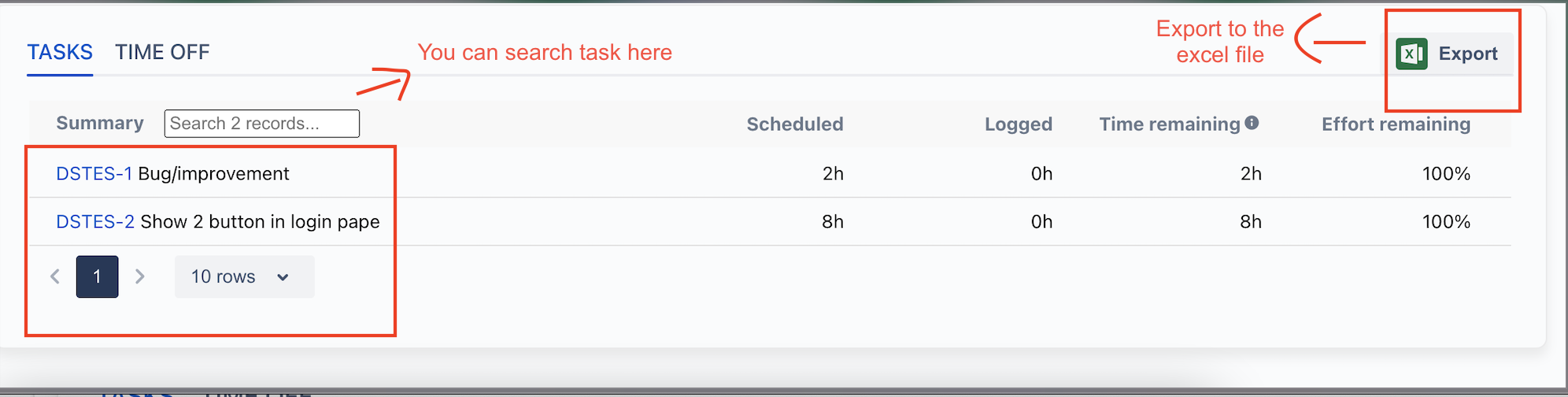

The Tasks tab displays detailed metrics for each work item.

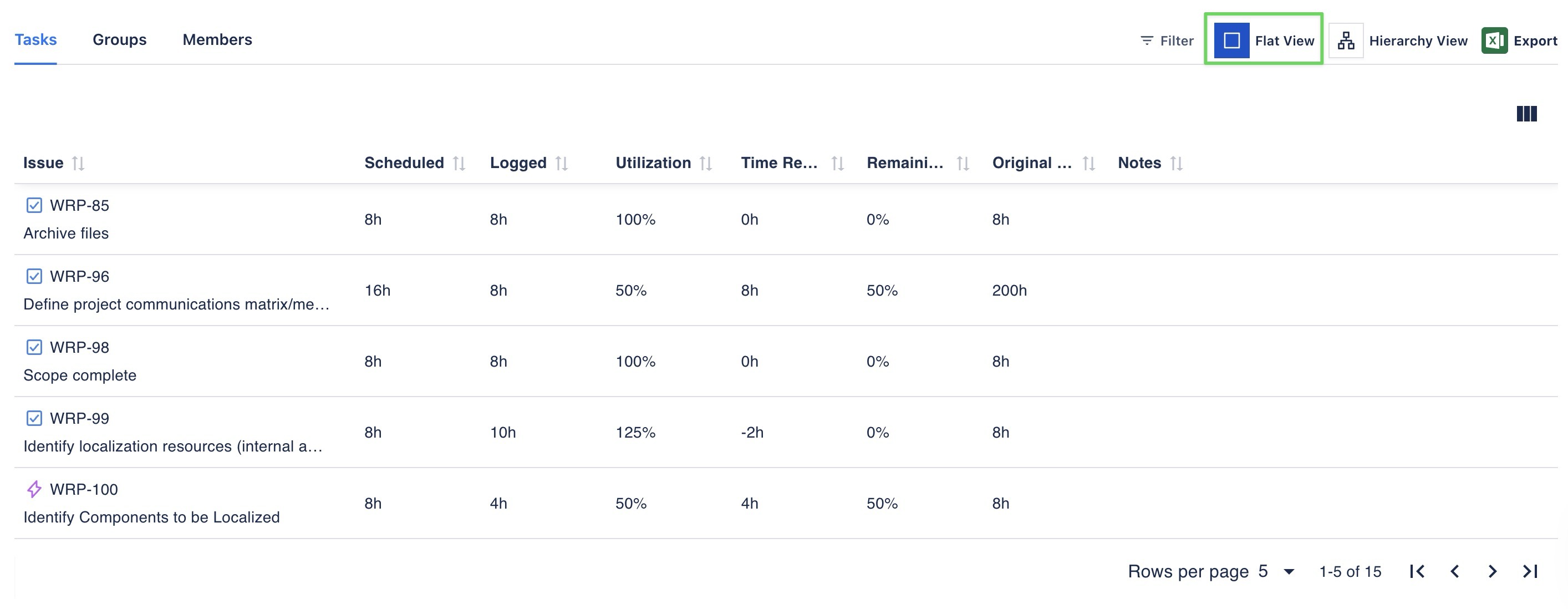

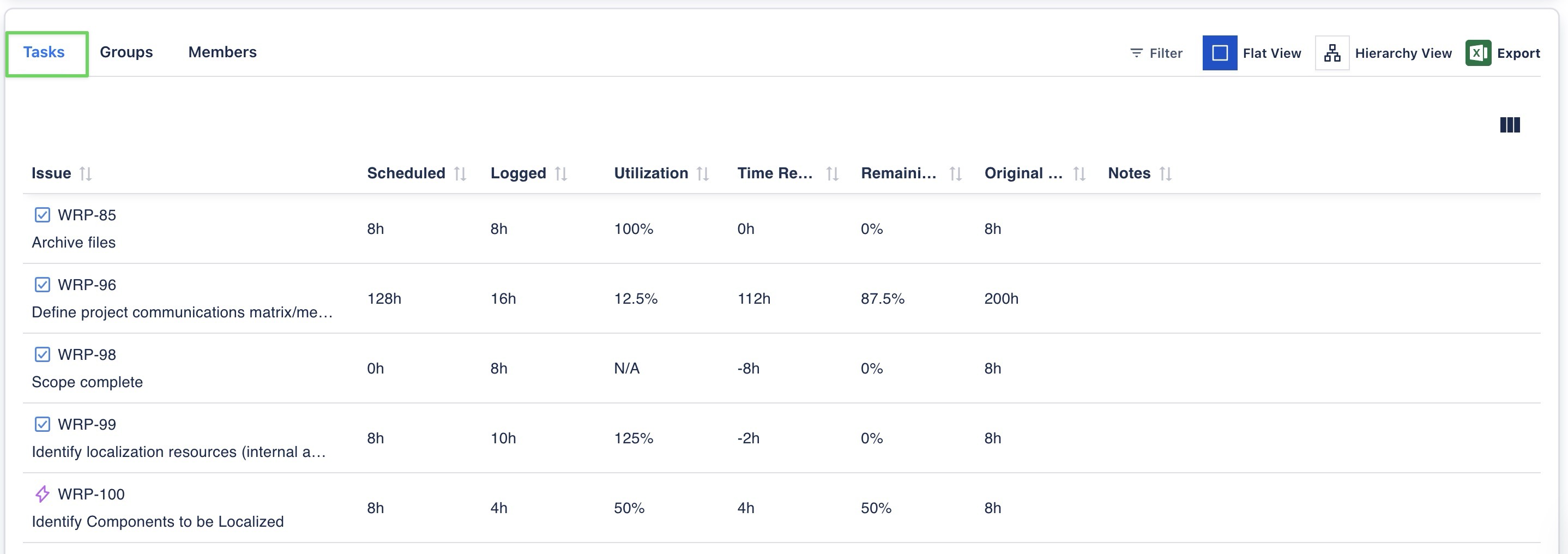

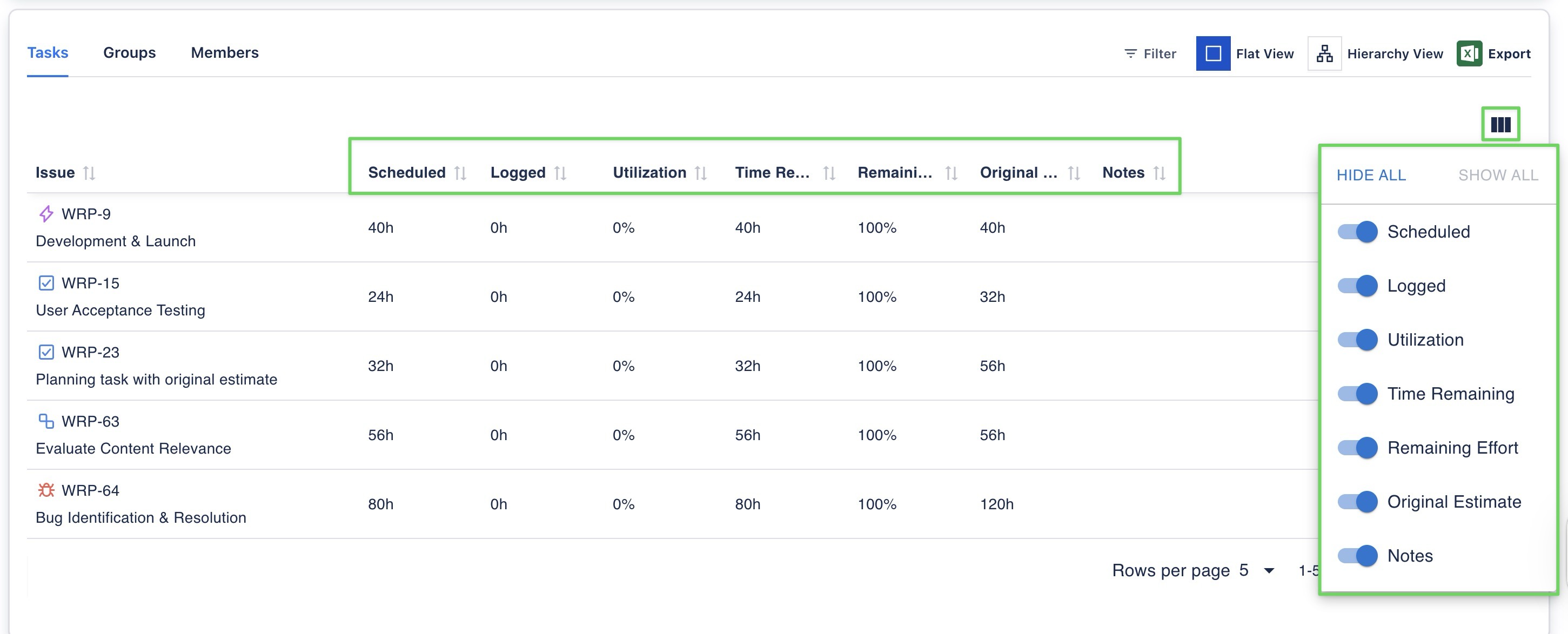

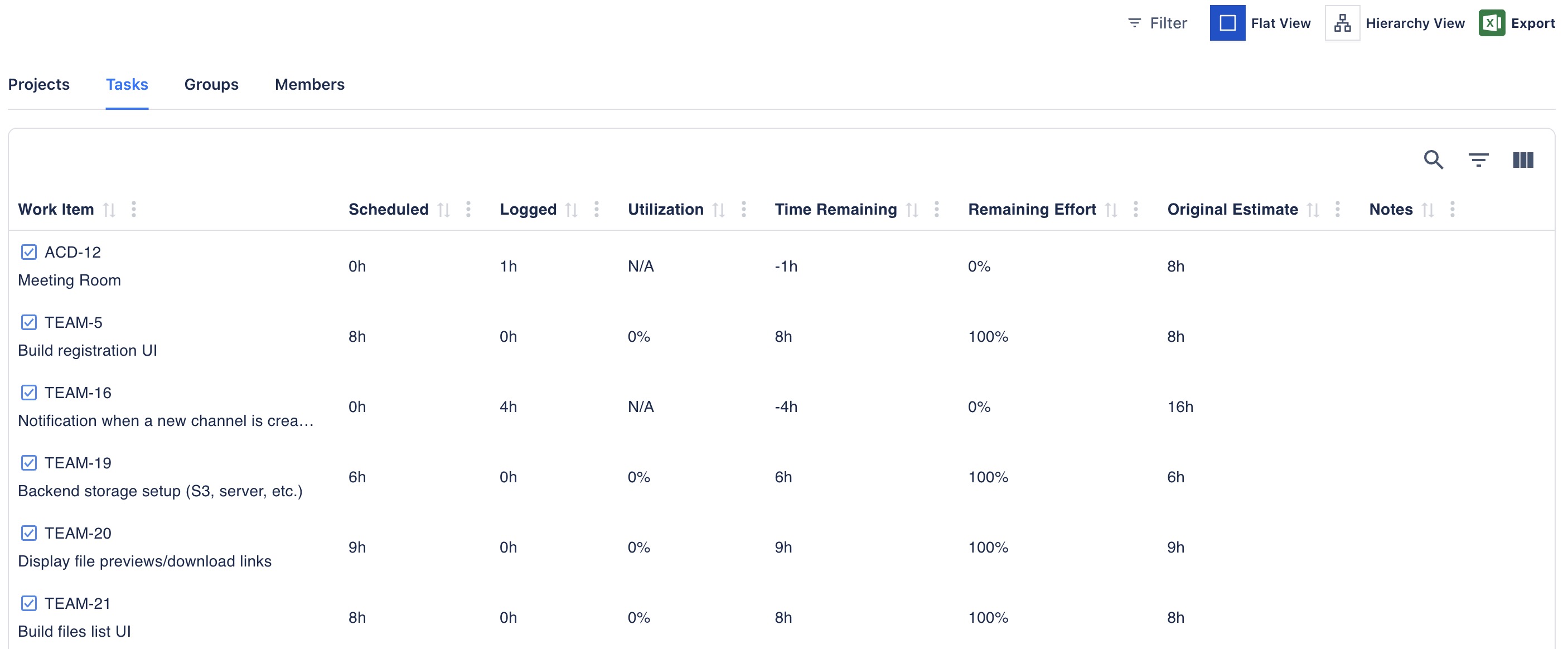

CleanShot 2026-07-27 at 17.11.31@2x-20260727-101138.jpg

Metric

Description

Scheduled

Total hours scheduled for the work item within the selected period.

Logged

Total hours logged for the work item.

Utilization

Percentage of scheduled time already logged:

Logged ÷ Scheduled × 100%

Time Remaining

Scheduled time that has not yet been logged:

Scheduled − Logged

Remaining Effort

Percentage of scheduled work still remaining:

Time Remaining ÷ Original Estimate × 100

Original Estimate

The original estimated effort from Jira.

Notes

Notes added to the work item.

Groups

The Groups tab summarizes workload and utilization for each resource group.

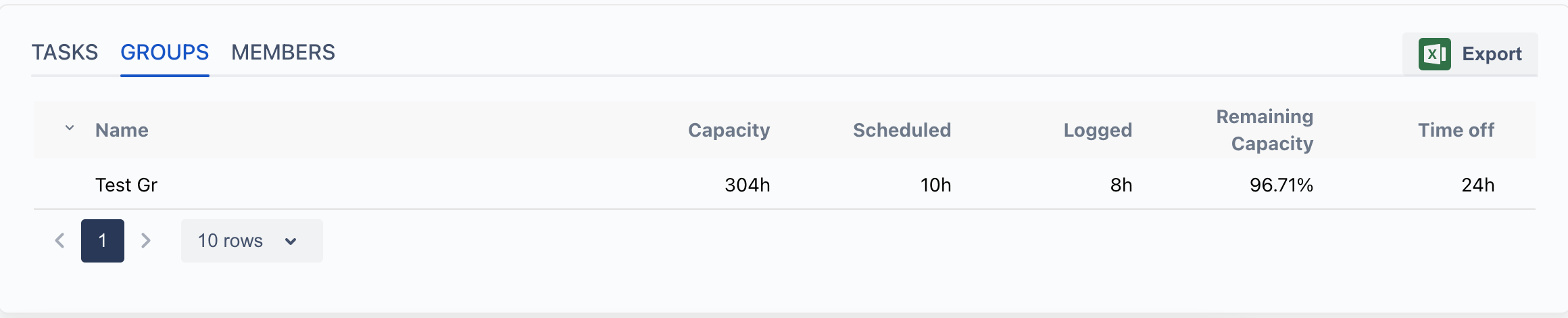

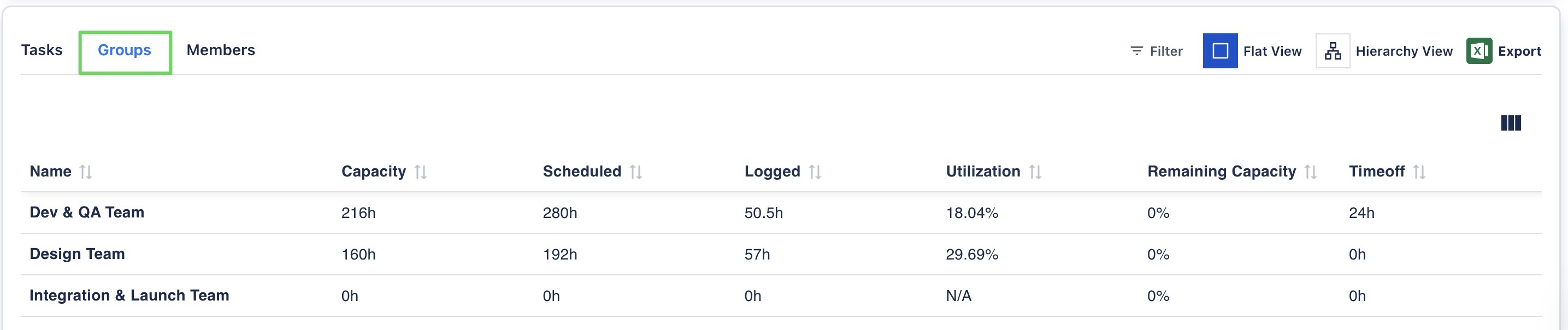

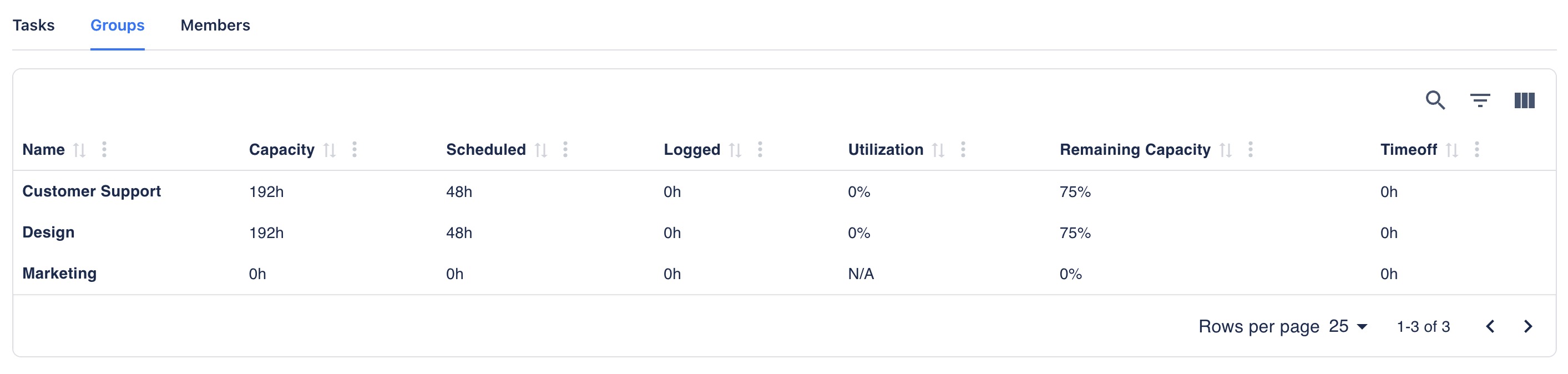

CleanShot 2026-07-27 at 14.52.47@2x-20260727-075252.jpg

Metric

Description

Capacity

Total available working hours for all members in the group.

Scheduled

Total scheduled hours assigned to members in the group.

Logged

Total hours logged by members in the group.

Utilization

Percentage of scheduled time already logged:

Logged ÷ Scheduled × 100%

Remaining Capacity

Percentage of group capacity still available:

(Capacity − Scheduled) ÷ Capacity × 100%

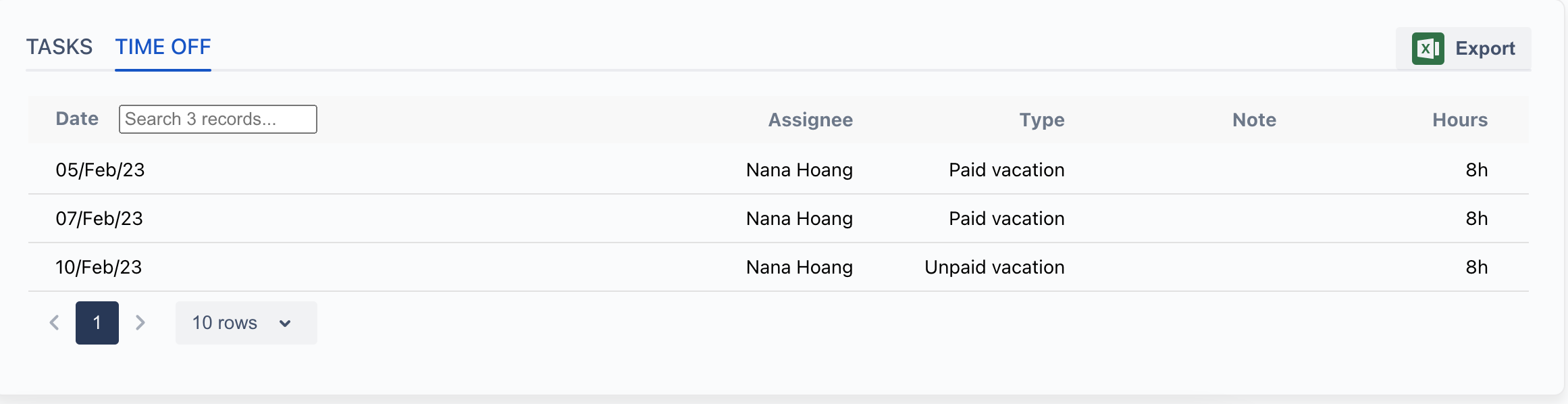

Time Off

Total time-off hours recorded for members in the group.

Members

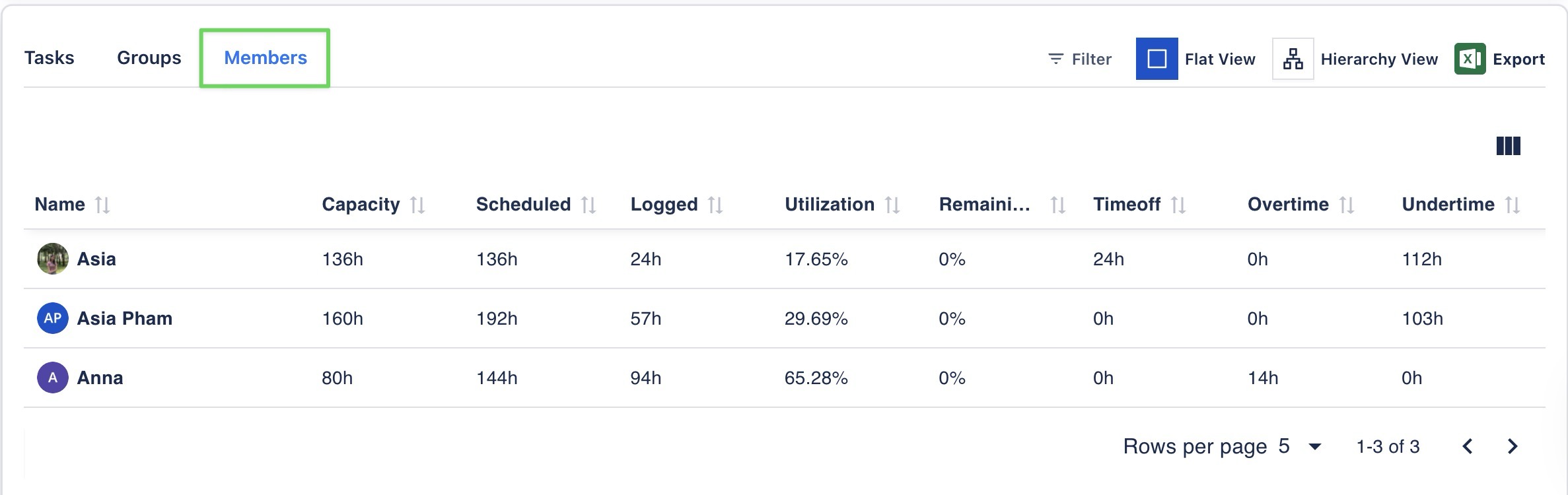

The Members tab displays workload statistics for each individual team member.

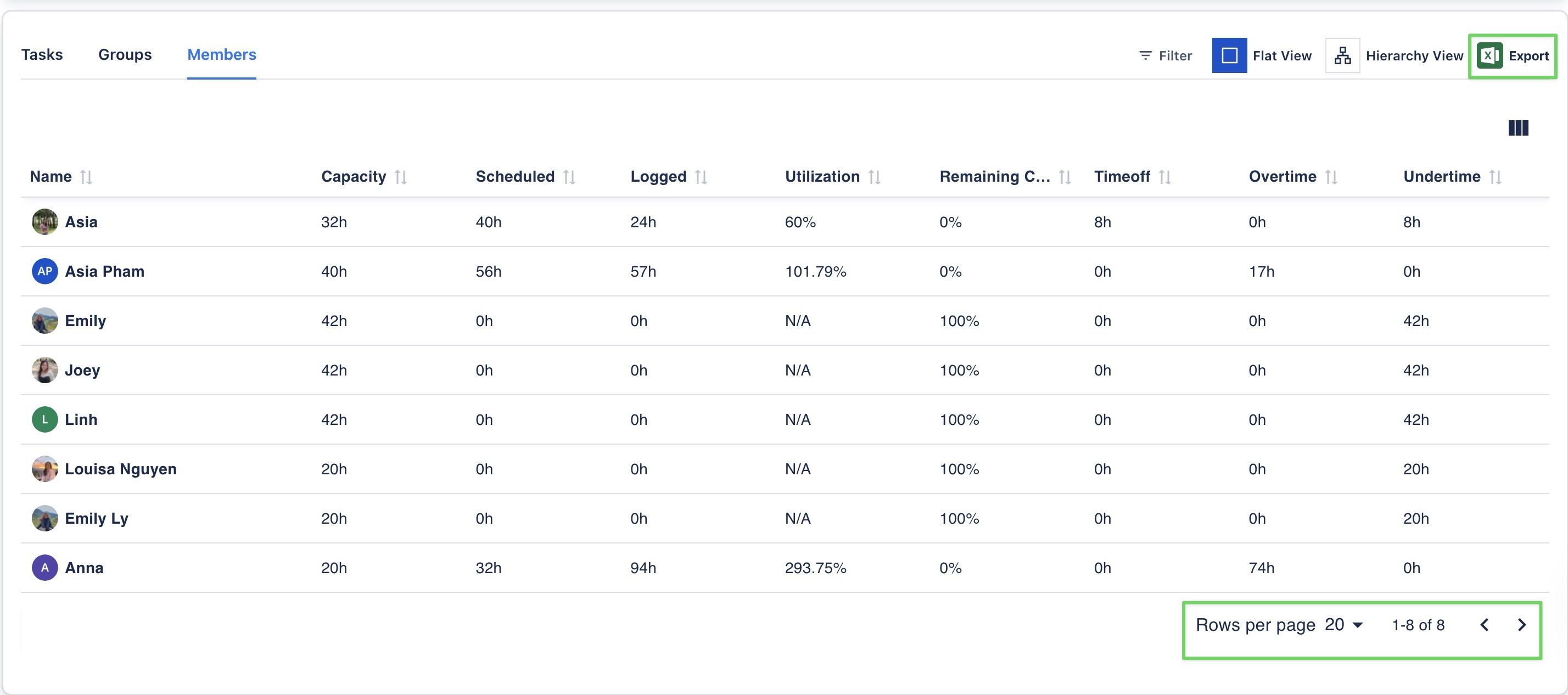

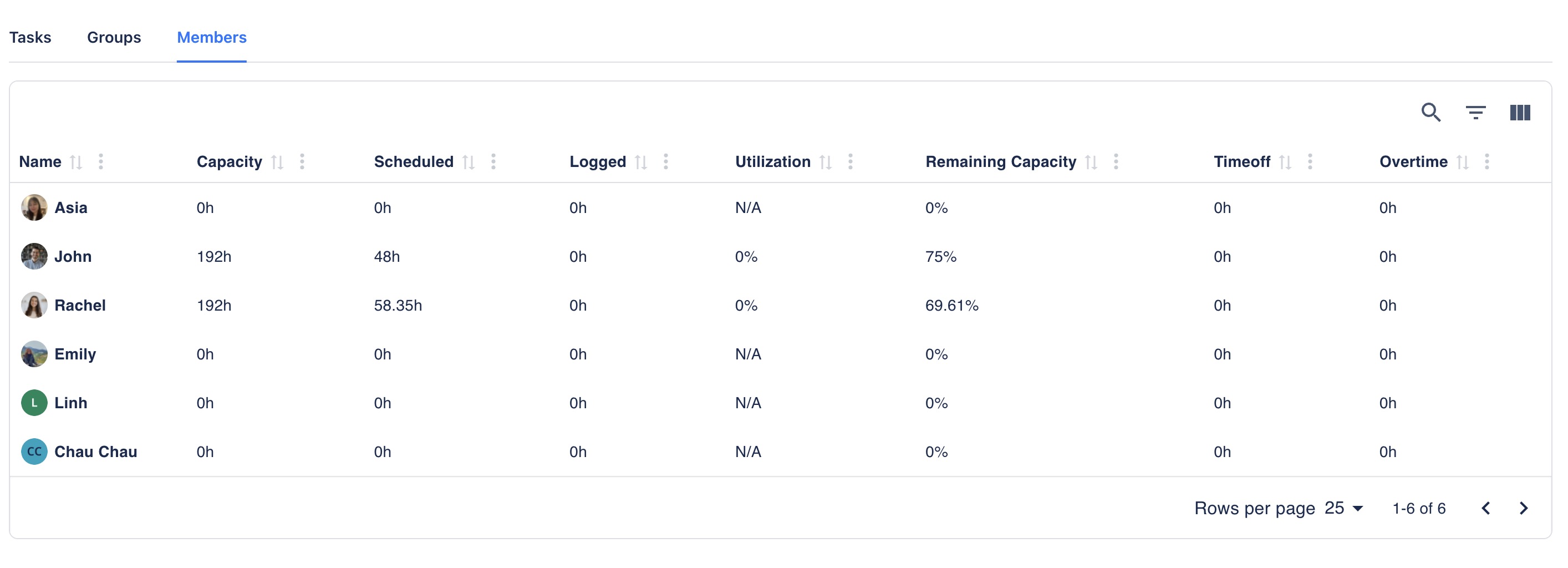

CleanShot 2026-07-27 at 17.24.25@2x-20260727-102428.jpg

Metric

Description

Capacity

Total available working hours for the member during the selected period.

Scheduled

Total scheduled hours assigned to the member.

Logged

Total hours logged by the member.

Utilization

Percentage of scheduled time already logged:

Logged ÷ Scheduled × 100%.

Remaining Capacity

Percentage of the member’s capacity still available:

(Capacity − Scheduled) ÷ Capacity × 100%

Time Off

Total time-off hours recorded for the member.

Overtime

Logged hours beyond the member’s capacity: Logged − Capacity, when the result is greater than 0.
