TeamBoard ProScheduler

Progress settings

How to access progress settings

In TeamBoard ProScheduler, task progress can be calculated using three methods, giving you flexibility at both the individual task and parent task levels.

To access the configuration:

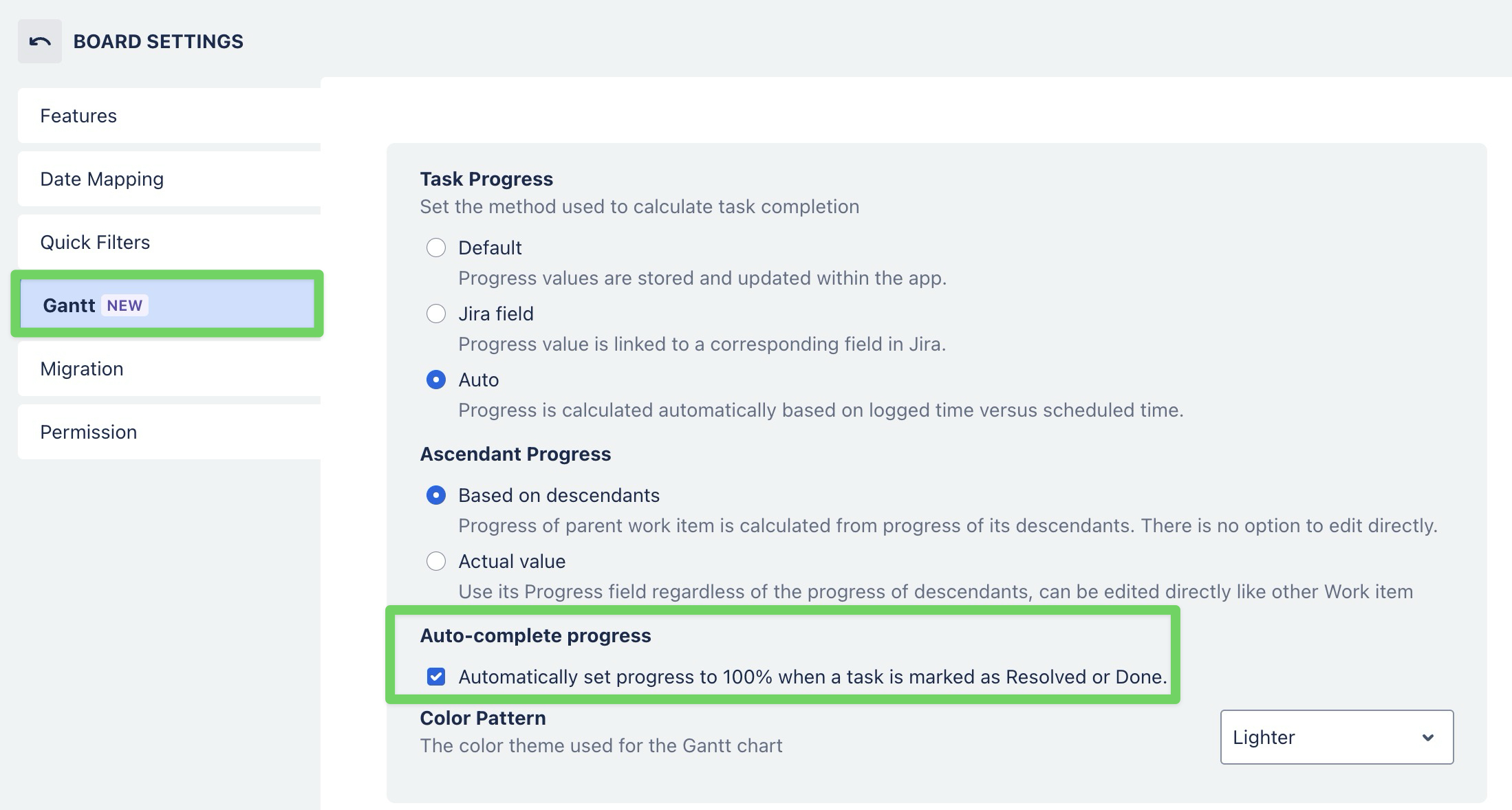

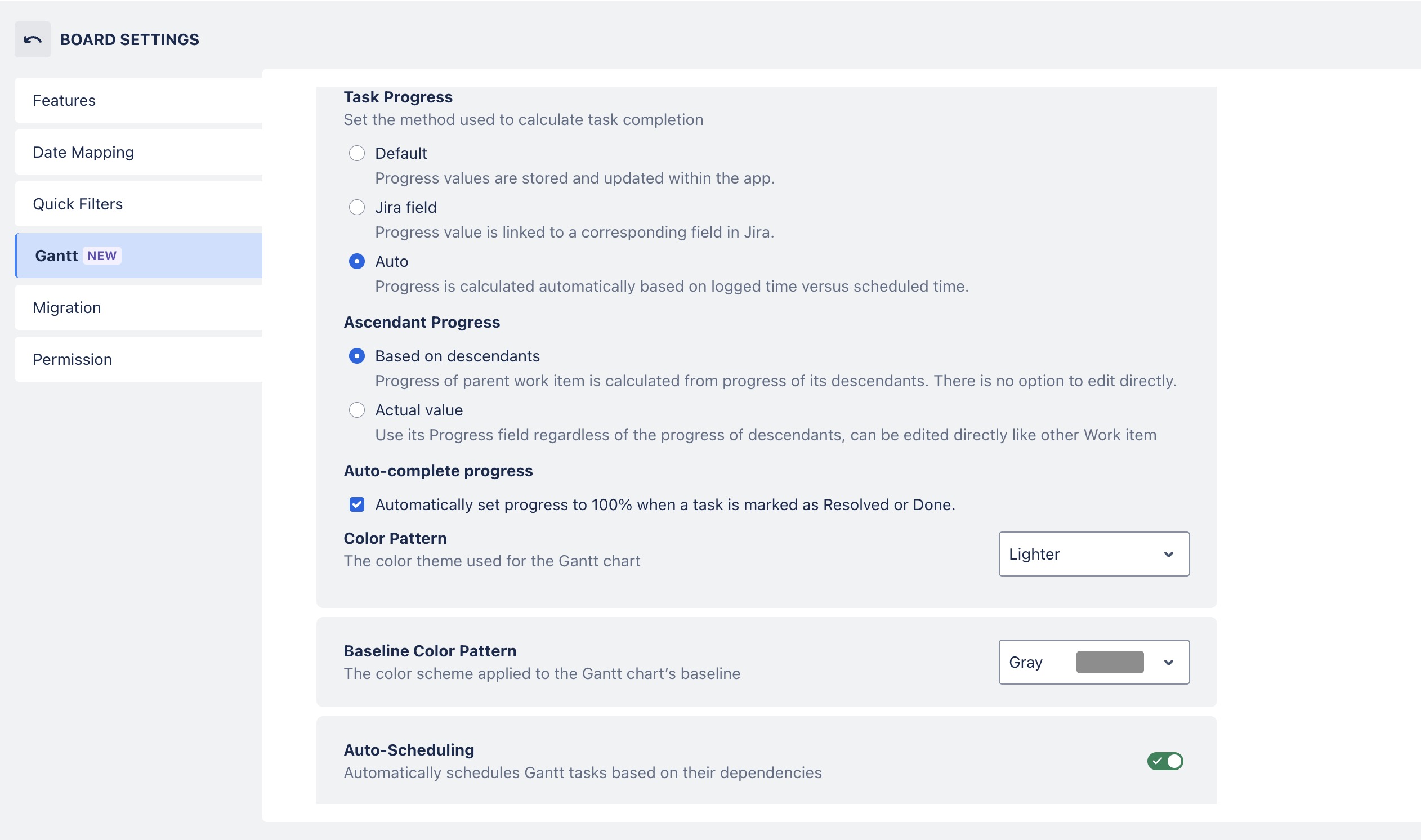

  1. Open your board in TeamBoard ProScheduler

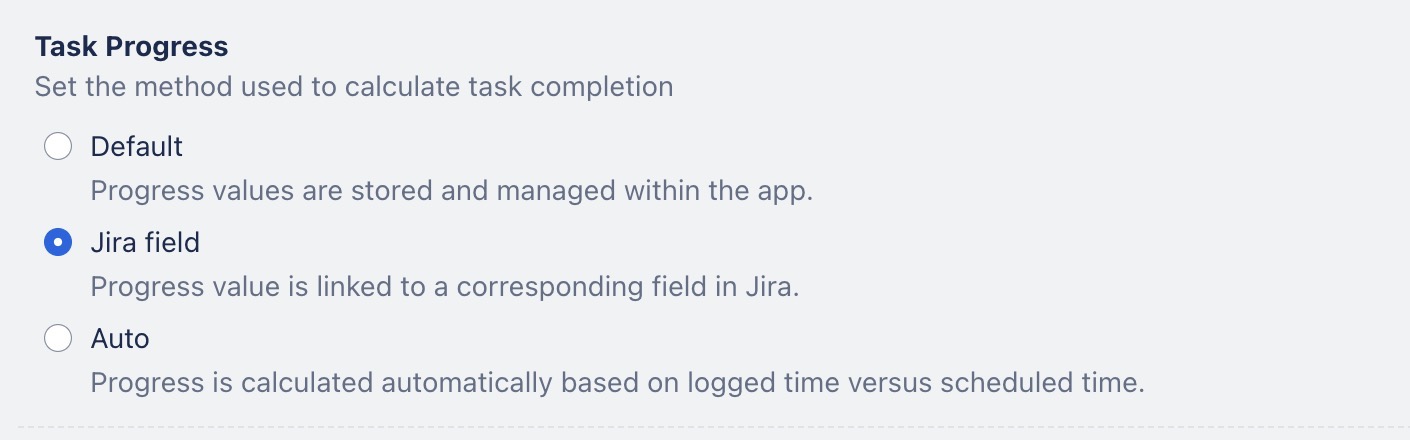

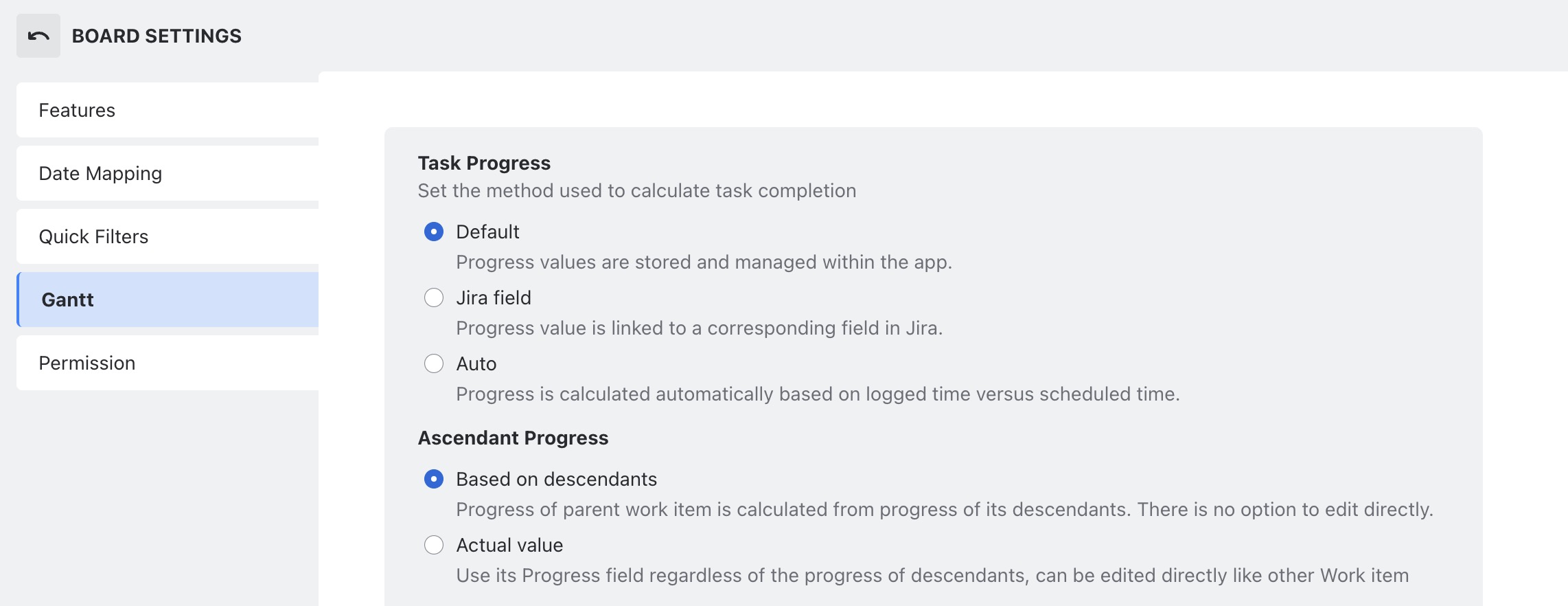

  2. Go to Board settings > Select Gantt

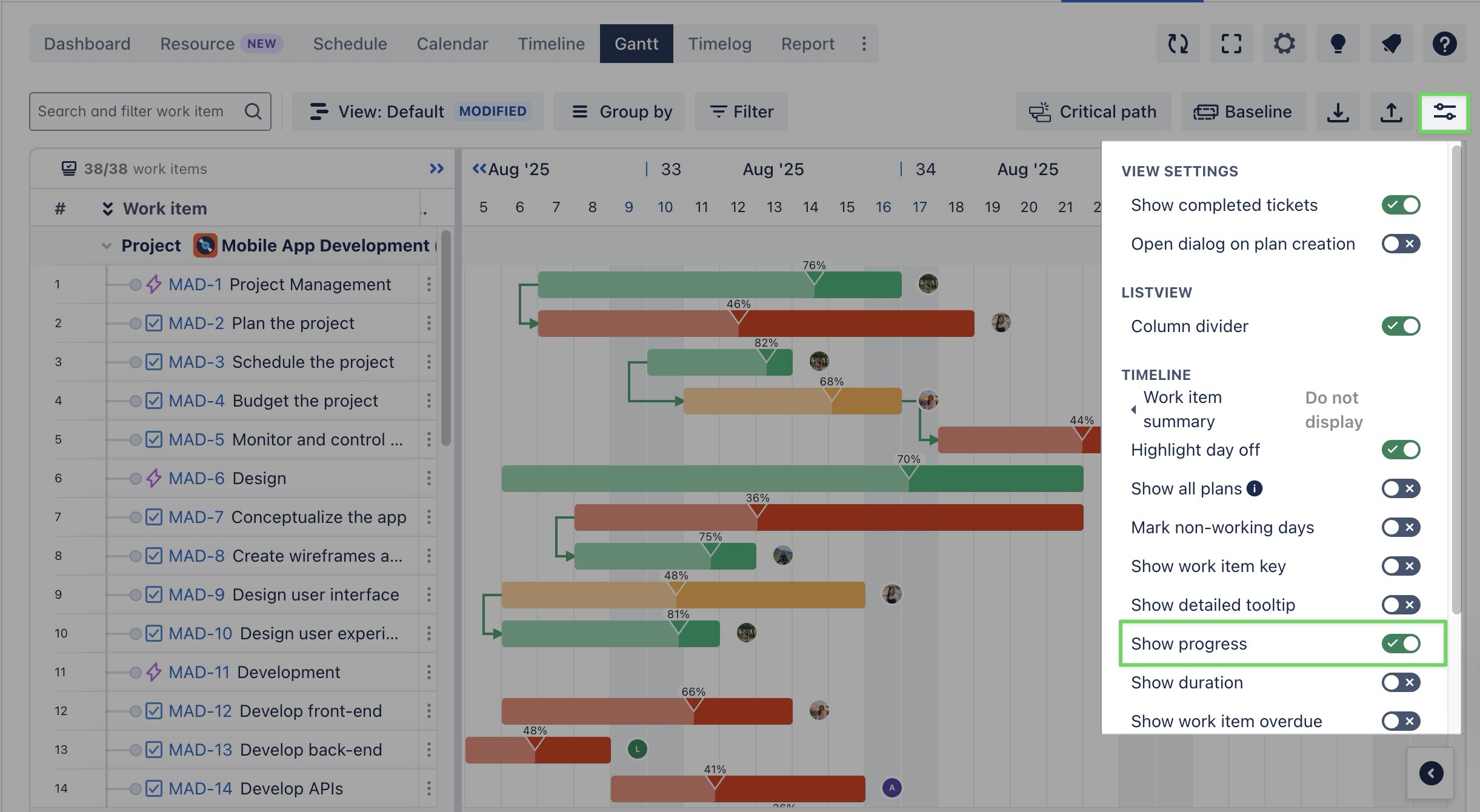

CleanShot 2025-12-19 at 10.23.34@2x-20251219-032340.jpg

What is task progress?

Task progress represents the percentage of completion for a specific task. It can be configured in several ways:

  1. Default: Users manually update task progress, giving them full control over the progress percentage.

  2. Jira Field: Task progress is automatically calculated based on values from a linked Jira field (e.g., Time Spent, Number fields).

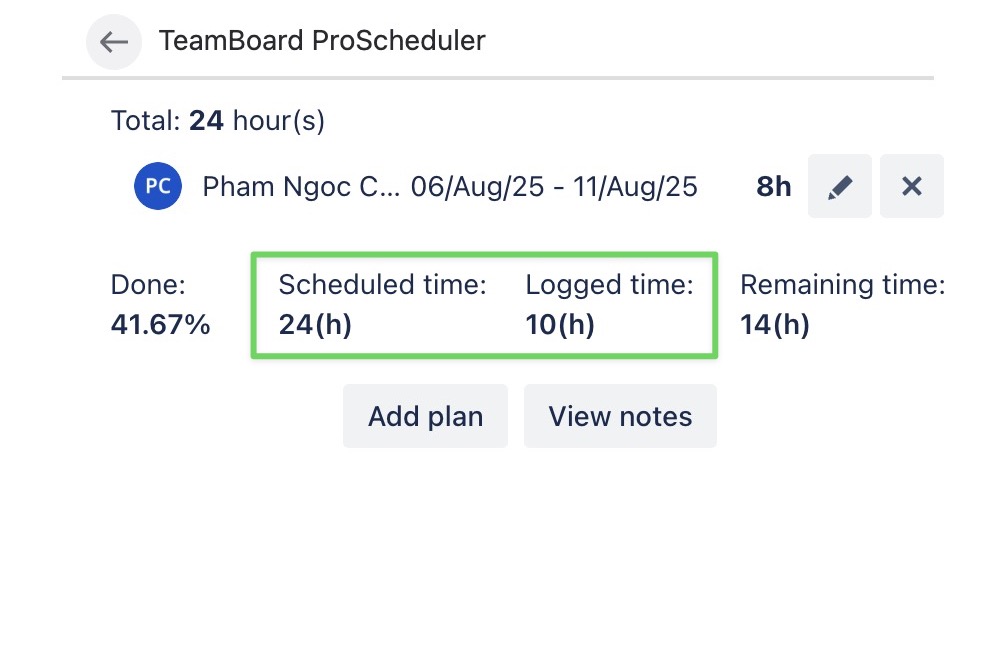

  3. Auto: Progress is automatically calculated by comparing the logged time to the scheduled time.

What is ascendant?

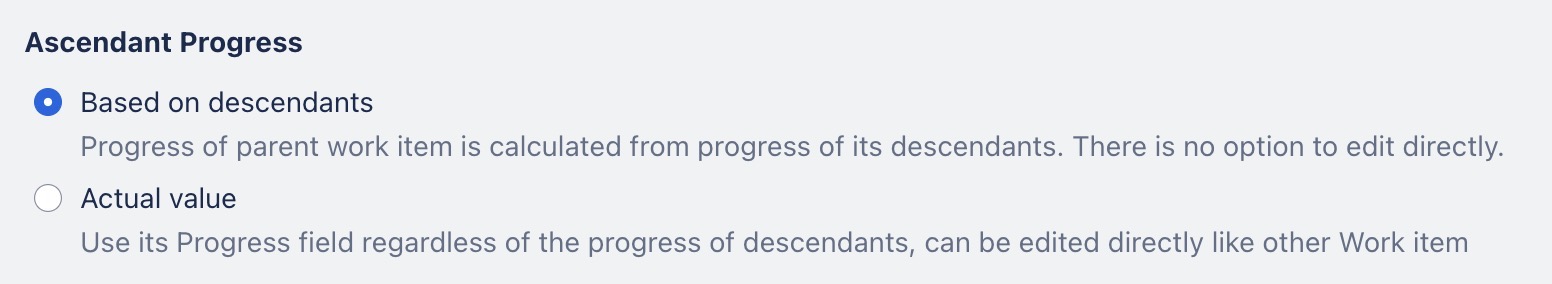

An ascendant is a parent or higher-level task within a hierarchy that includes or oversees descendant (child) tasks. There are two options for calculating its progress:

Based on descendants

  • The progress of the ascendant task is automatically calculated based on the progress of its descendant tasks.

  • The progress of the ascendant task cannot be edited directly; it updates automatically as the descendant tasks are updated.

Based on actual value

  • The parent task's progress is determined by its own progress field, regardless of the progress of its descendant tasks.

How to configure task progress

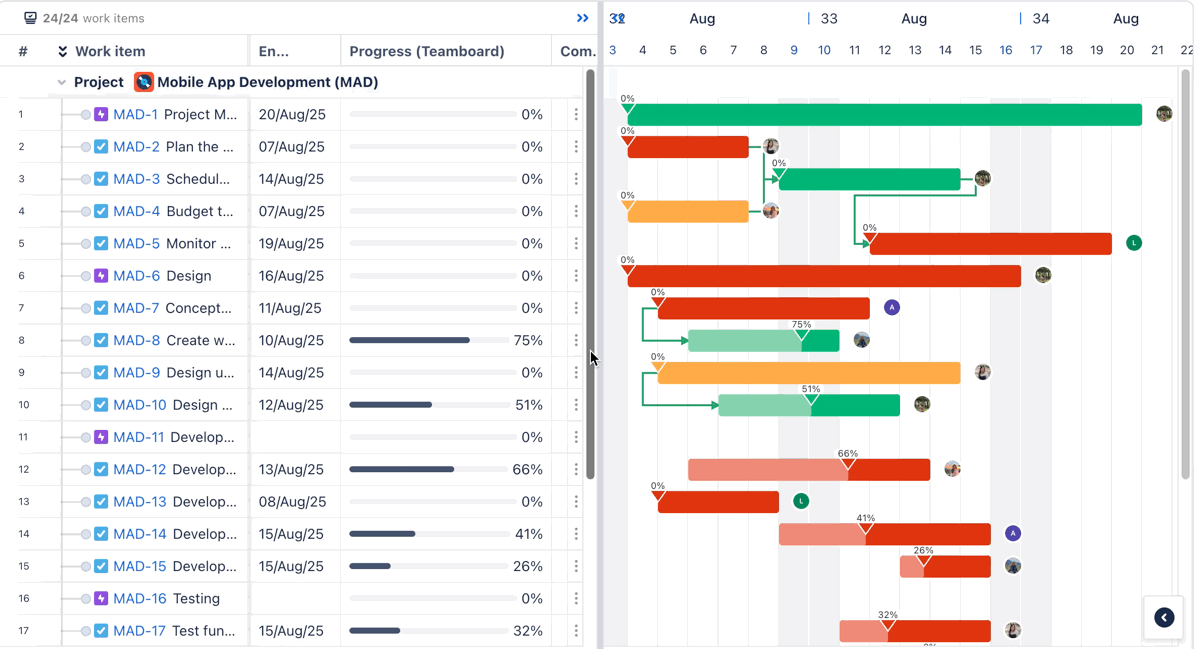

option 1 Default

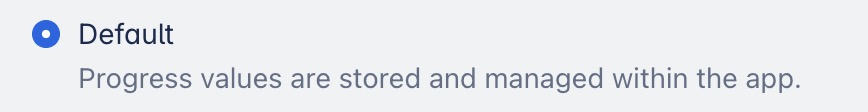

Default

Based on descendants

Task Progress

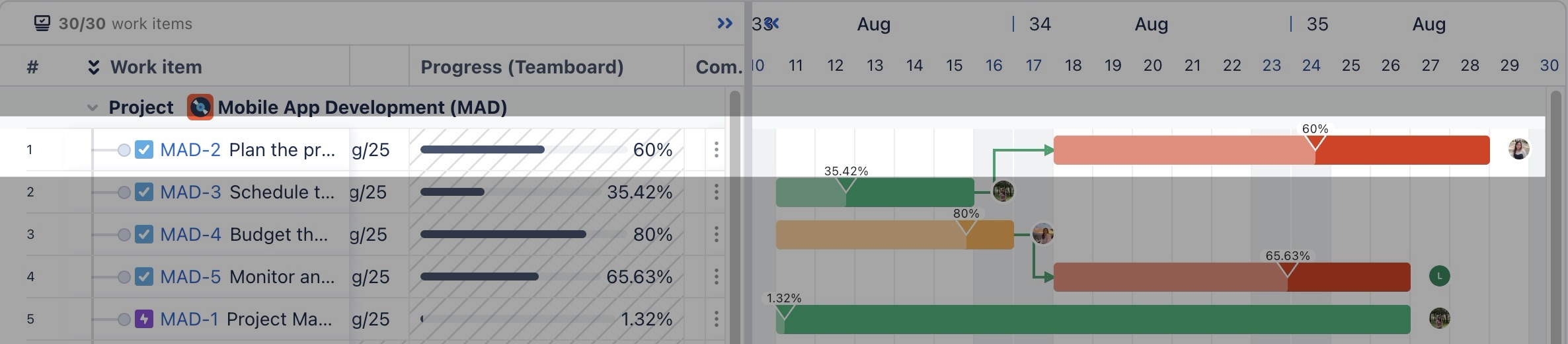

  1. You can drag the progress slider directly on the taskbar in the Gantt chart to visually adjust the completion percentage.

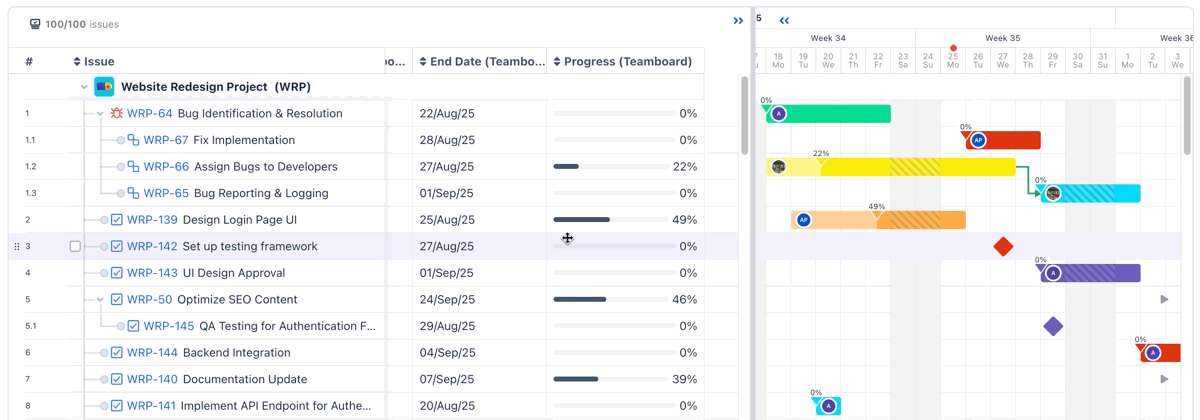

CleanShot 2025-12-19 at 11.10.52-20251219-041110.gif

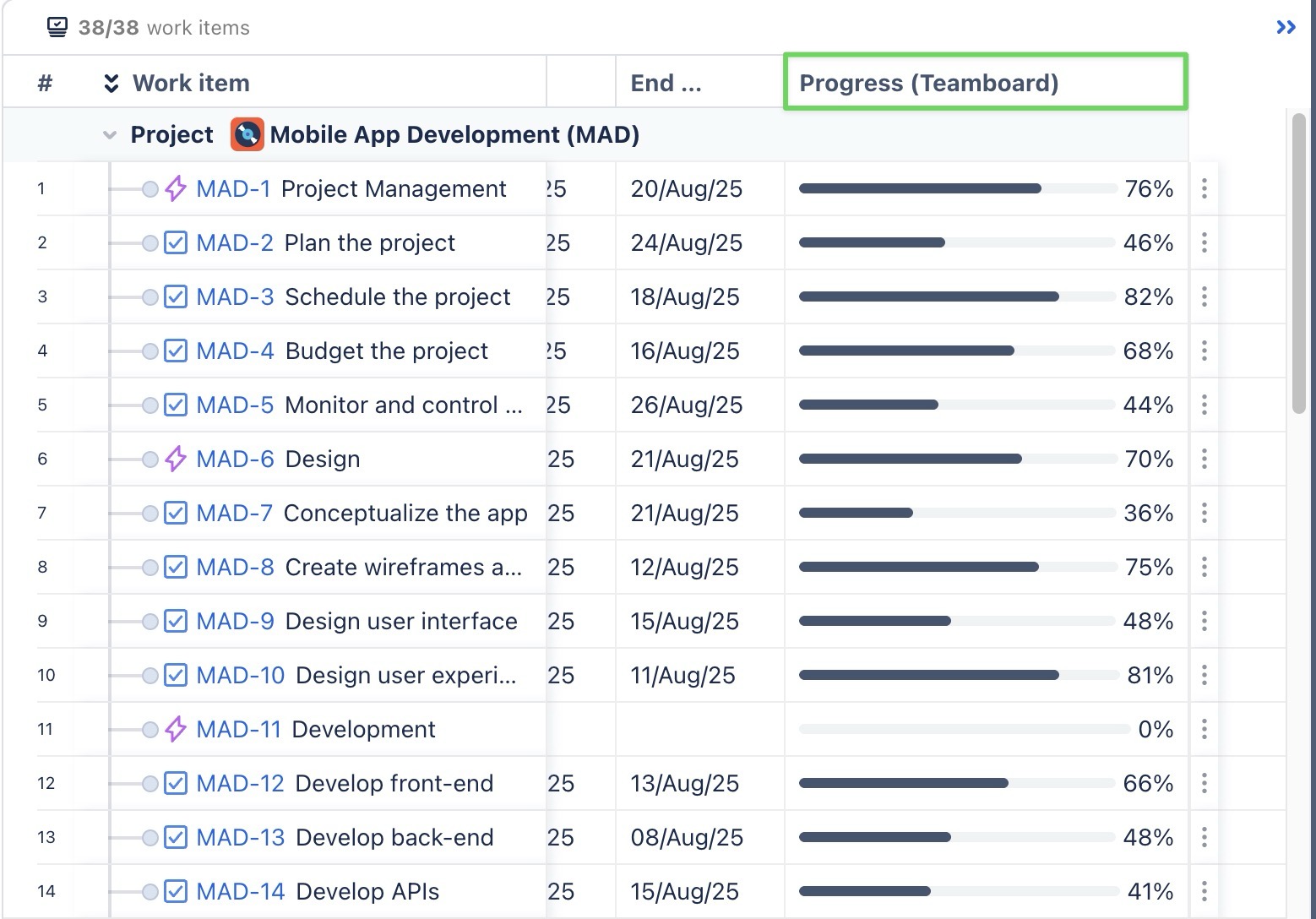

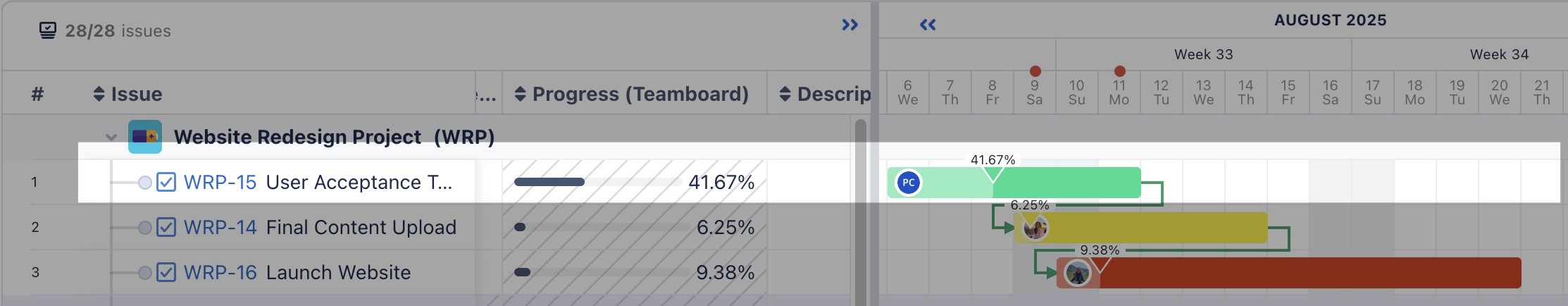

  1. You can type the progress number directly in the Progress (Teamboard) column from the table view.

CleanShot 2025-12-19 at 11.08.57-20251219-040920.gif

Ascendant Progress

  • Cannot be edited directly — the parent task’s progress is updated automatically as descendant (child) tasks change.

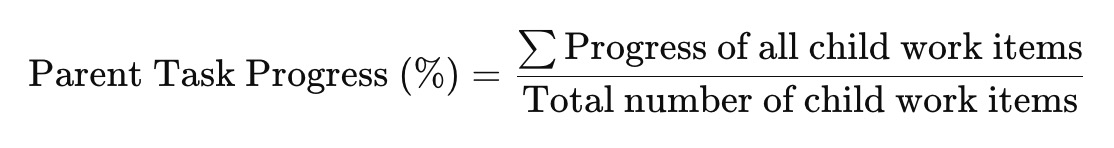

  • Parent progress = average progress of all child work items.

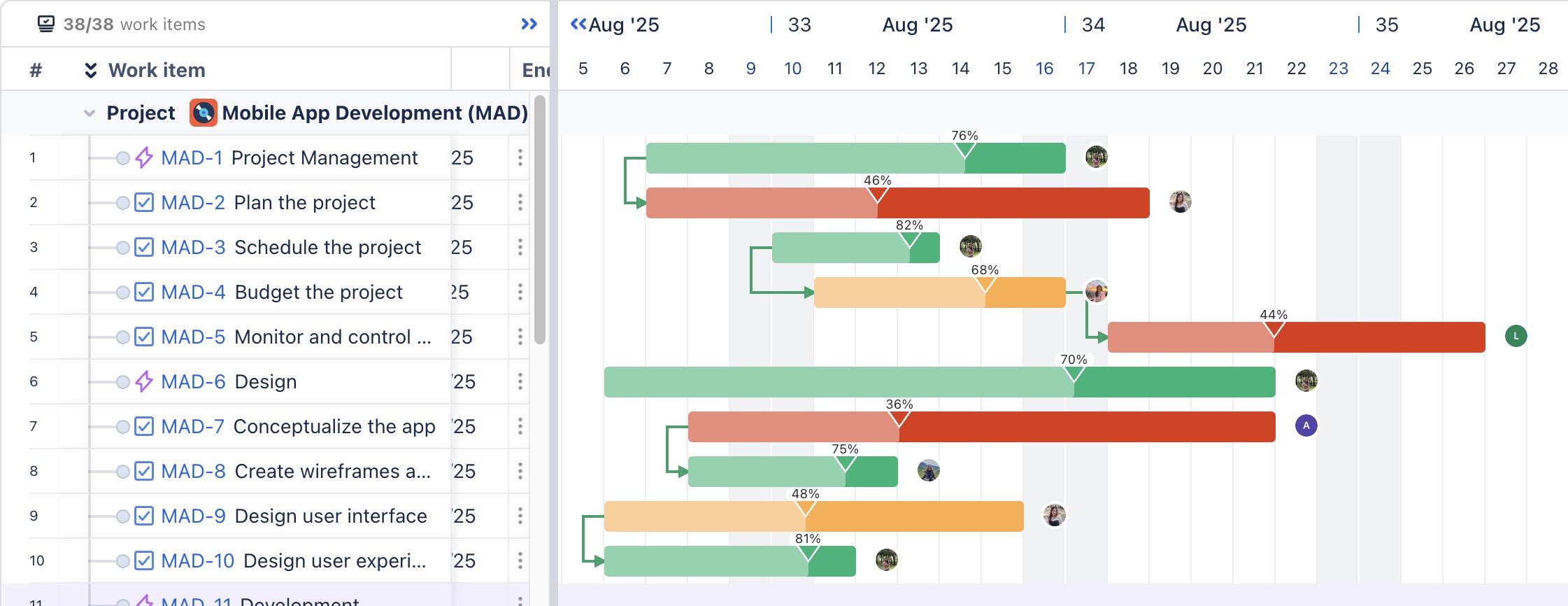

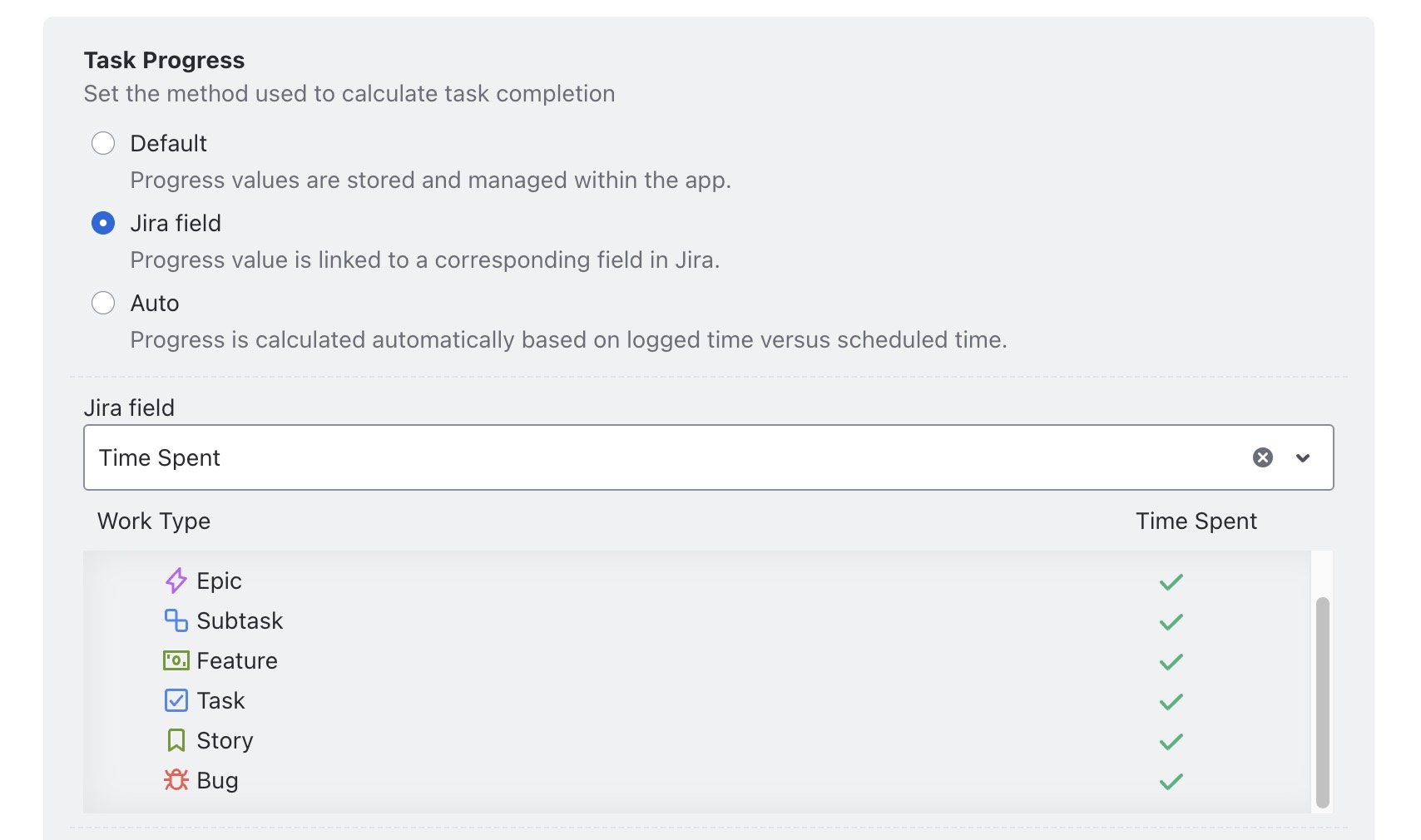

CleanShot 2025-12-21 at 00.05.52@2x-20251220-170558.jpg
Example
CleanShot 2025-12-21 at 01.10.35@2x-20251220-181051.jpg

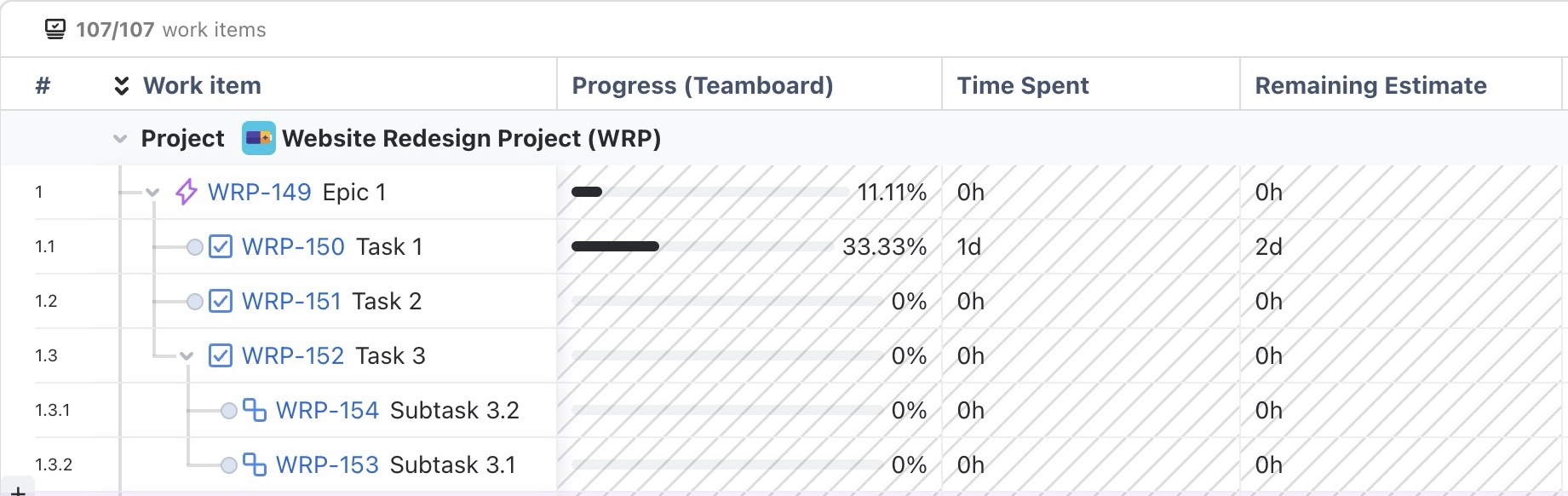

Epic 1 Progress

  • Task 1: 33.33%

  • Task 2: 25%

  • Task 3: 68.75%

→ Epic 1 Progress = (33.33%+ 25%+ 68.75%) / 3 = 42.36%

Task 3 Progress

  • Subtask 3.2: 100%

  • Subtask 3.1: 37.5%

→ Task 3 Progress = (100% + 37.5%) 2 = 68.75%

Actual value

Ascendant progress

  • This behavior is the same as the Default option for task progress.

  • The parent task’s progress is determined by its own progress field and is independent of the progress of its descendant (child) tasks.

option 2 Jira field

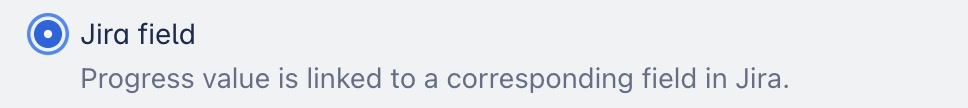

TeamBoard ProScheduler allows automated task progress calculation using the Jira Field option, ensuring TeamBoard stays fully in sync with actual Jira values.

This option supports two main types of linked Jira fields:

  1. Number Field (0–100)

You can link a Jira custom number field (with values from 0 to 100) to represent the percentage of task completion. Any updates made in Jira or by dragging the progress slider in the Gantt chart are reflected immediately.

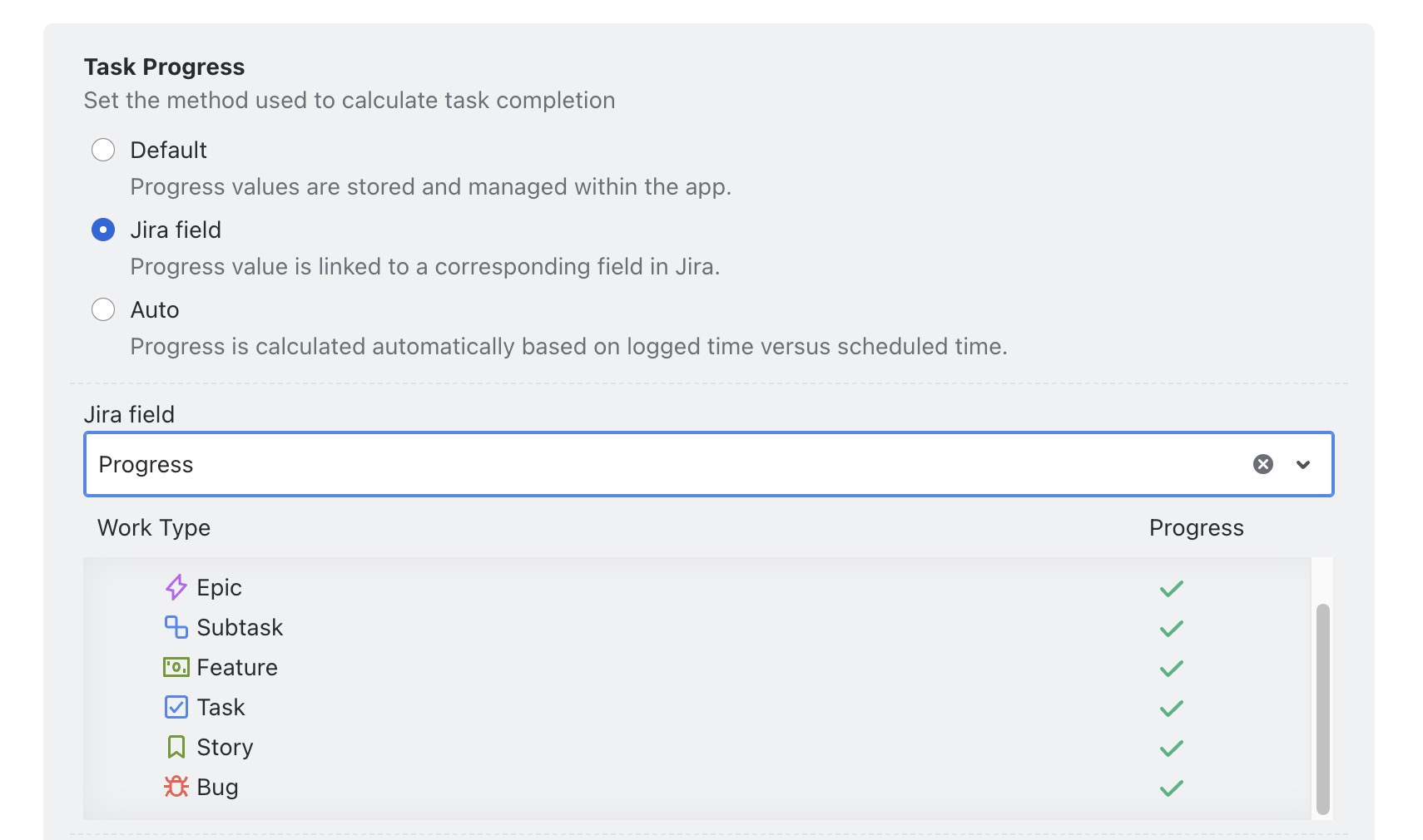

CleanShot 2025-12-20 at 22.28.52@2x-20251220-152901.jpg

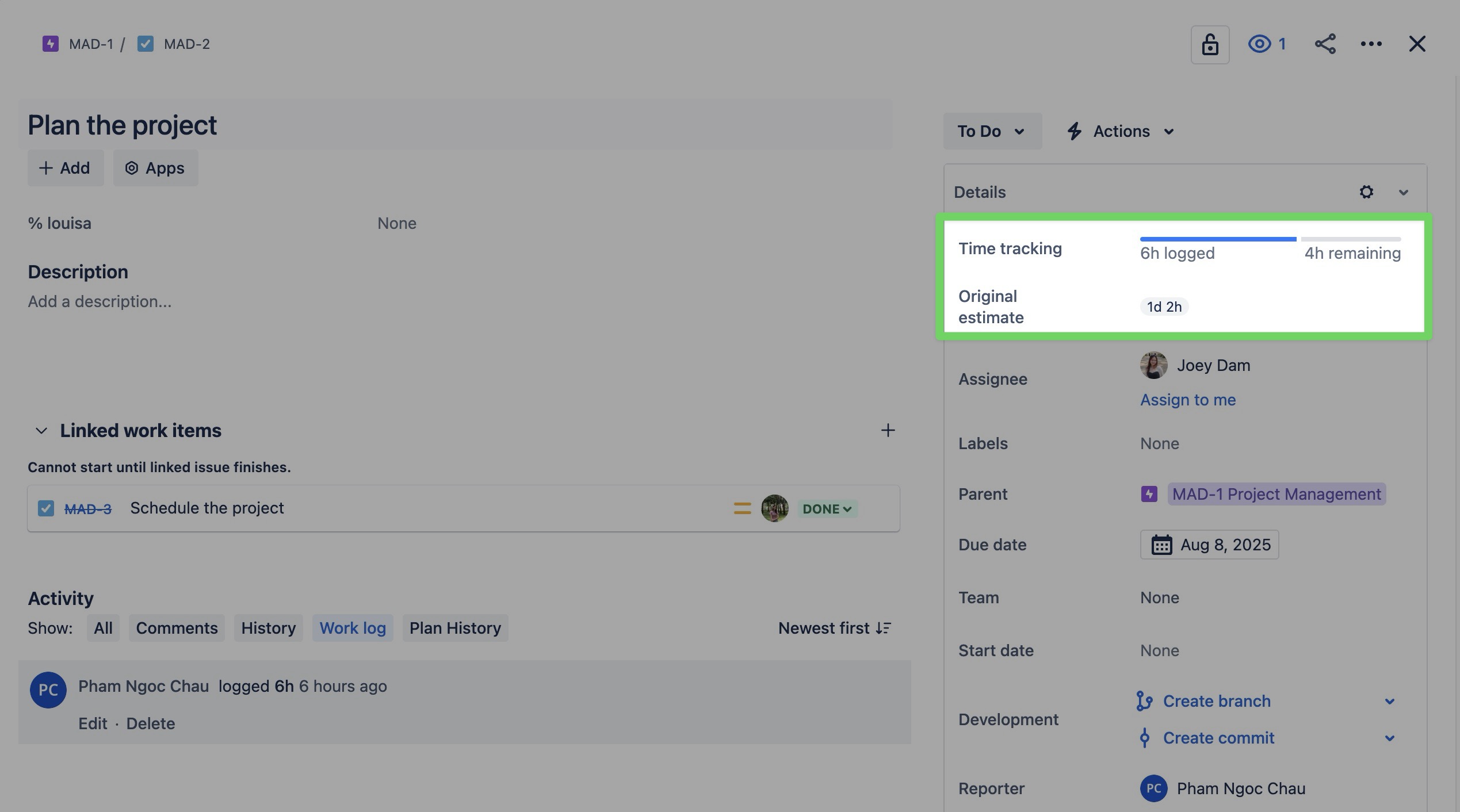

  1. Time Tracking (Time Spent)

TeamBoard can also calculate progress using Jira’s native Time Spent field. This ensures progress is always calculated accurately based on real work logged in Jira.

CleanShot 2025-12-20 at 22.29.54@2x-20251220-153004.jpg

Jira field

Based on descendants

Number field

You can easily update the progress by entering a number (0-100) in the Jira number field, or by hovering over the progress bar and dragging the slider.

CleanShot 2025-12-20 at 22.39.13-20251220-153952.gif

Time Spent

Task Progress

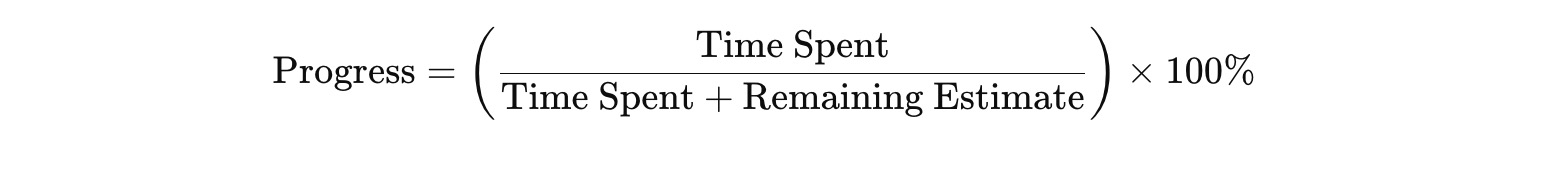

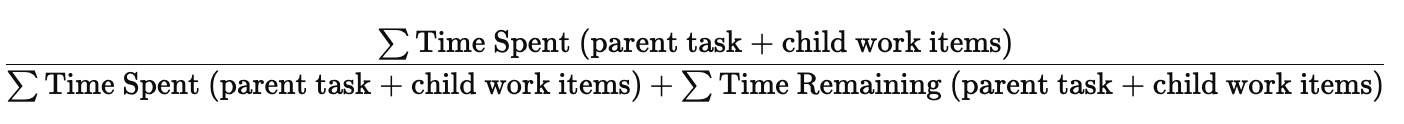

  • Progress is calculated automatically using the formula:

CleanShot 2025-07-15 at 09.54.27@2x-20250715-025433.jpg
Example:
CleanShot 2025-12-20 at 23.30.49@2x-20251220-163111.jpg

Task 1 has:

  • Time Spent: 1 day

  • Time Remaining: 2 days

→ Progress calculation: 1 ÷ (1 + 2) = 33.33%

Ascendant Progress

case 1 Parent task does NOT have Time Spent / Time Remaining

CleanShot 2025-12-21 at 00.05.52@2x-20251220-170558.jpg

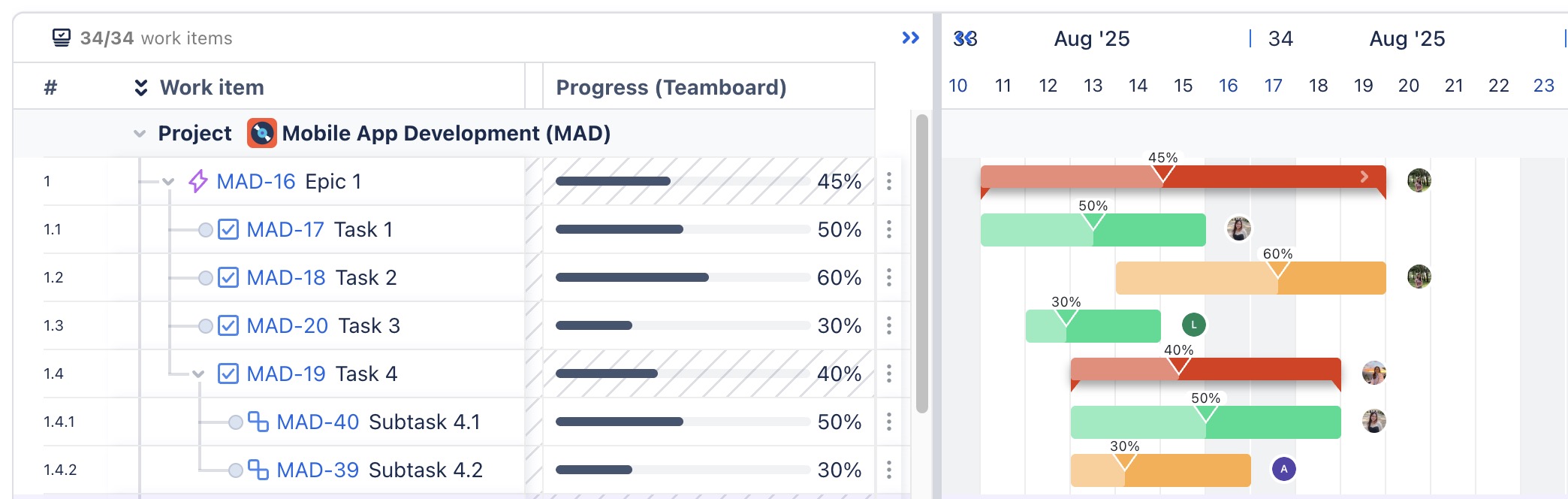

Example
CleanShot 2025-12-20 at 23.53.27@2x-20251220-171338.jpg

Epic 1 has:

  • Task 1: 33.33%

  • Task 2: 50%

  • Task 3: 55.17%

→ Progress of Epic 1 = (33.33 + 50 + 55.17) / 3 = 46.17%

case 2 Parent task has Time Spent / Time Remaining

→ Parent task Progress:

CleanShot 2025-12-21 at 00.16.57@2x-20251220-171705.jpg
Example

example 1 Epic 1 includes itself and its child work items:

CleanShot 2025-12-21 at 00.20.12@2x-20251220-174606.jpg
  • Total Time Spent = 3d6h + 1d + 1d + 5h + 1d + 3h = 7d 6h

  • Total Time Remaining = 1d2h + 2d + 1d + 3h + 1d + 2h = 5d 7h

→ Epic 1 Progress (%) = 7d 6h / (7d 6h + 5d 7h) = 56.88%

example 2 Task 3 includes itself and its child work items:

CleanShot 2025-12-21 at 00.20.12@2x-20251220-174918.jpg
  • Total Time Spent = 5h + 1d + 3h = 2d

  • Total Time Remaining = 3h + 1d + 2h = 1d 5h

→ Task 3 Progress (%) = 2d / (2d + 1d 5h) = 55.17%

Actual value

Ascendant progress

  • This behavior is the same as the Jira Field option for task progress.

  • The parent task’s progress is determined by its own progress field and is independent of the progress of its descendant (child) tasks.

option 3 Auto

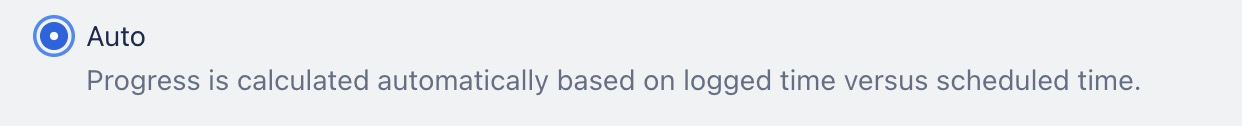

Auto

Based on descendants

Task Progress

  • Progress is calculated automatically using the formula:

CleanShot 2025-07-15 at 13.32.15@2x-20250715-063218.jpg

Example

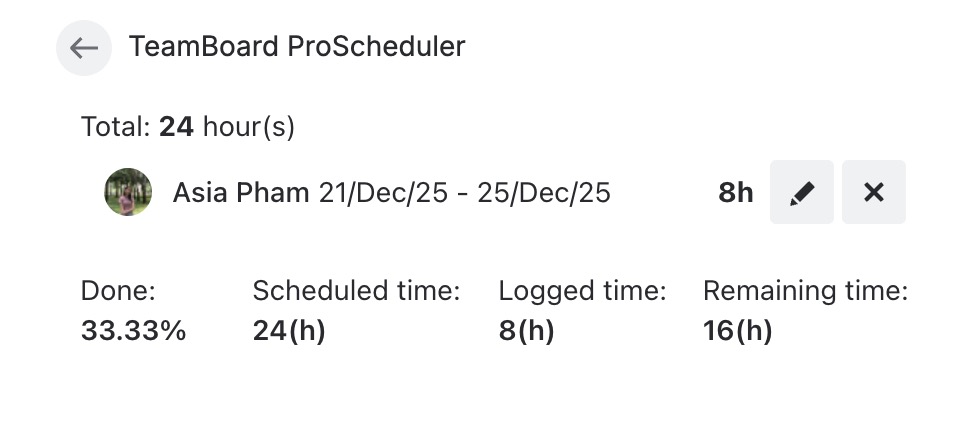

Task 1 Progress = 8 / 24 = 33.33%

CleanShot 2025-12-21 at 01.13.43@2x-20251220-181348.jpg

Ascendant progress

  • Cannot be edited directly — the parent task’s progress is updated automatically as descendant (child) tasks change.

  • Parent progress = average progress of all child work items.

CleanShot 2025-12-21 at 00.05.52@2x-20251220-170558.jpg
Example

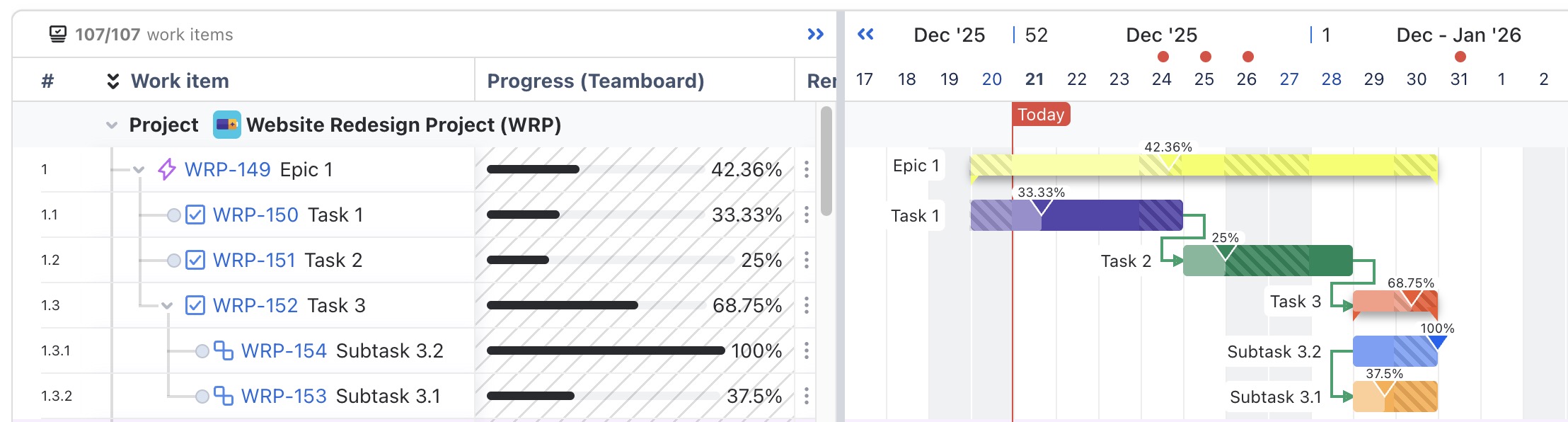

CleanShot 2025-12-21 at 01.10.35@2x-20251220-181051.jpg

Epic 1 Progress

  • Task 1: 33.33%

  • Task 2: 25%

  • Task 3: 68.75%

→ Epic 1 Progress = (33.33%+ 25%+ 68.75%) / 3 = 42.36%

Task 3 Progress

  • Subtask 3.2: 100%

  • Subtask 3.1: 37.5%

→ Task 3 Progress = (100% + 37.5%) 2 = 68.75%

Actual value

Ascendant progress

  • This behavior is the same as the Auto option for task progress.

  • The parent task’s progress is determined by its own progress field and is independent of the progress of its descendant (child) tasks.
