Updating Plans

For the existing plans scheduled on the TimePlanner board, you can:

  • To update other member's plans, users need both ‘View team schedules’ and ‘Manage team schedule’ in Team Permission.

  • Assigning a plan to multiple assignees is not available for Jira Field Mapping projects.

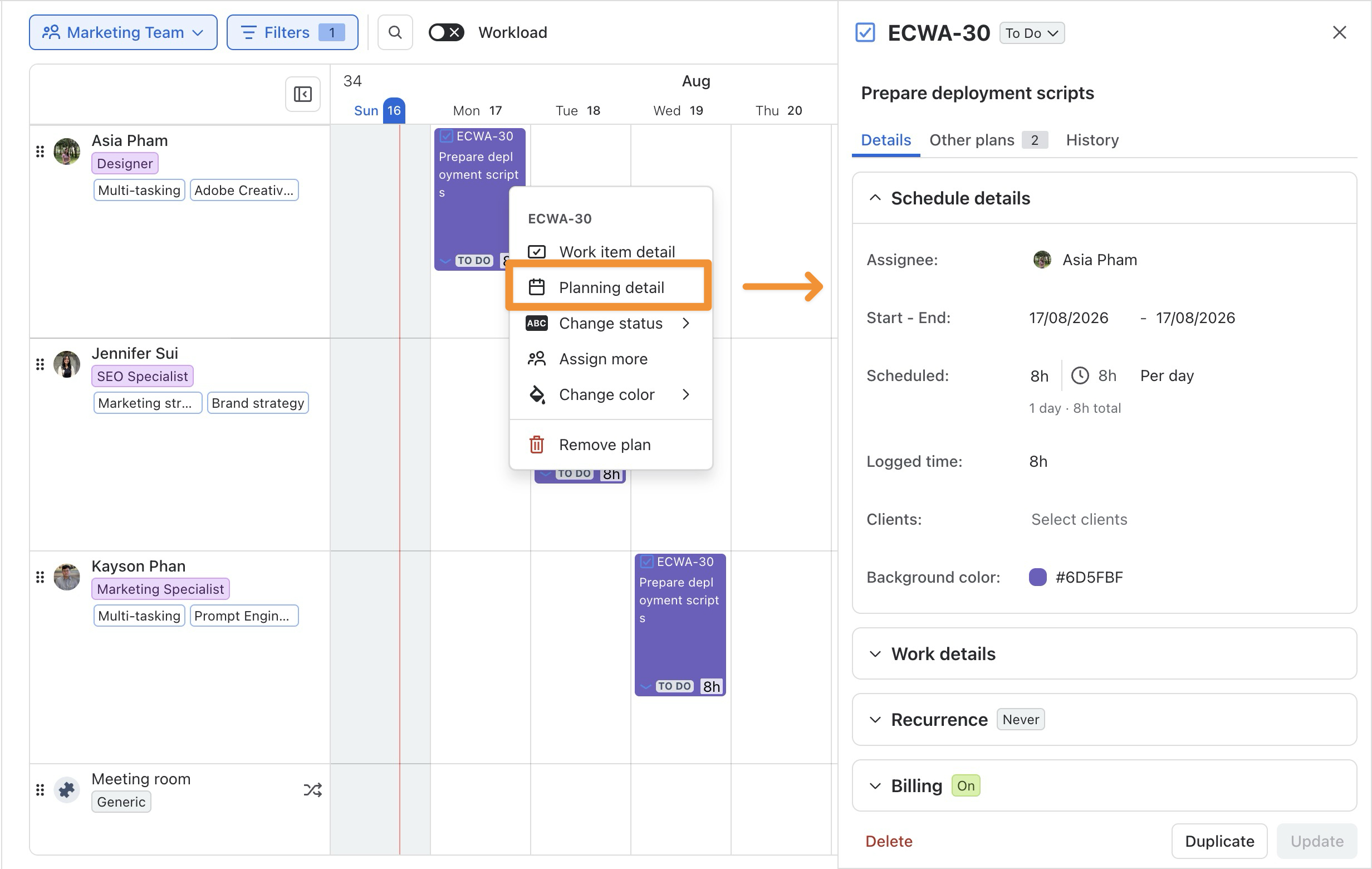

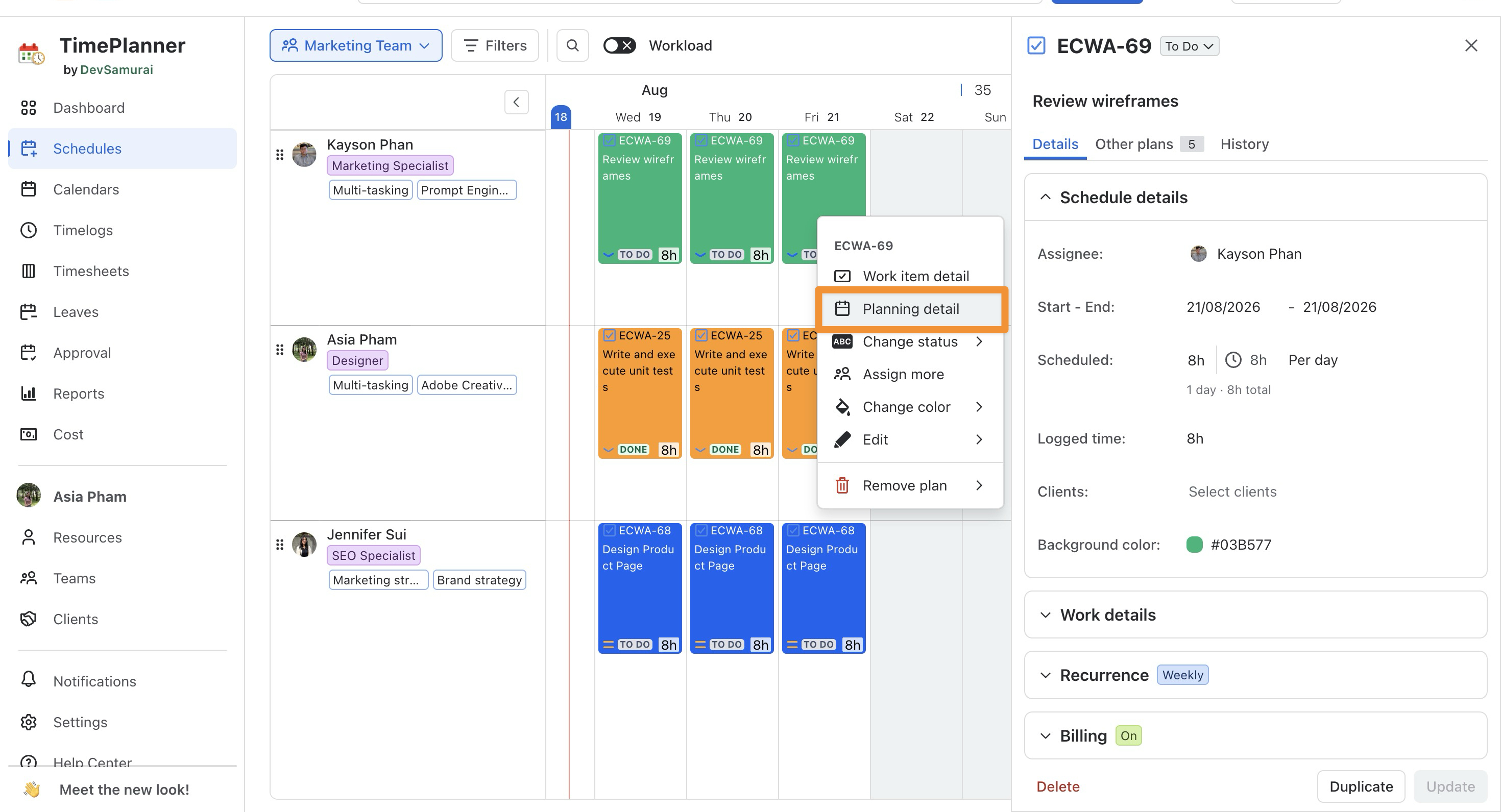

To open the Planning Details:

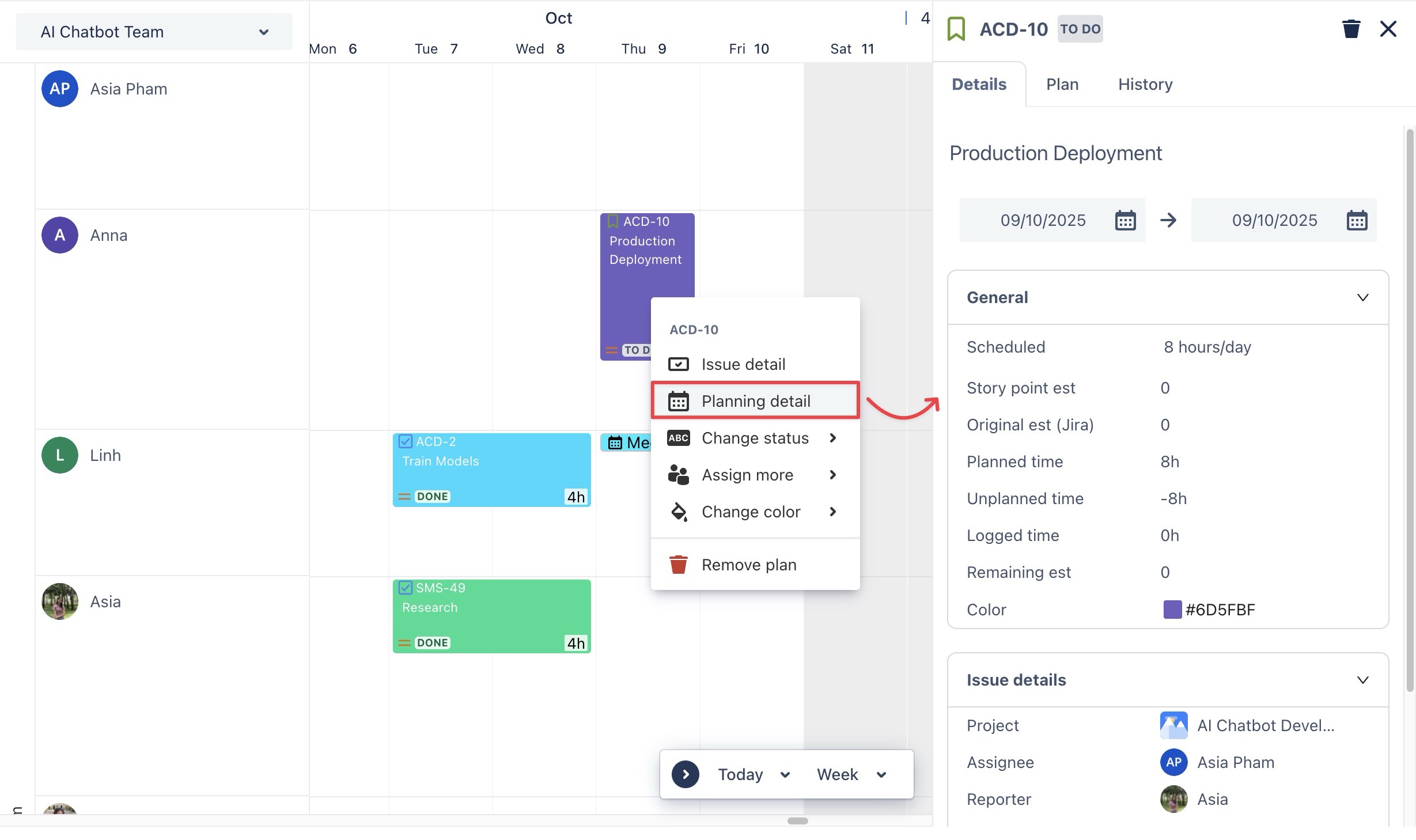

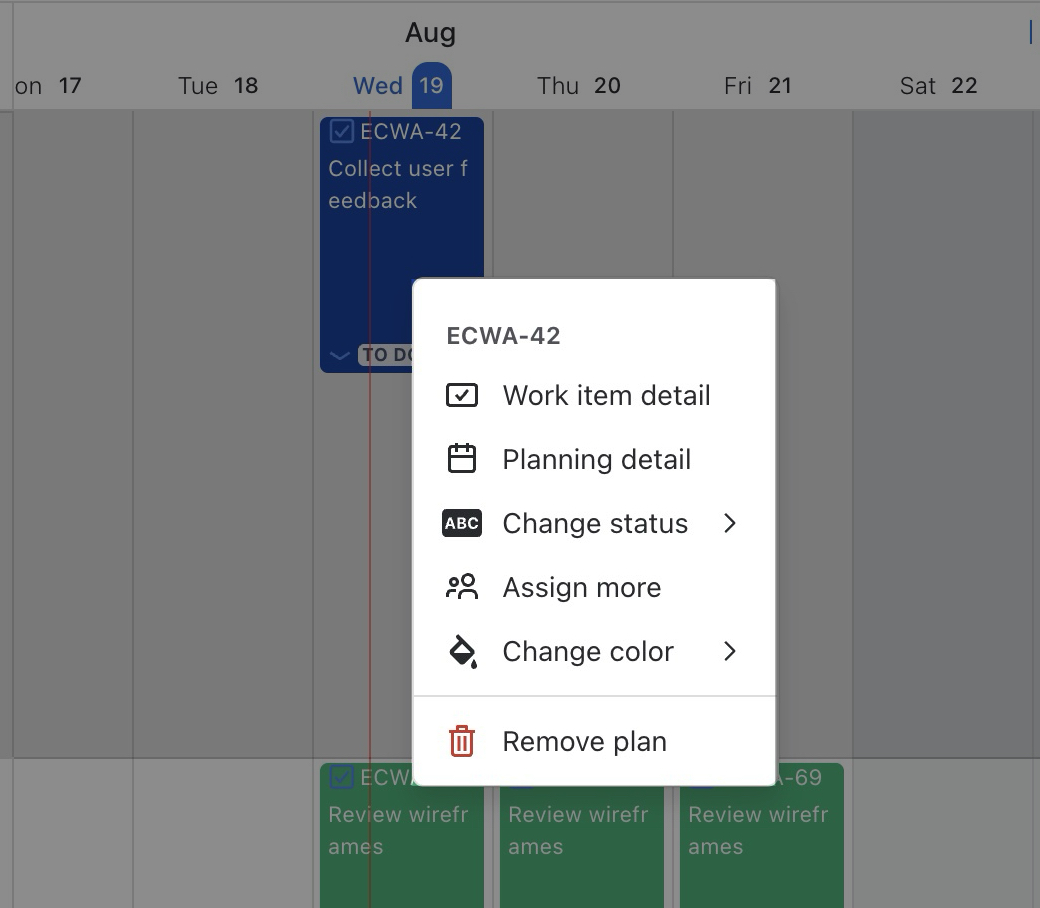

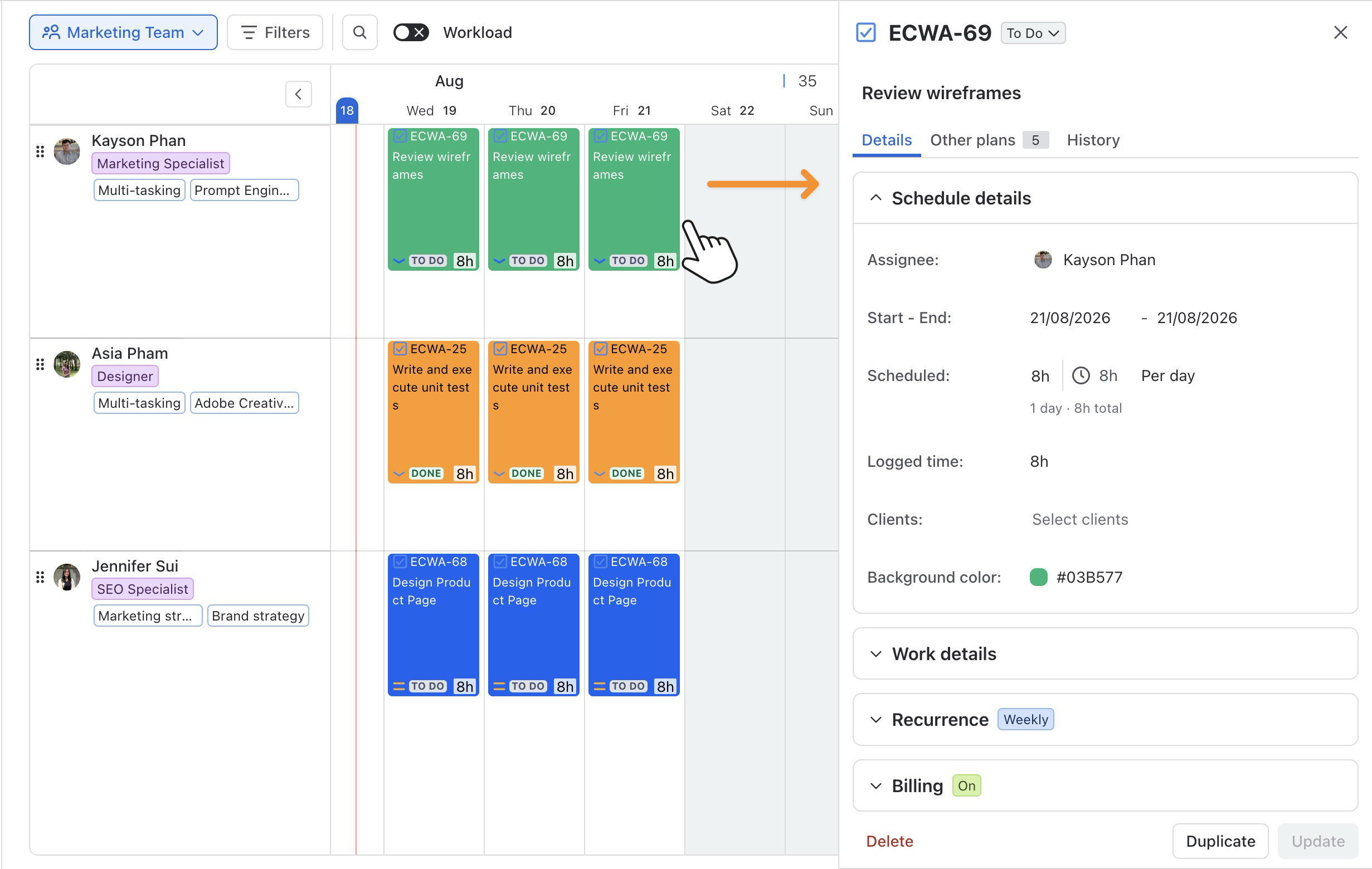

Simply select directly the Issue Card on the schedule board > then the Planning Details will appear directly in the right-hand panel including 3 tabs: DETAILS PLAN HISTORY

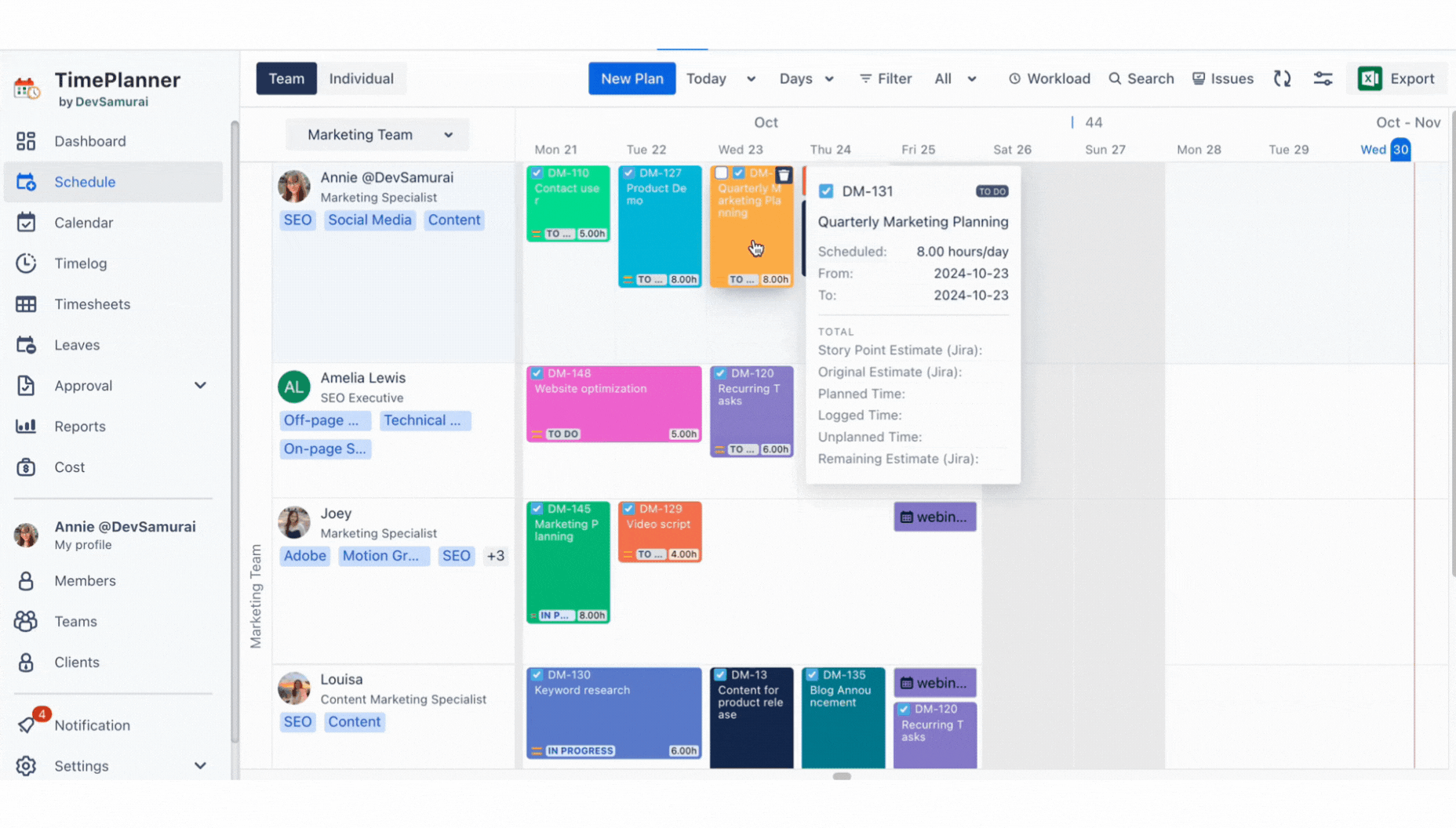

Source for User Guide (5).gif

1. Update a Plan's Details

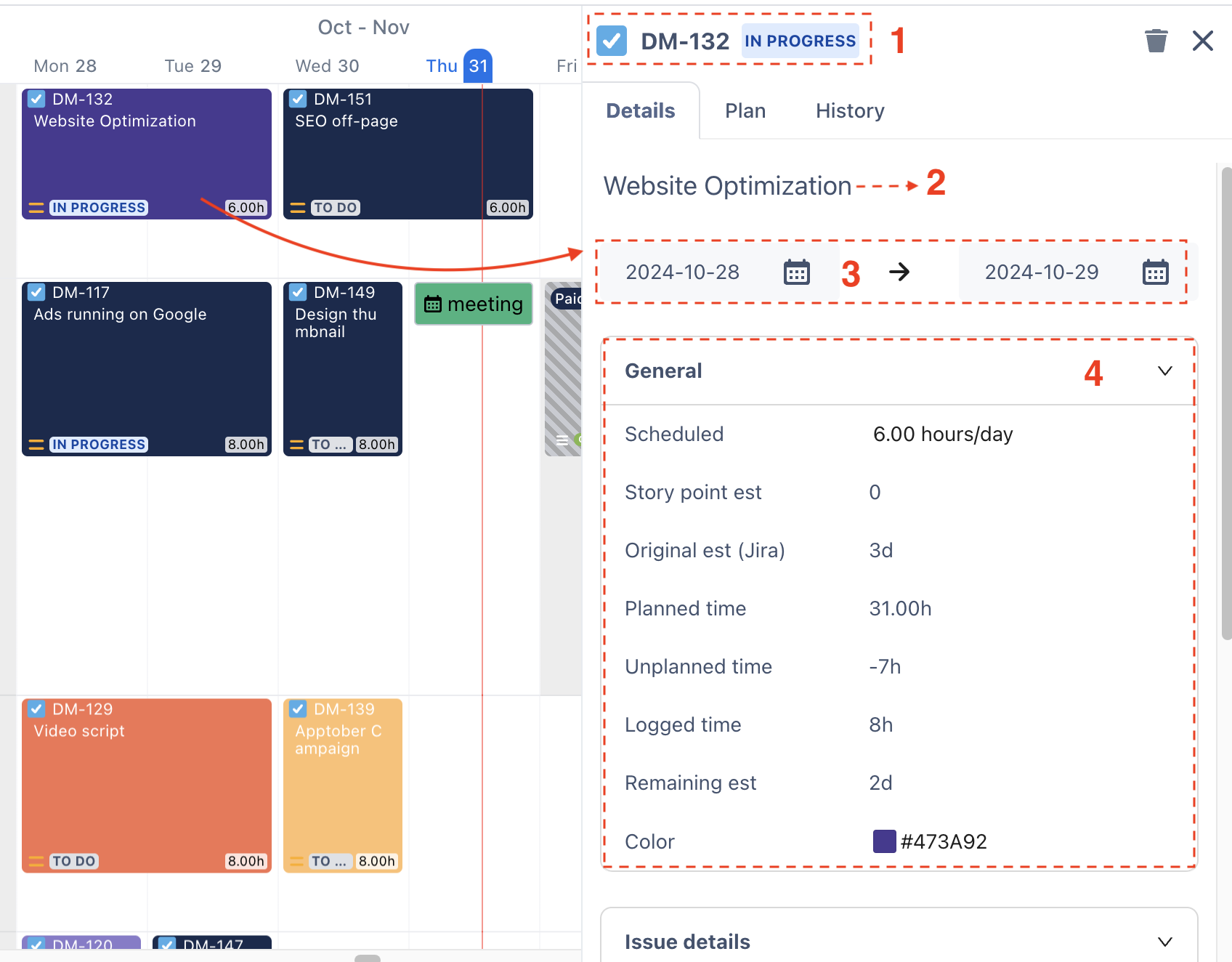

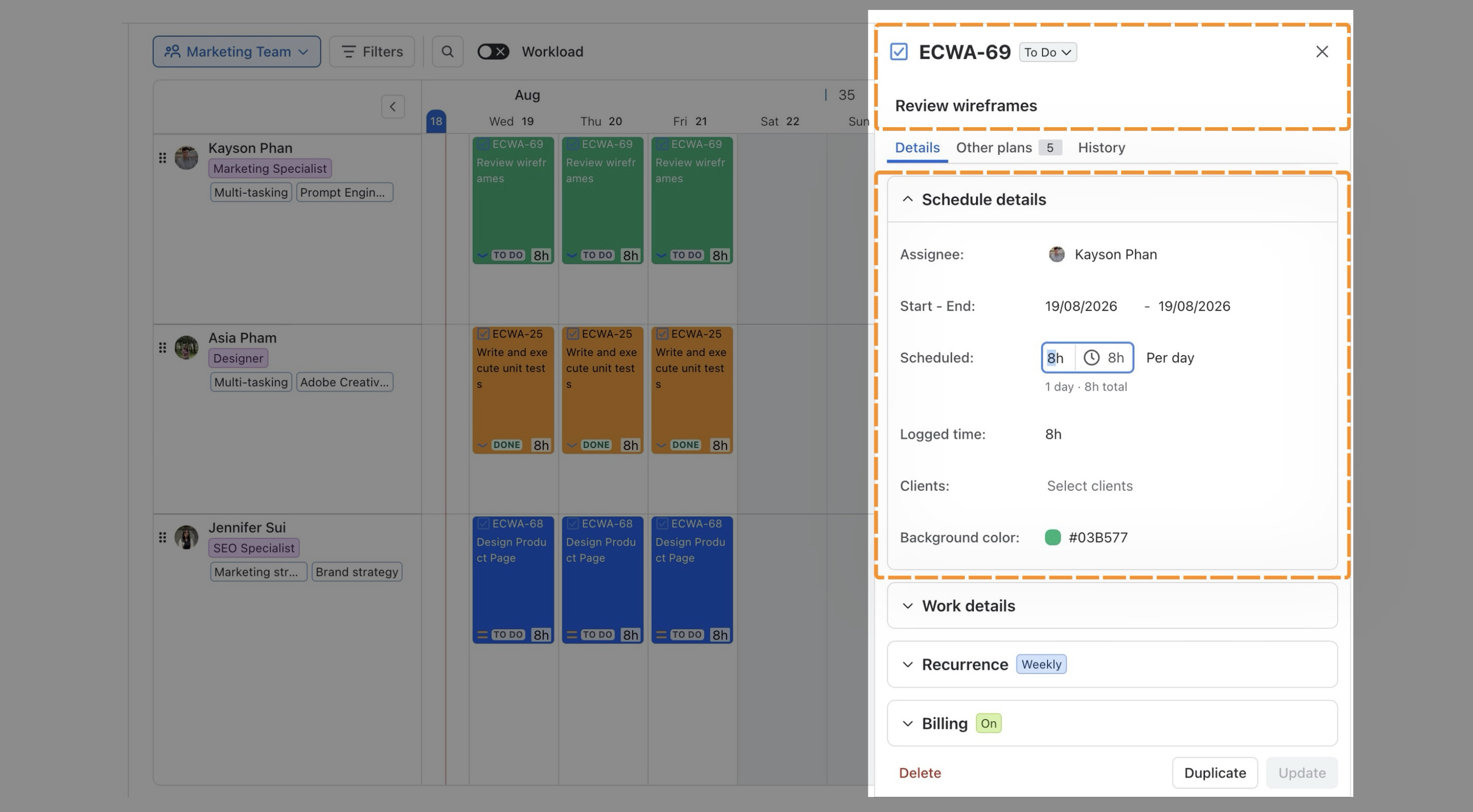

The DETAILS tab allows you can view and update details of a specific task in TimePlanner, including Jira issue information like duration, planned time, status, and more.

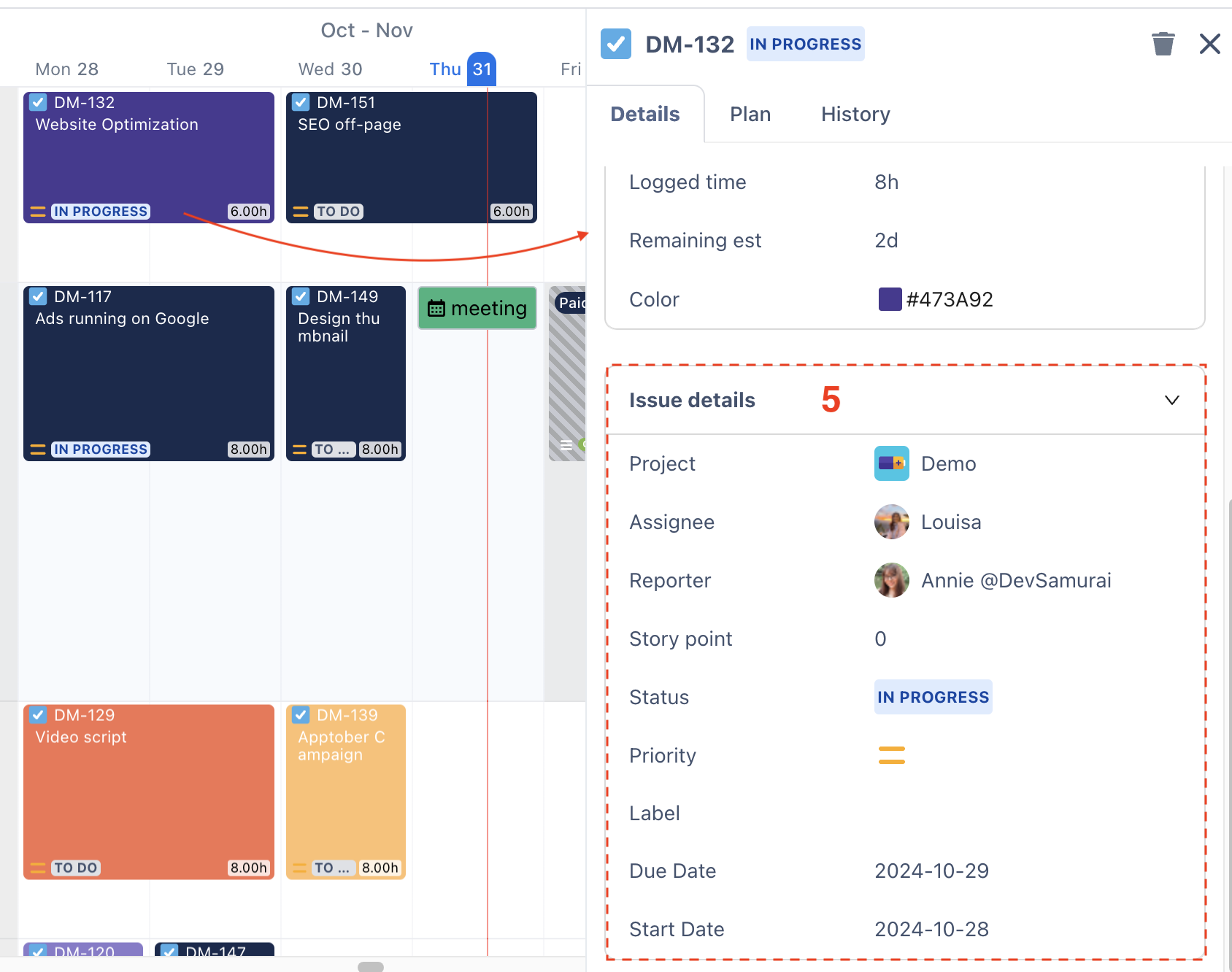

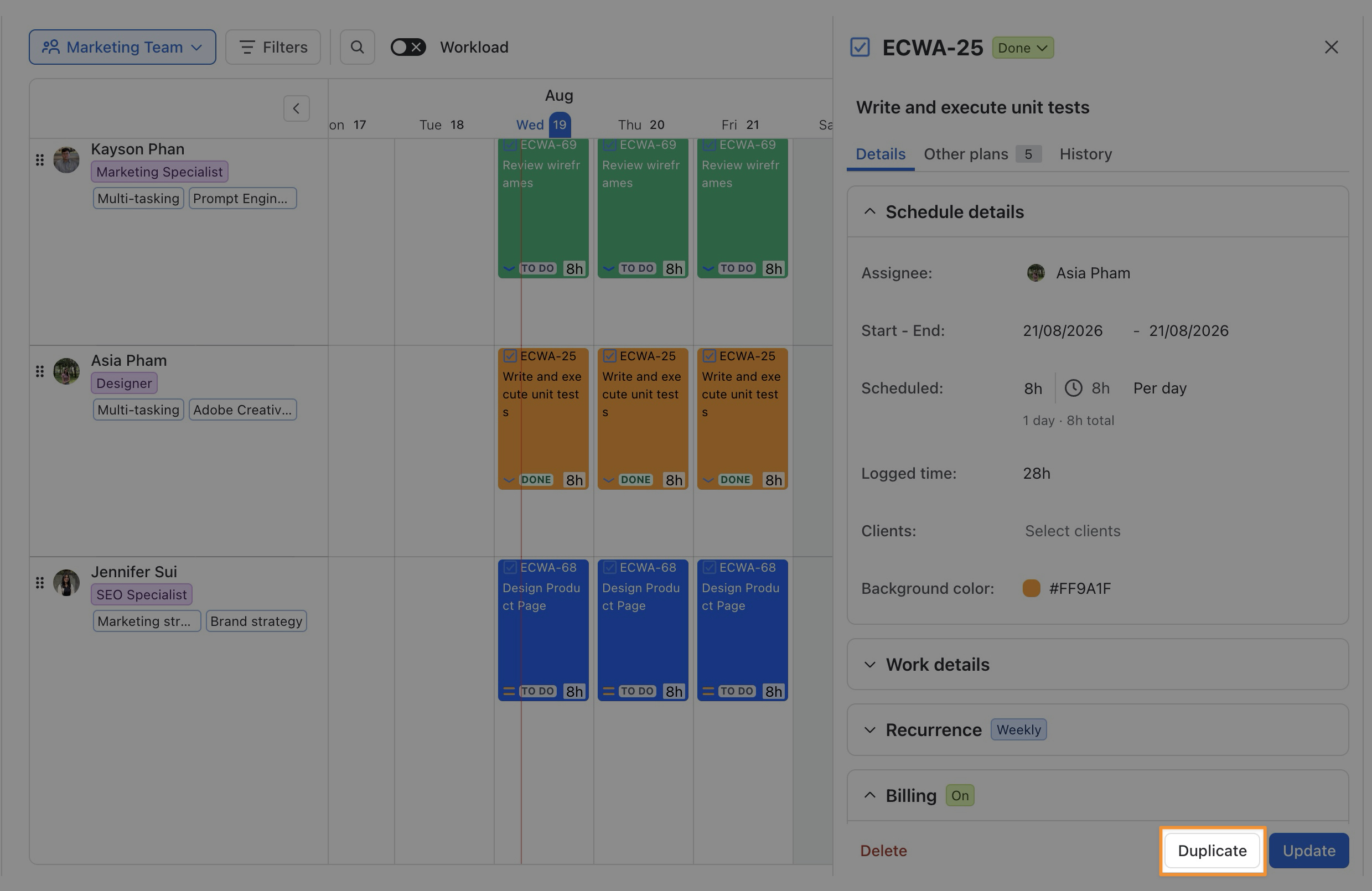

Screenshot 2024-10-31 at 13.28.35.png
Screenshot 2024-10-31 at 13.48.11.png

Field

Description

Directly Editable

(1) Jira Issue key

Click on the issue key Screenshot 2024-10-31 at 14.11.15.pngto open the Jira issue detail view.

YES

(1) Issue Status

Click on the Screenshot 2024-10-31 at 14.11.39.pngbutton to update the issue status.

YES

(2) Task Summary

The summary of an issue

NO

(3) Plan Duration

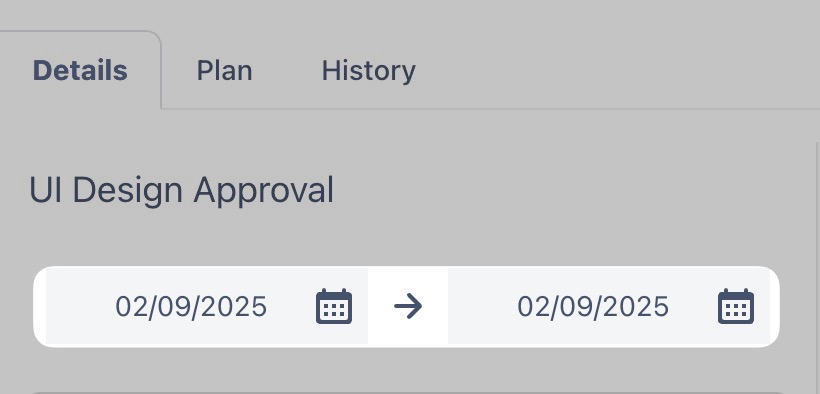

Showcase the start dates and end dates of the task.

NO

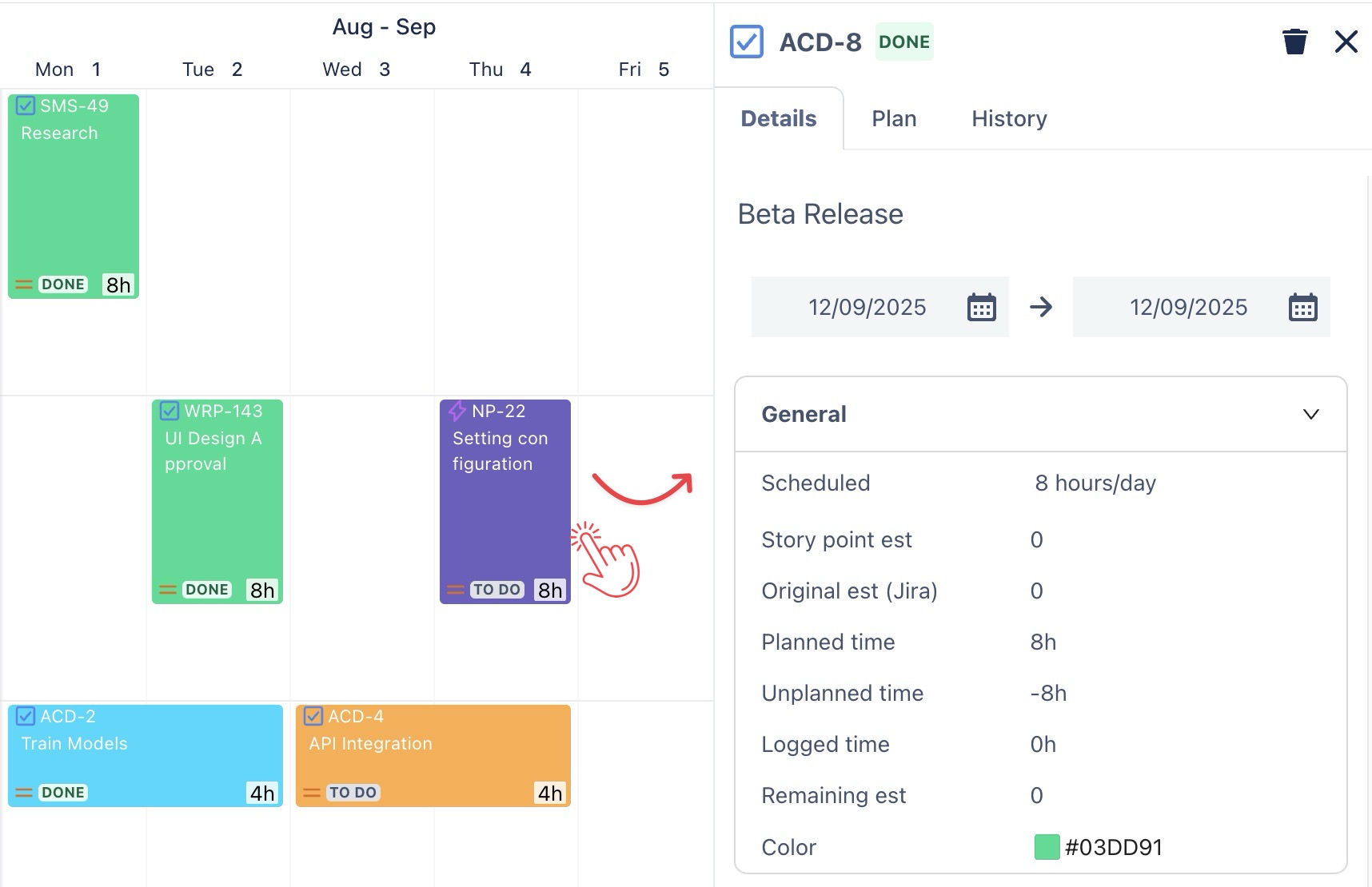

(4) General Details

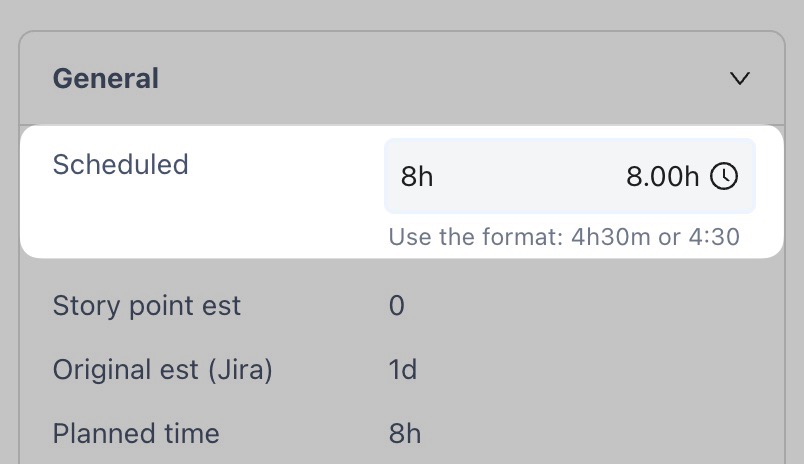

  • Scheduled: Daily hours planned for this task.

YES

  • Story Point Estimation

  • Original Estimate (Jira): Initial time estimate from Jira.

  • Planned Time: Total planned hours for the task.

  • Unplanned Time: is the extra time spent on a task beyond the Original est plan.

Unplanned Time = Original Est − Planned Time

  • Logged Time: Total hours already logged on this task.

  • Remaining est: Refers to the estimated time still needed to complete a task.

Remaining Est = Planned time - Logged time

NO

  • Color: Indicates the task color.

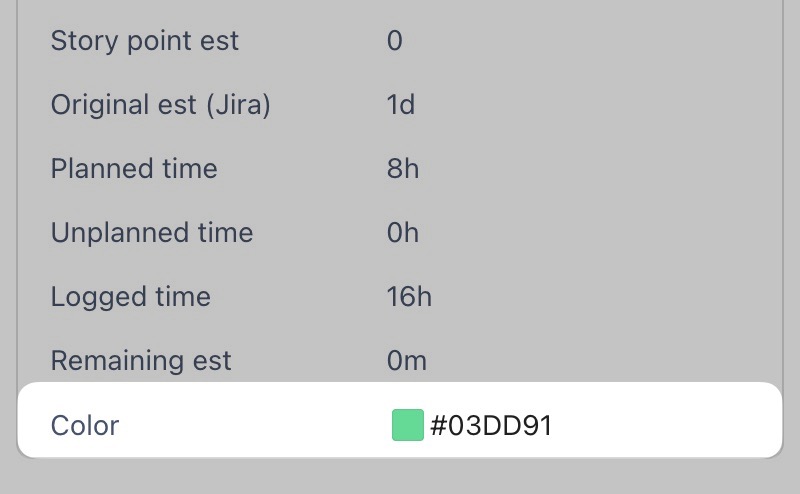

→ To update the color, simply click on the color code Screenshot 2024-10-31 at 14.48.33.png and select a new color

YES

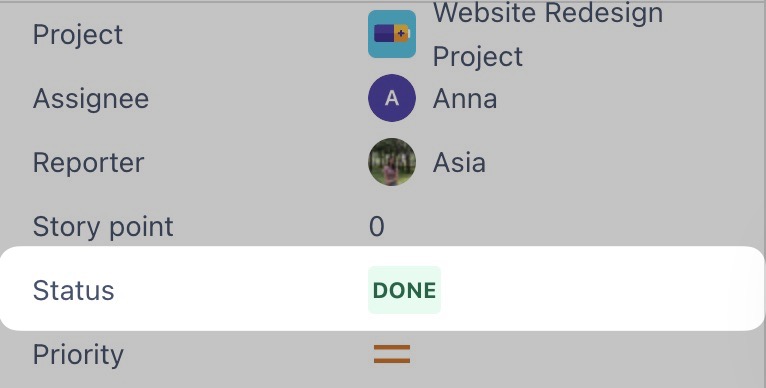

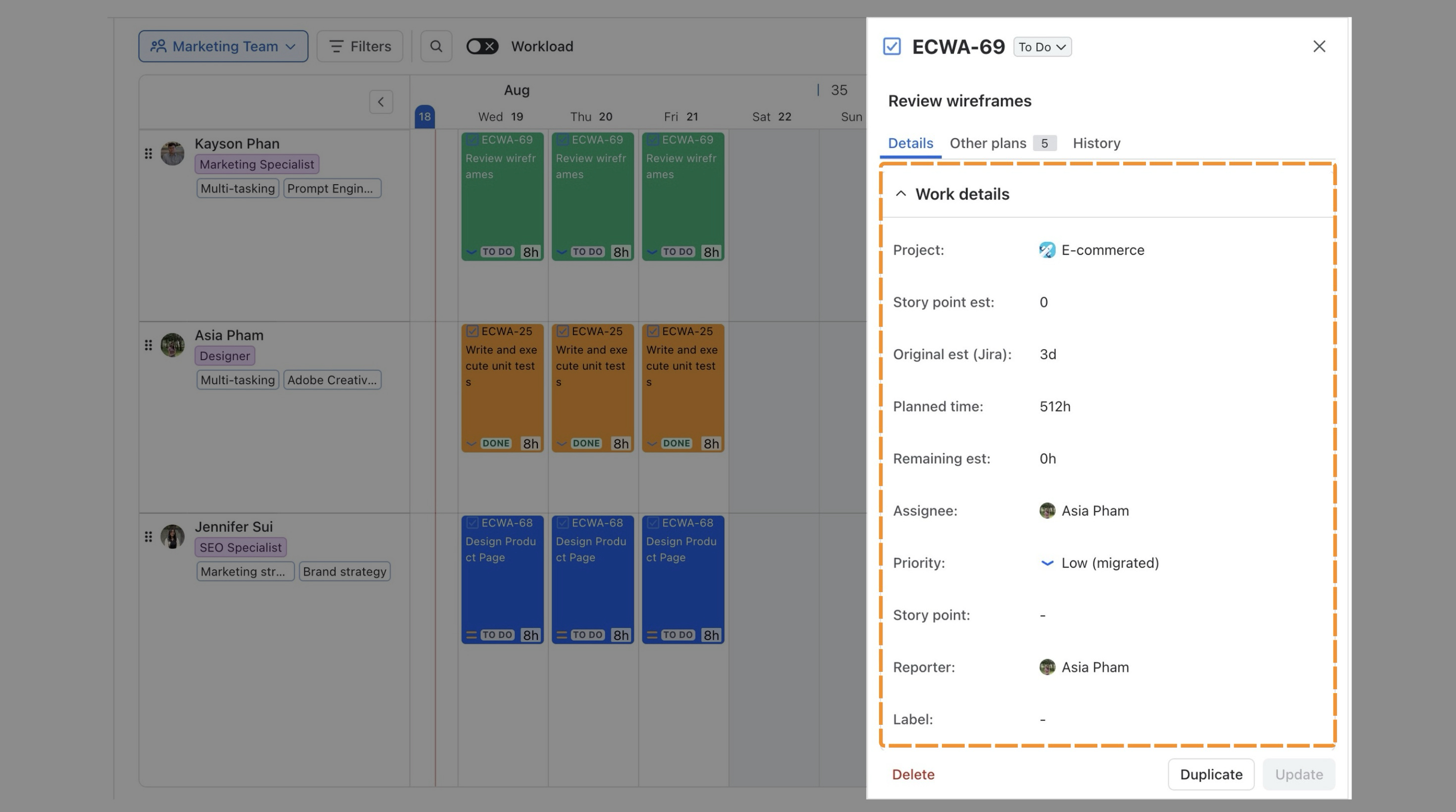

(5) Issue Details (Jira)

  • Project: Indicates the project name associated with this task

NO

  • Assignee: Shows the team member assigned to this task.

→ To update another assignee, please access the Plan tab.

YES

  • Reporter: The person who created the task.

  • Story Point: Represents the complexity of the task

  • Label: Additional tagging or categorization of the task.

NO

  • Status: Indicate the current status of the task

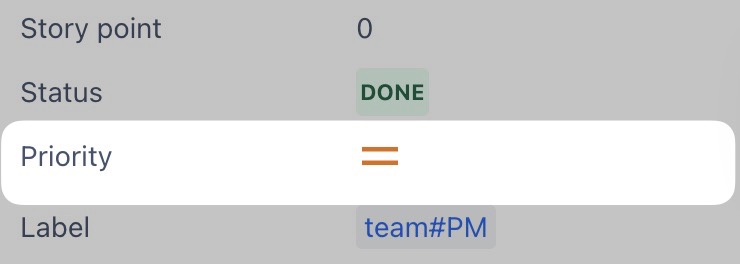

  • Priority: Shows the task’s priority level.

YES

  • Start Date & Due Date: Duration of the Task.

NO

2. Reassign Resources & Add More Plans

The PLAN tab enables users to customize key scheduling aspects of each task:

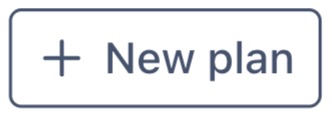

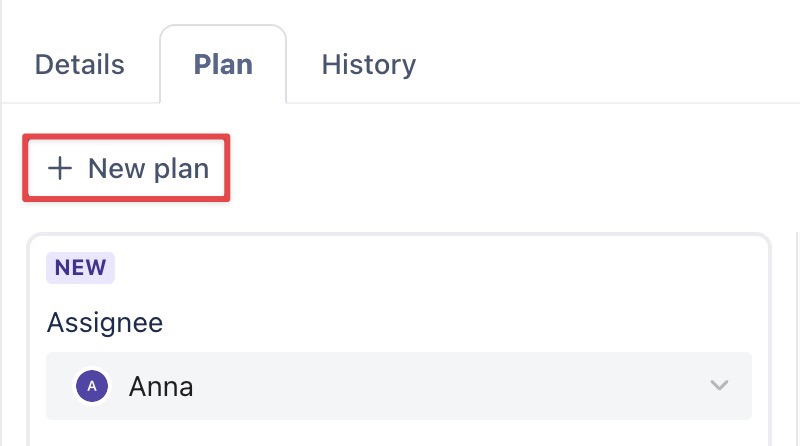

  1. Add more plans: Click on the + New Plan buttonScreenshot 2024-10-22 at 16.58.21.png to create more new plans for the task.

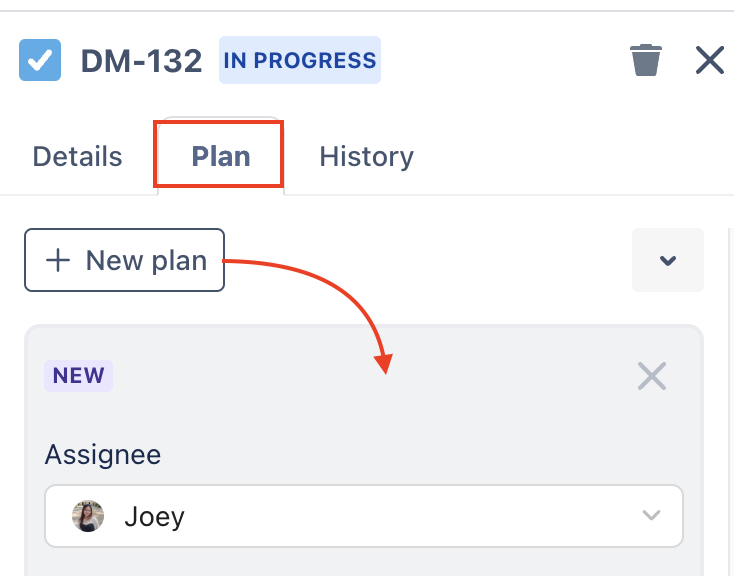

Screenshot 2024-10-31 at 15.44.32.png

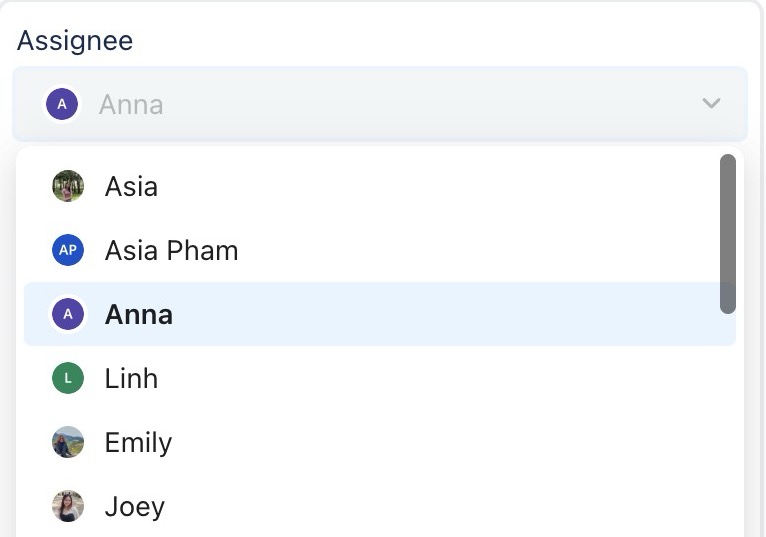

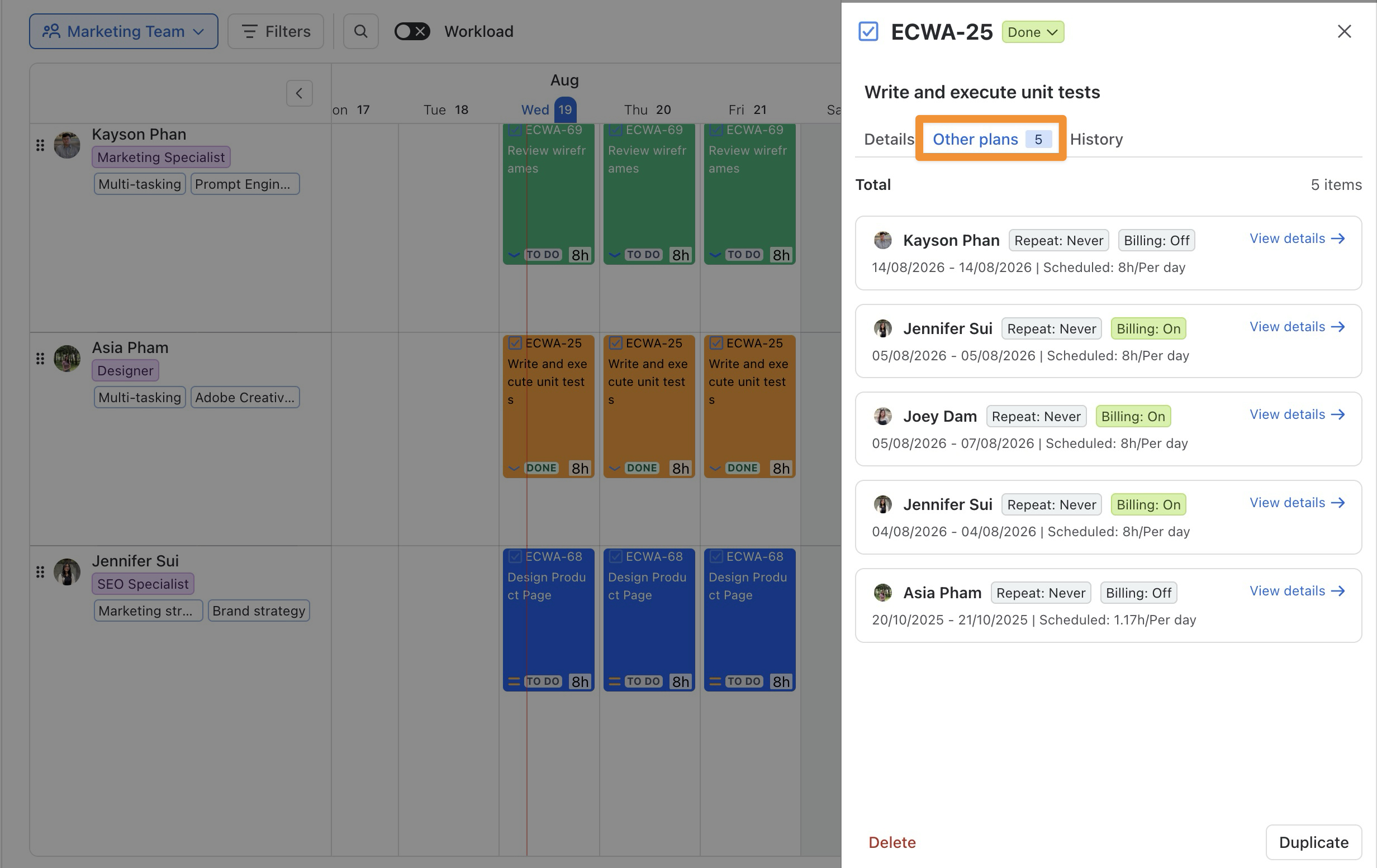

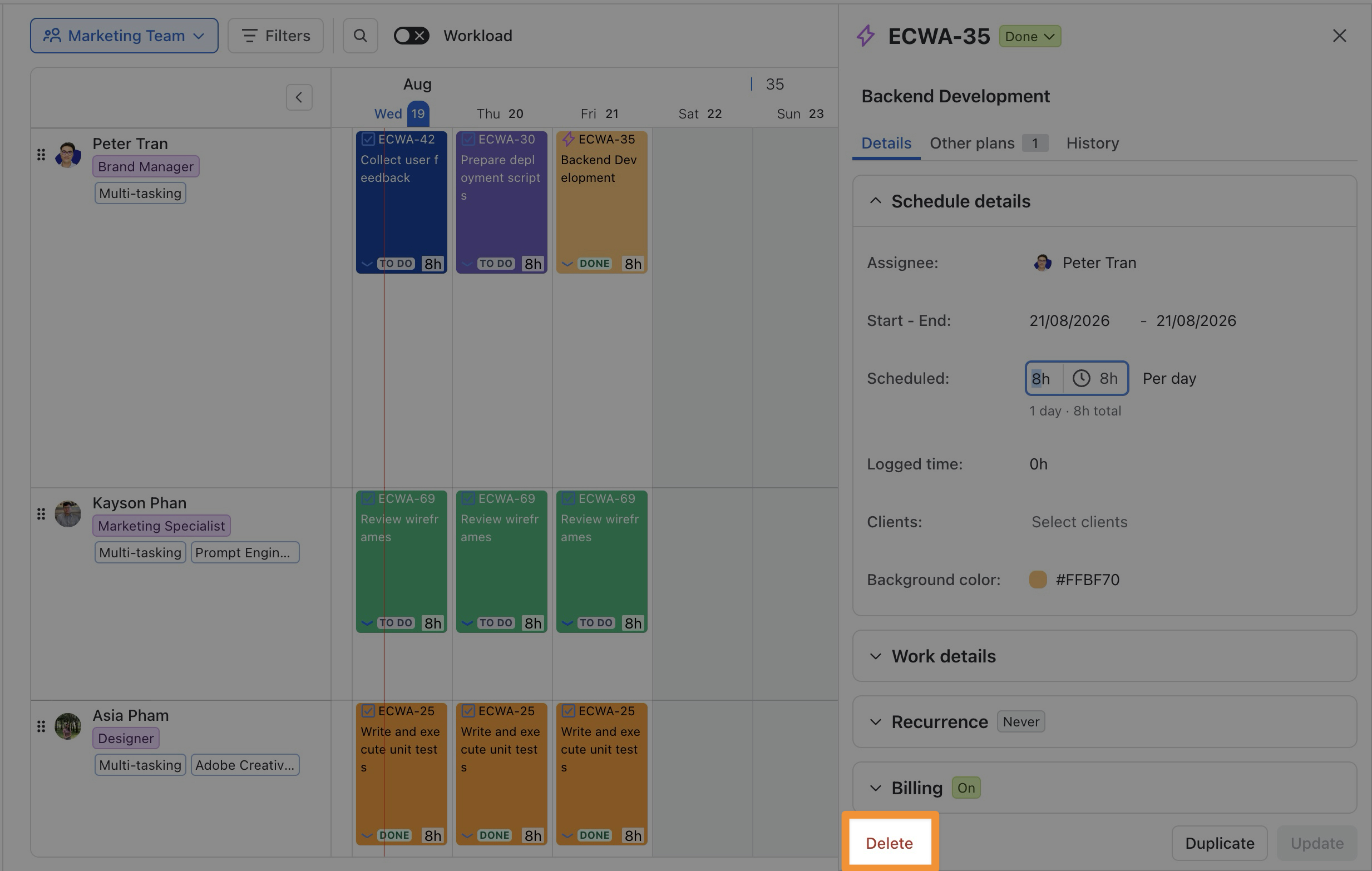

  1. Reassign a plan to another member: From the Assignee section, use the dropdown to change another resource.

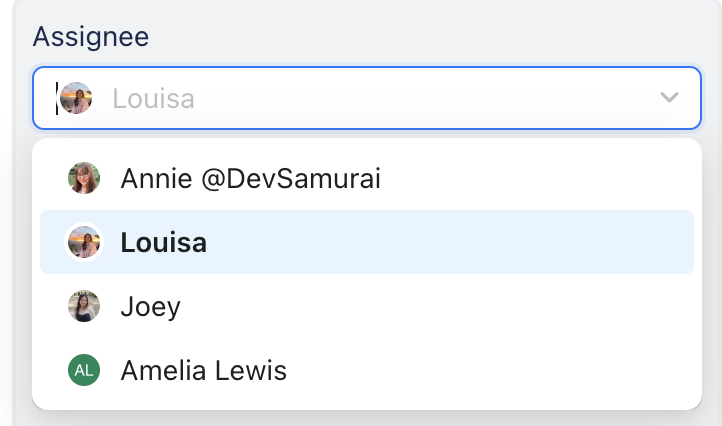

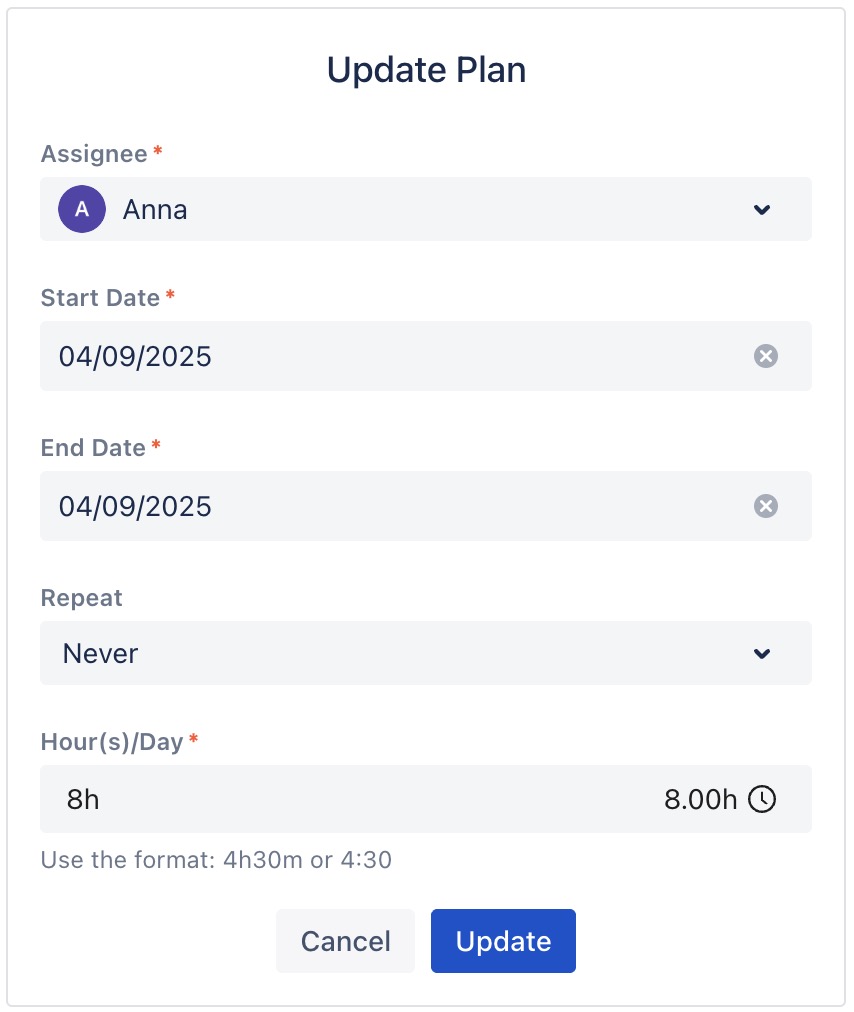

Screenshot 2024-10-31 at 15.45.25.png

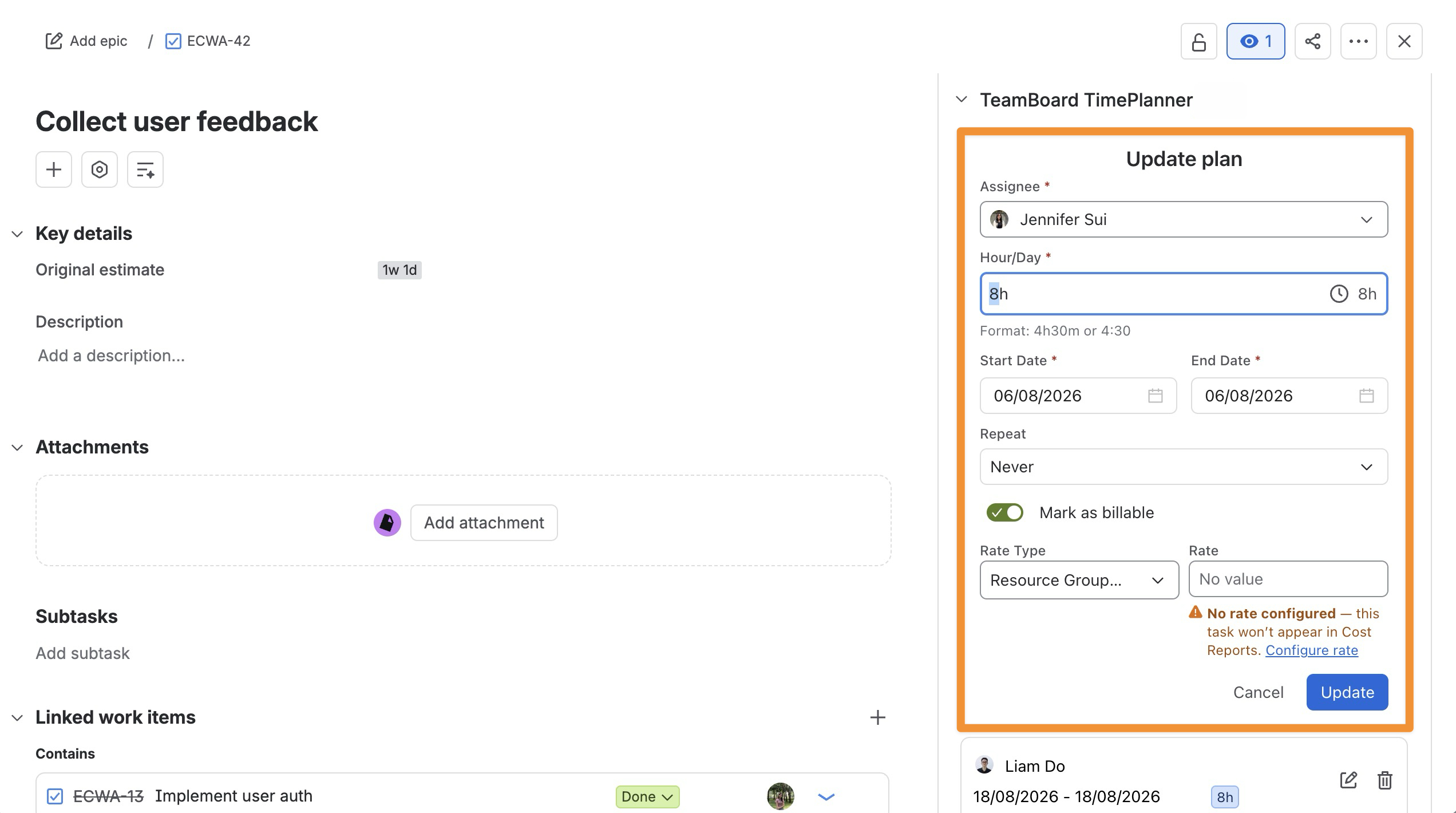

  1. Update the work schedule:

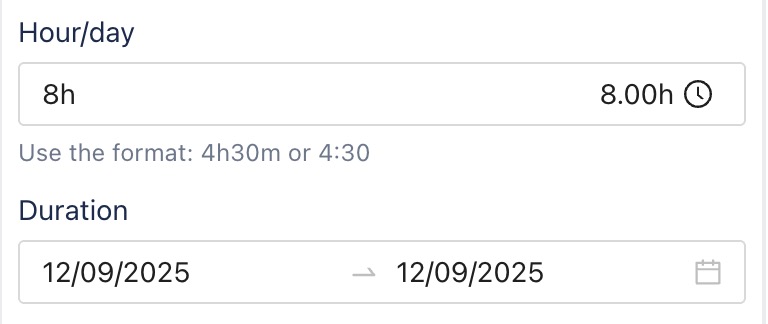

  • Hour/day: To update the hours planned for the task per day.

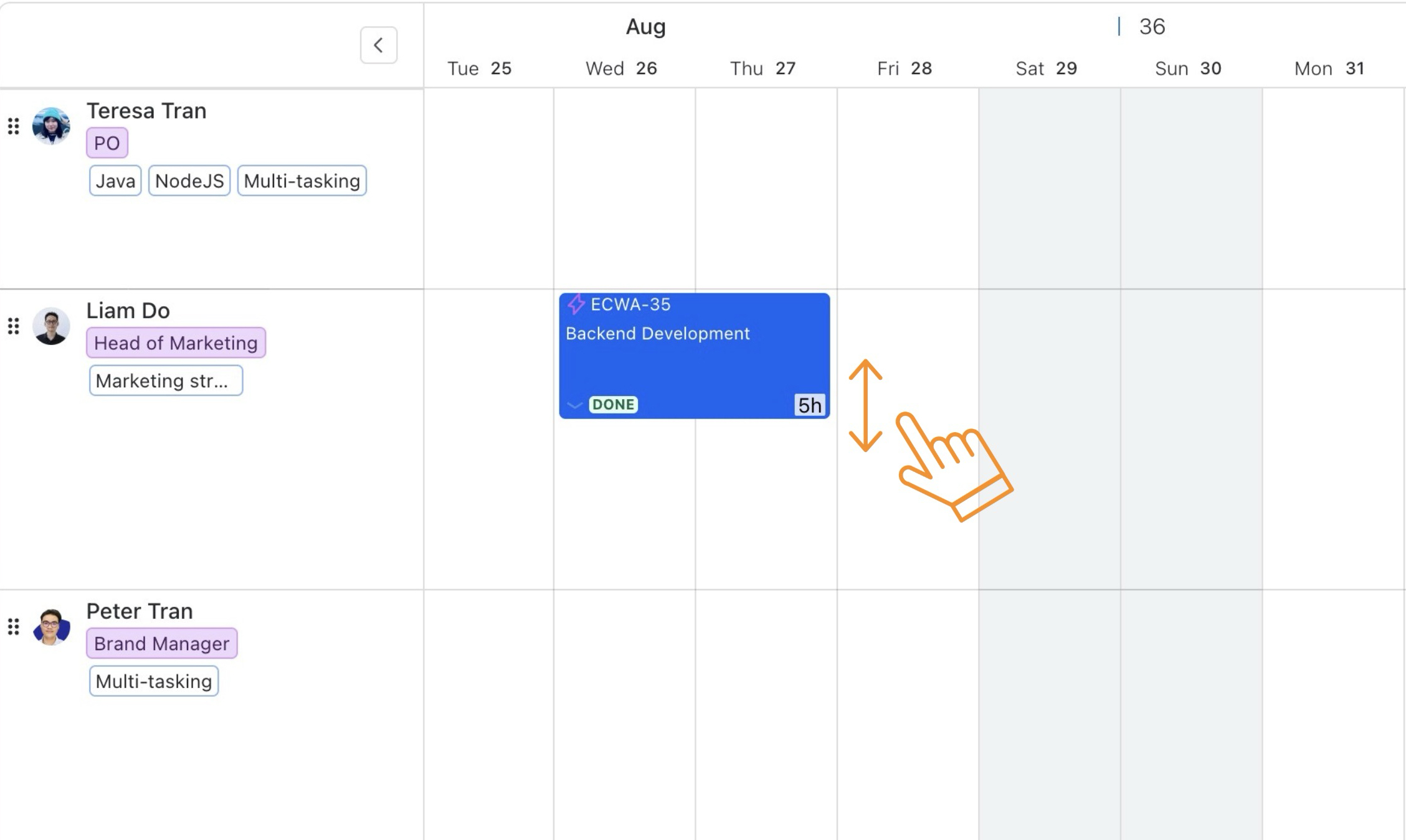

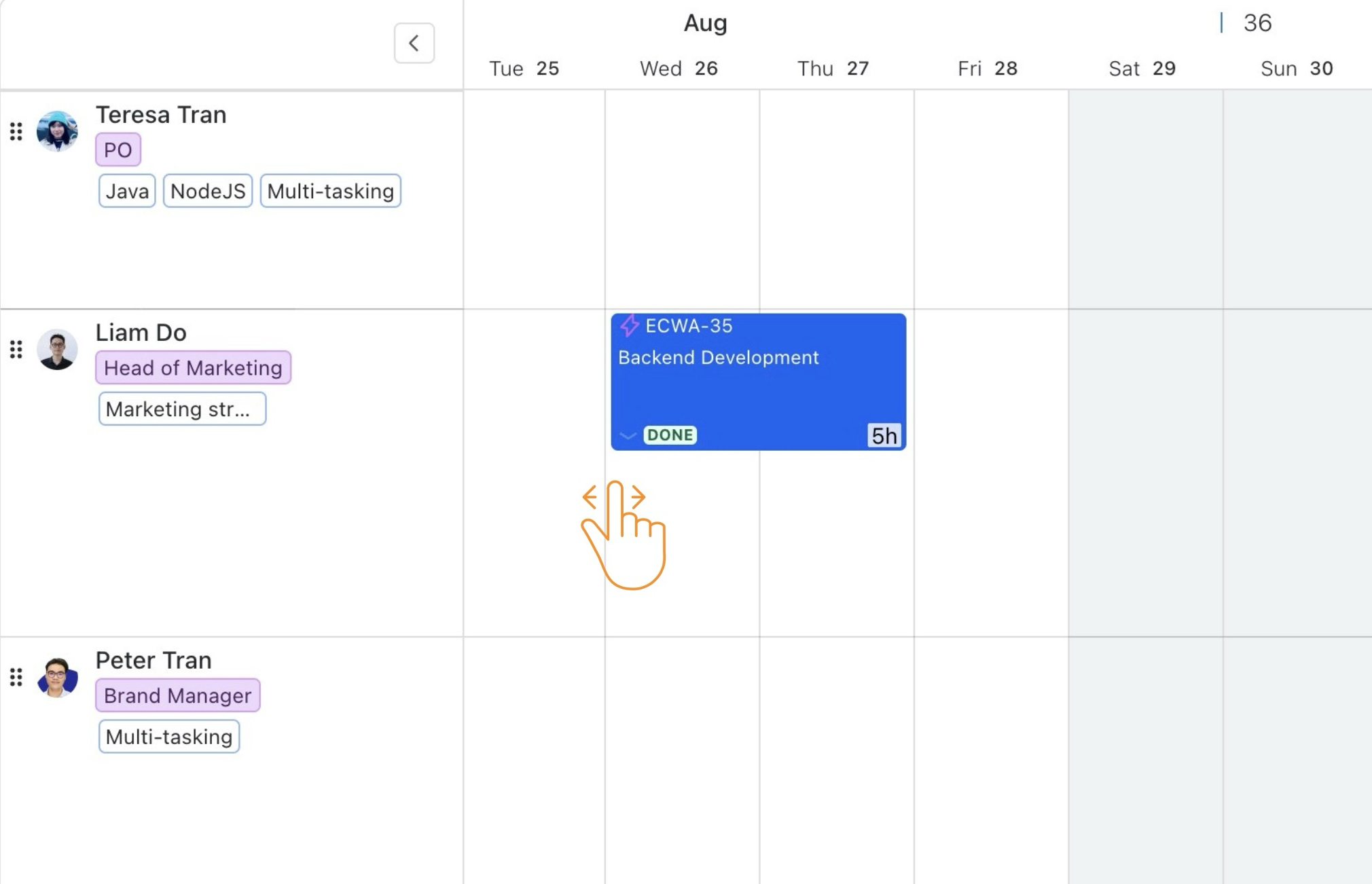

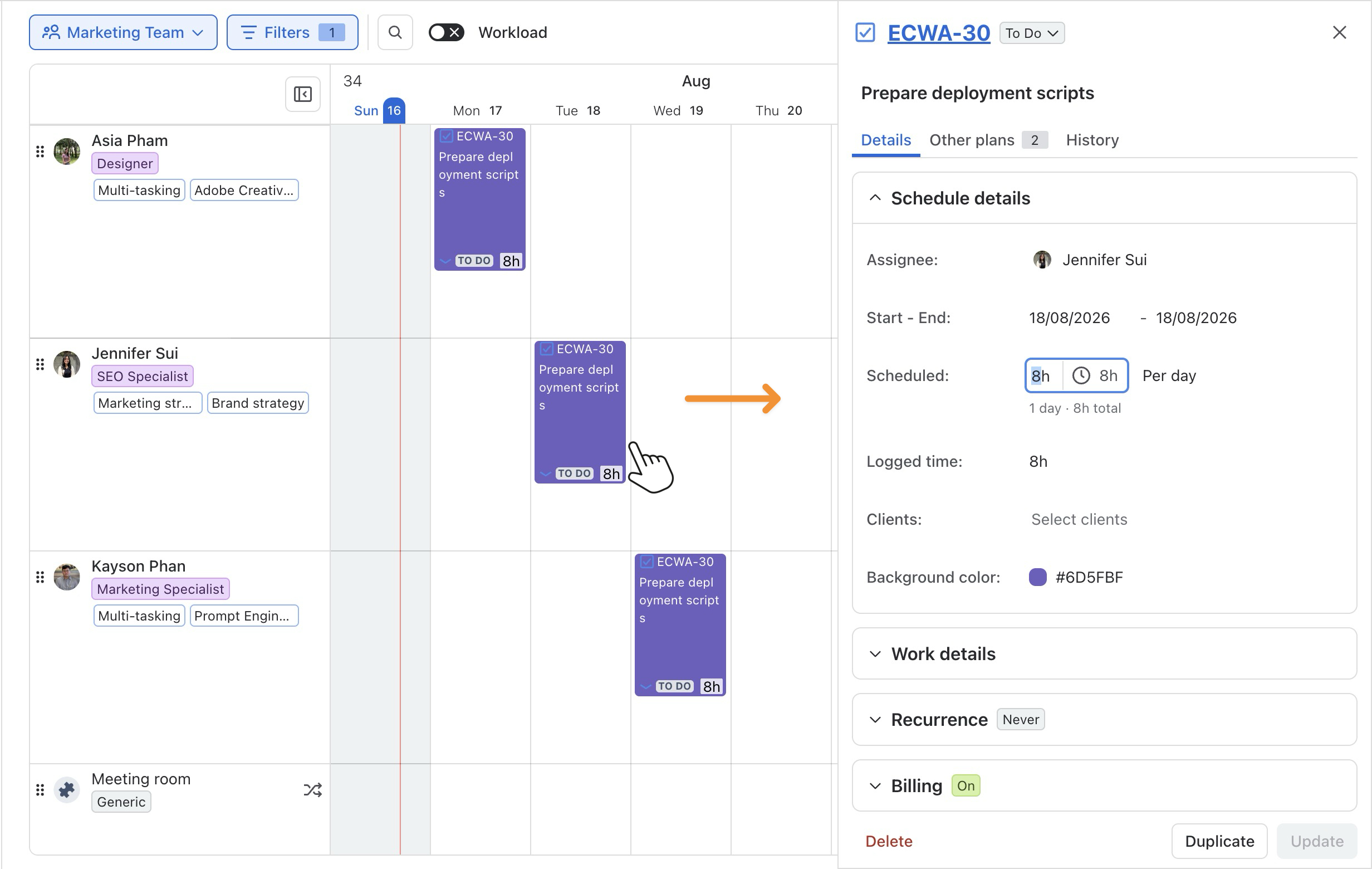

  • Duration: Directly clicking to define the start and end dates for the task.

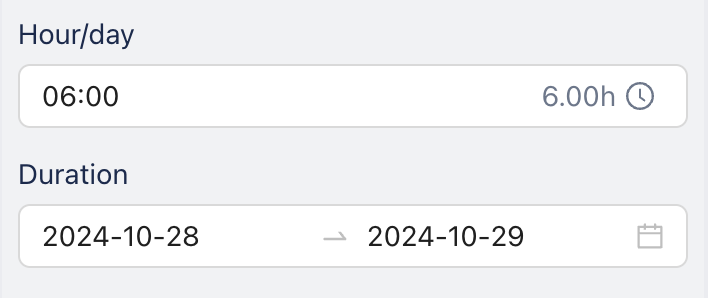

Screenshot 2024-10-31 at 15.51.56.png

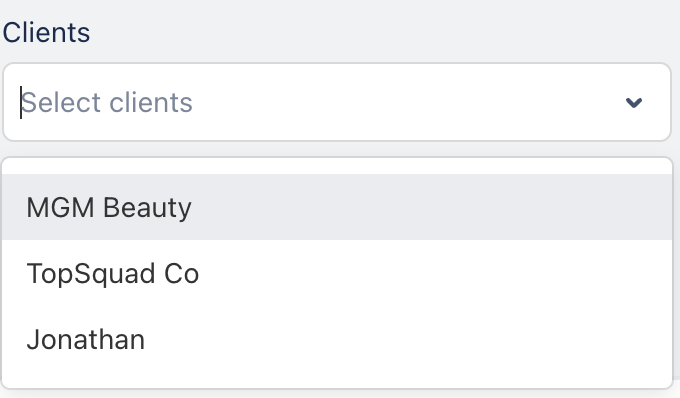

  1. Link a task plan to clients: Use the dropdown to select clients associated with the task.

(Learn more about Scheduling for clients.)

Screenshot 2024-10-31 at 15.54.42.png

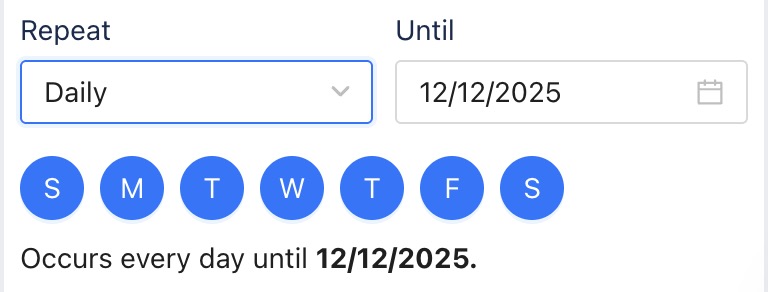

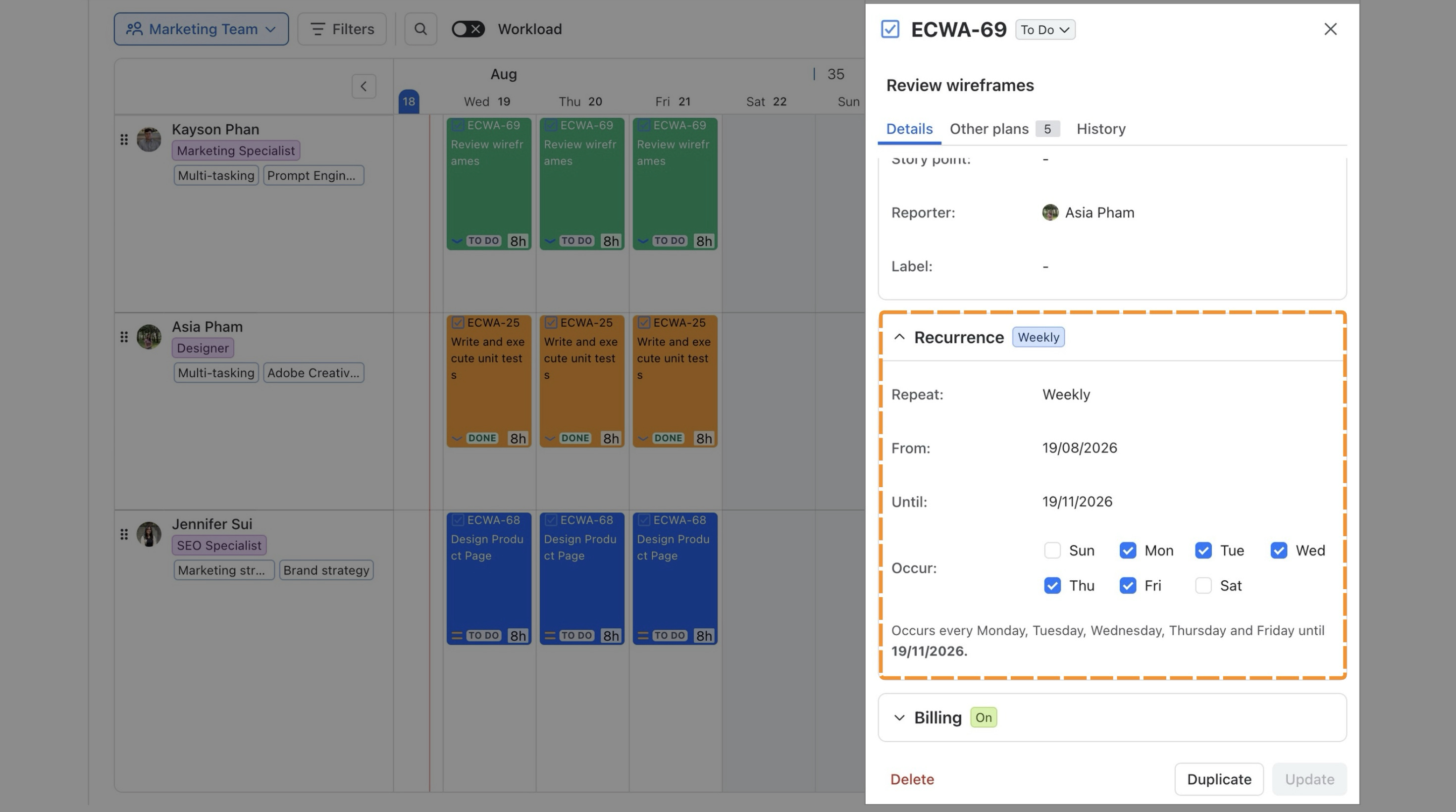

  1. Set up recurring tasks for ongoing activities that repeat over time such as daily, weekly, bi-weekly or monthly.

(Learn more: Recurring Tasks feature)

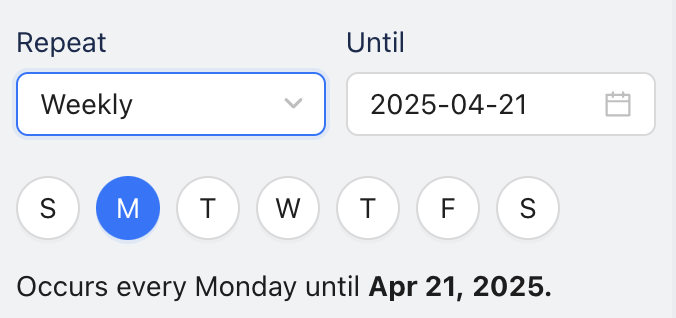

Screenshot 2024-10-31 at 15.56.25.png

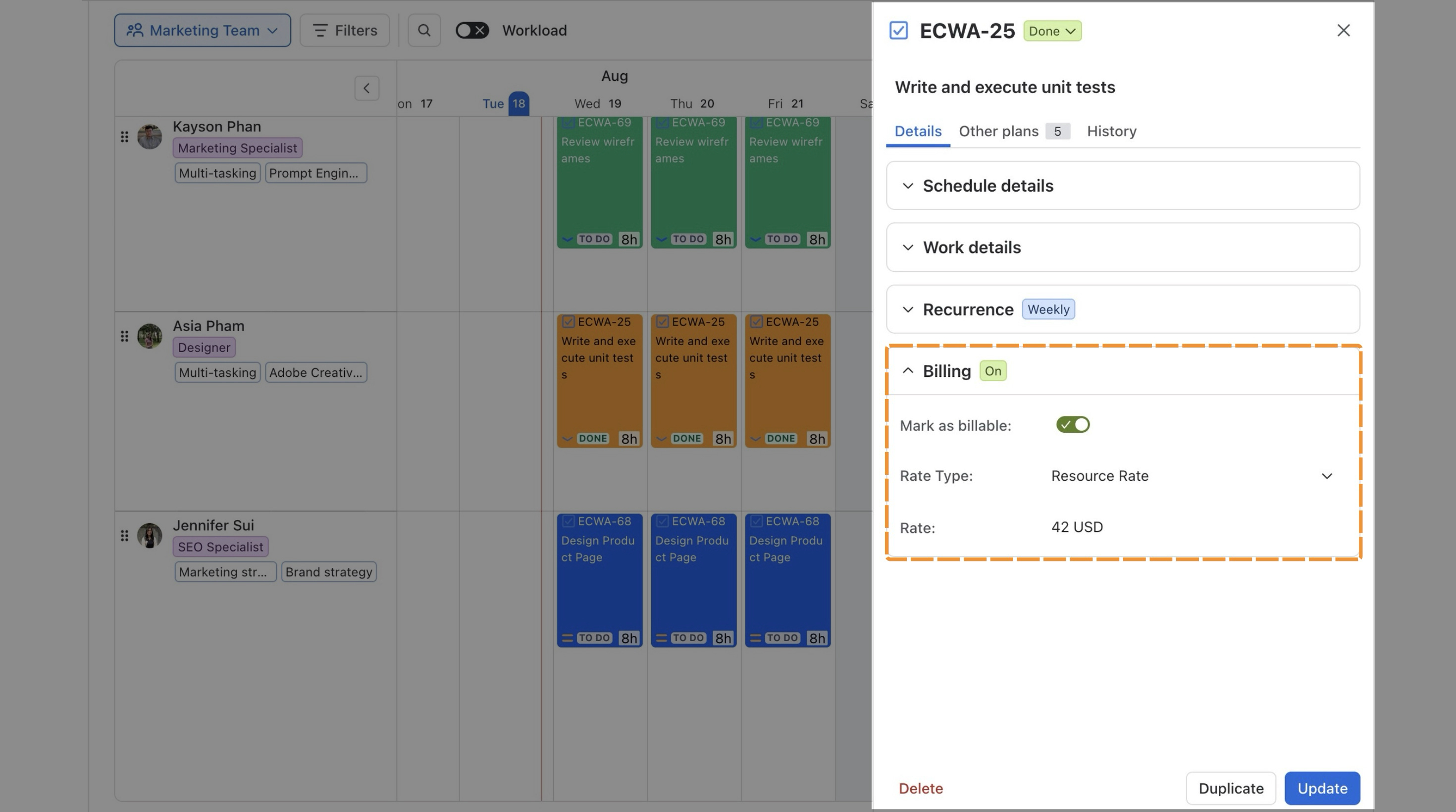

  1. Mark task as billable: Toggle the task's billable status to track it for invoicing or billing purposes. (Learn more: Cost Planning)

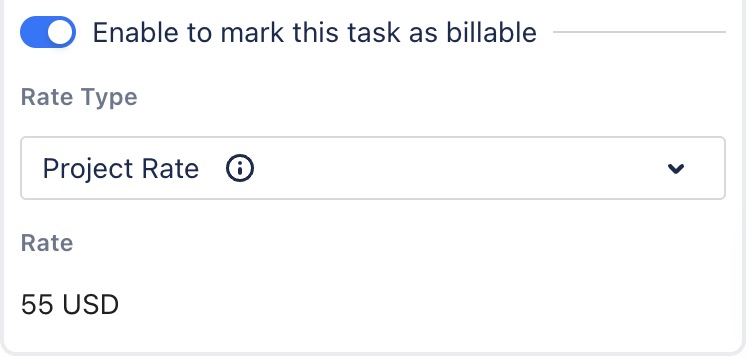

To set up billable tasks, users need either:

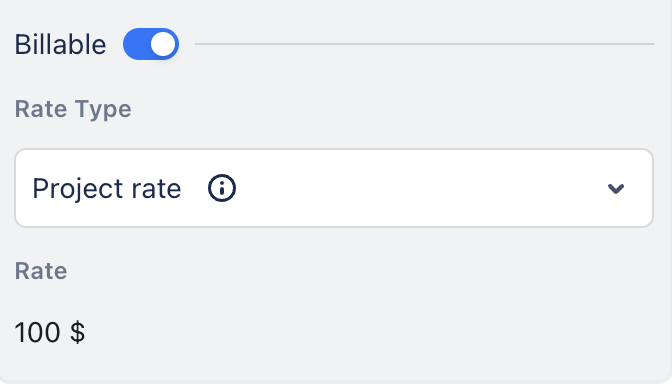

Screenshot 2024-10-31 at 16.03.13.png

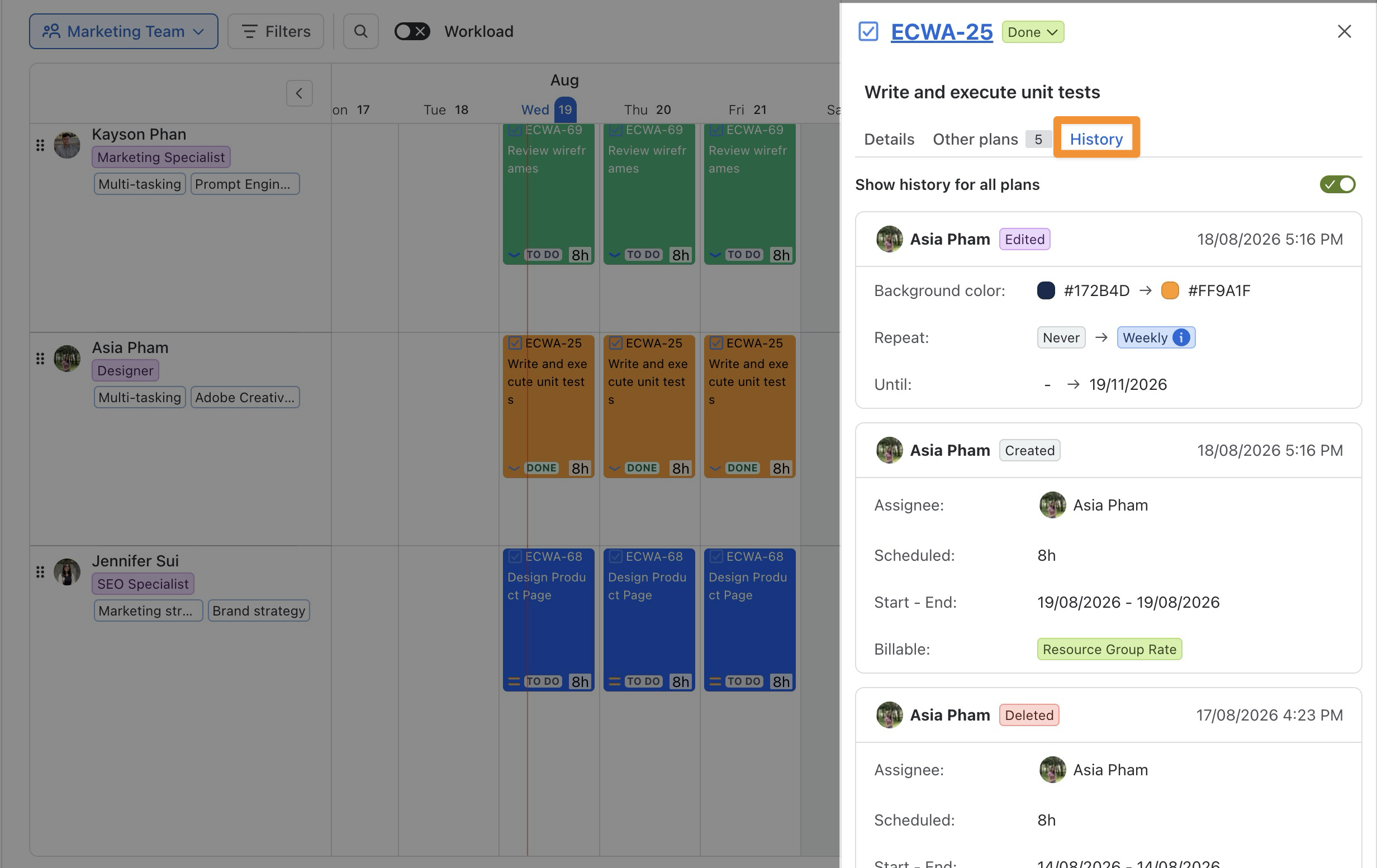

3. Task Planning History

The HISTORY tab allows you to view the history logs of your task planning to better track changes and adjustments over time such as task's schedule, assignees, and related information.

Task Planning History is not available for Jira Field Mapping projects.

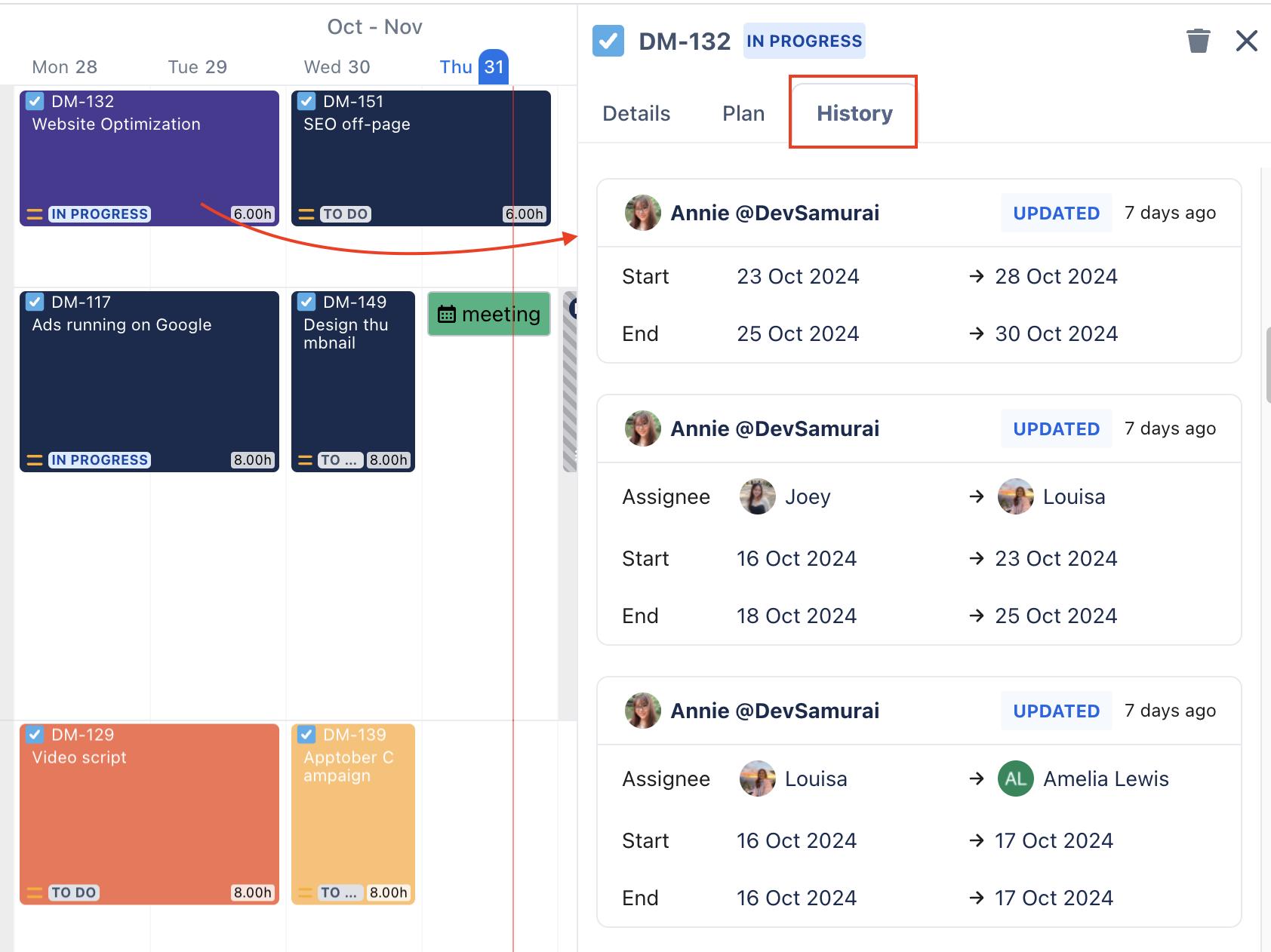

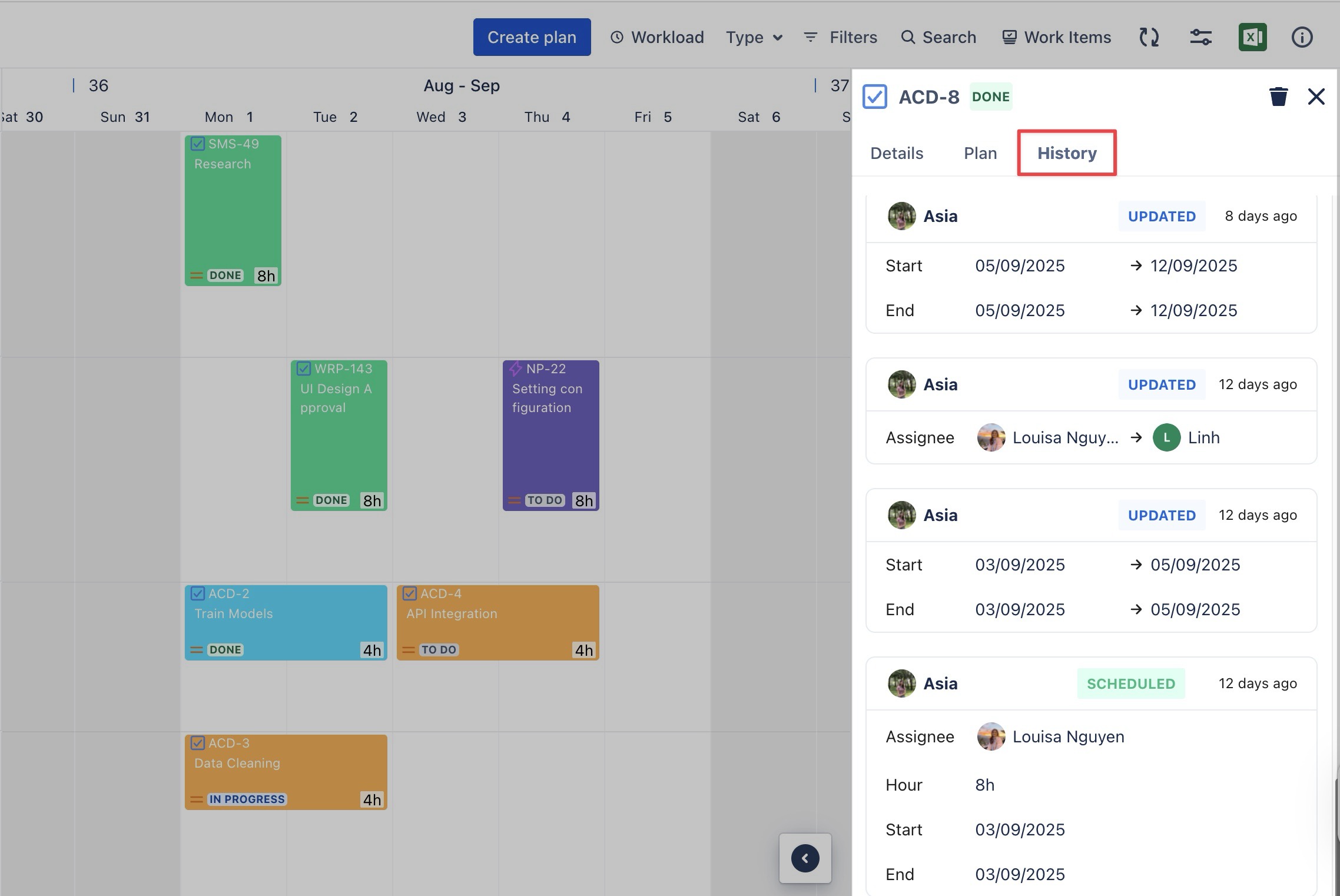

Screenshot 2024-10-31 at 16.10.25.png

4. Remove/Unplan a Task from the Schedule Board

This guide applies to regular tasks only. For unplanning recurring items, please click here.

There are 3 ways to remove a task from the board:

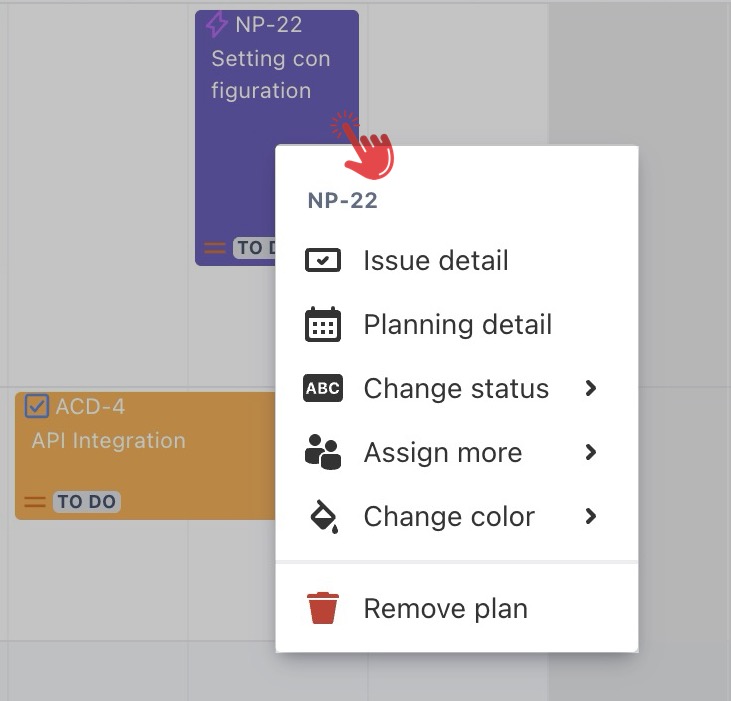

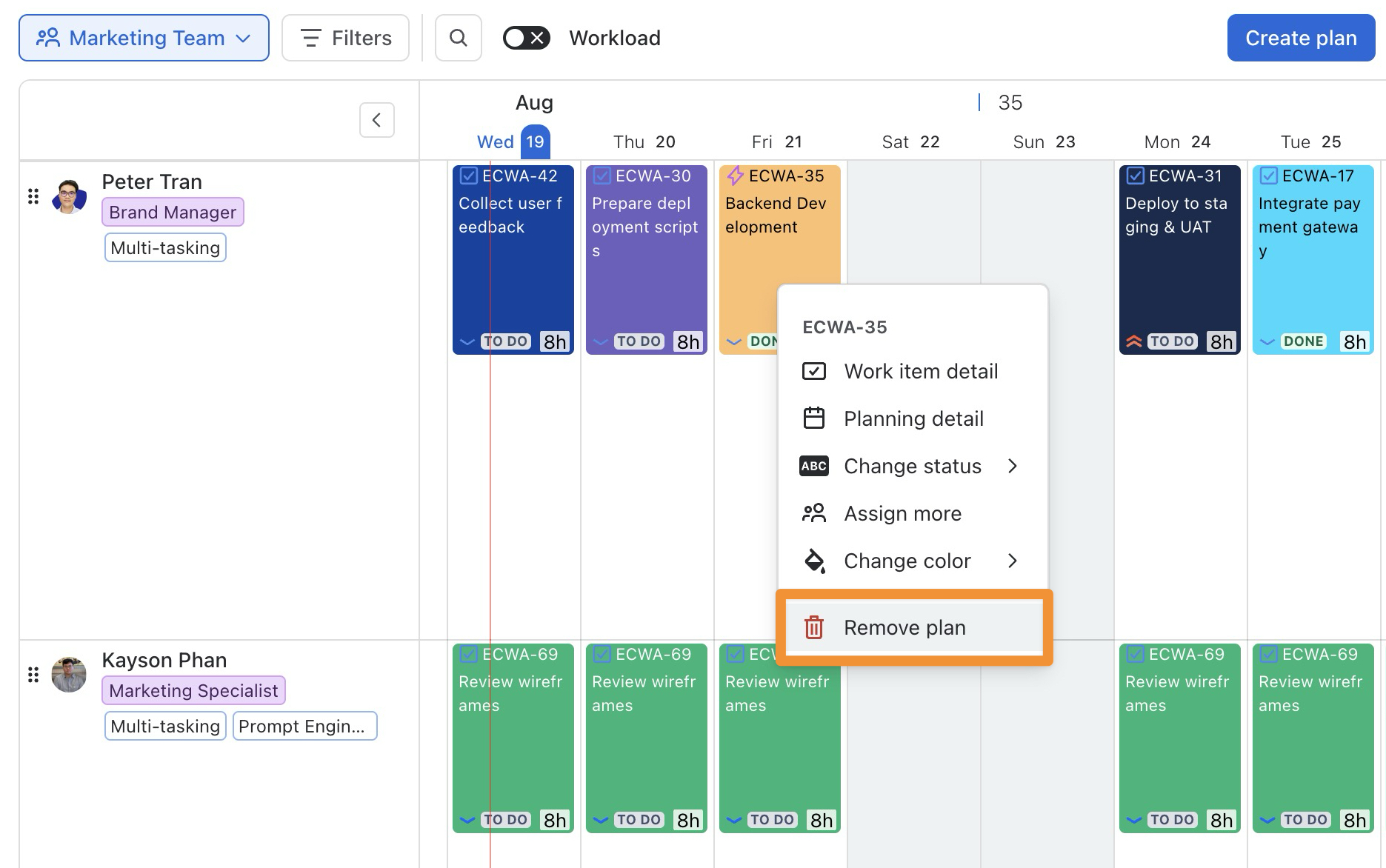

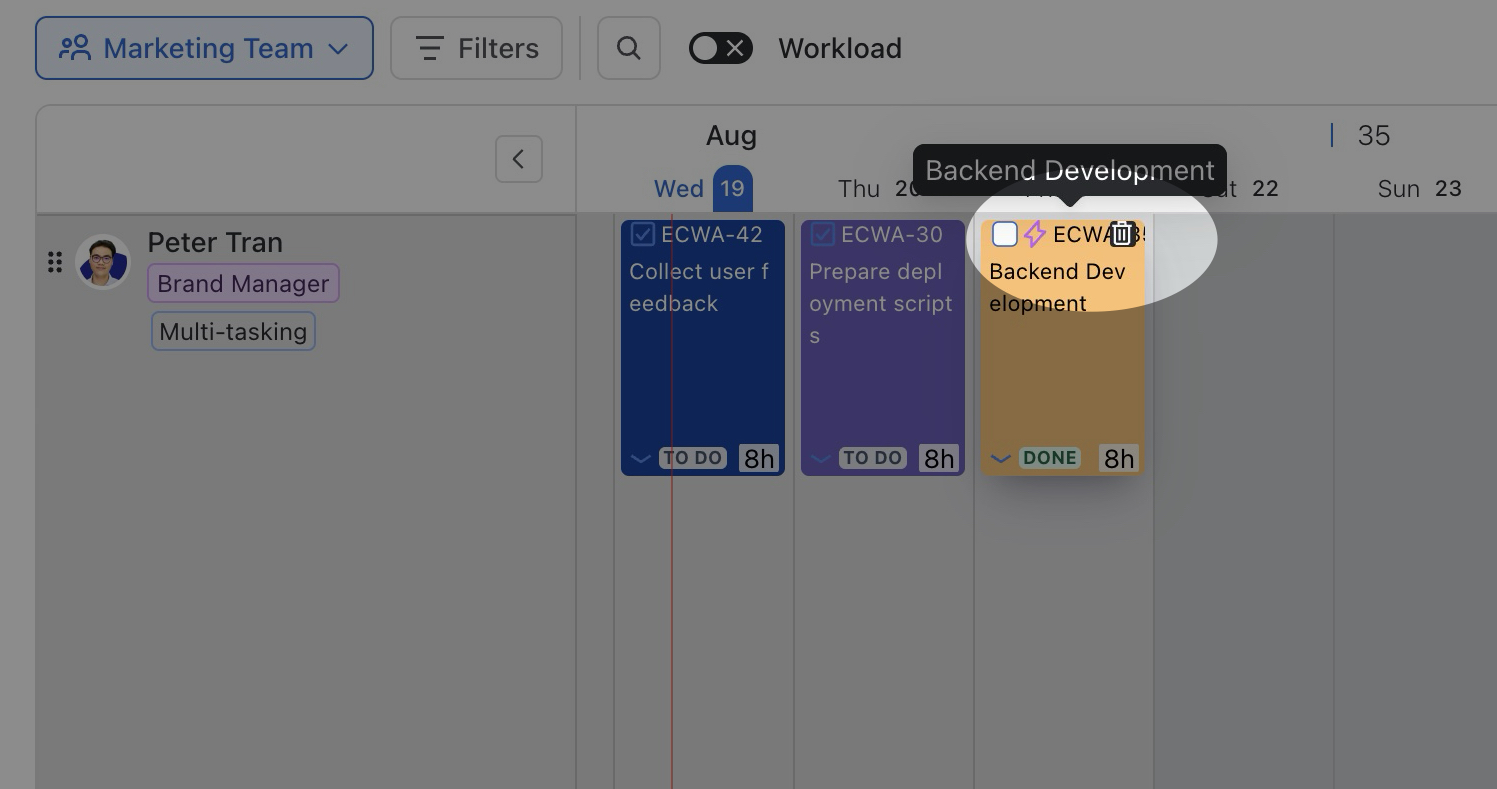

  1. On each Issue Card, use the Screenshot 2024-09-25 at 16.37.15.png icon to unplan the task.

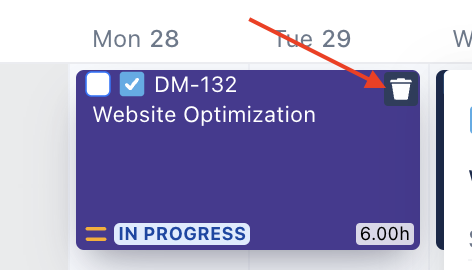

    Screenshot 2024-10-31 at 16.22.10.png

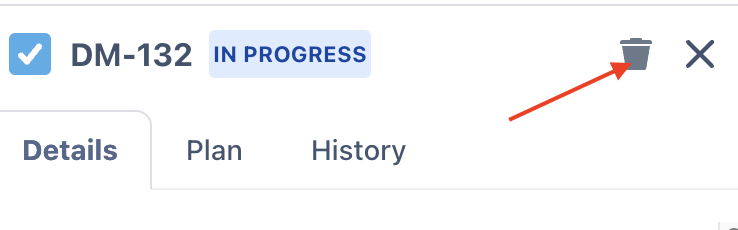

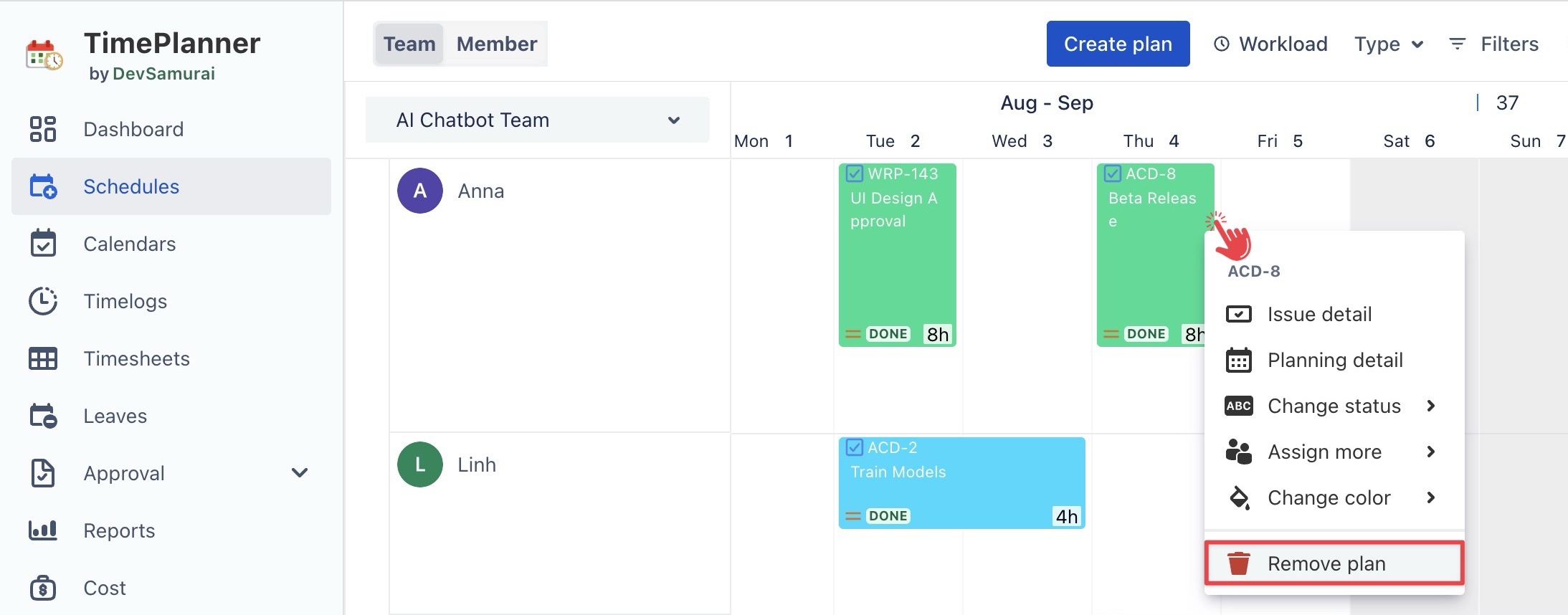

  2. From the Planning Details, click on Screenshot 2024-09-25 at 16.37.15.png icon to remove the task.

    Screenshot 2024-10-31 at 16.25.18.png

    → A confirmation prompt will appear, allowing you to confirm or cancel the action. Click on YES to remove the task from the board.

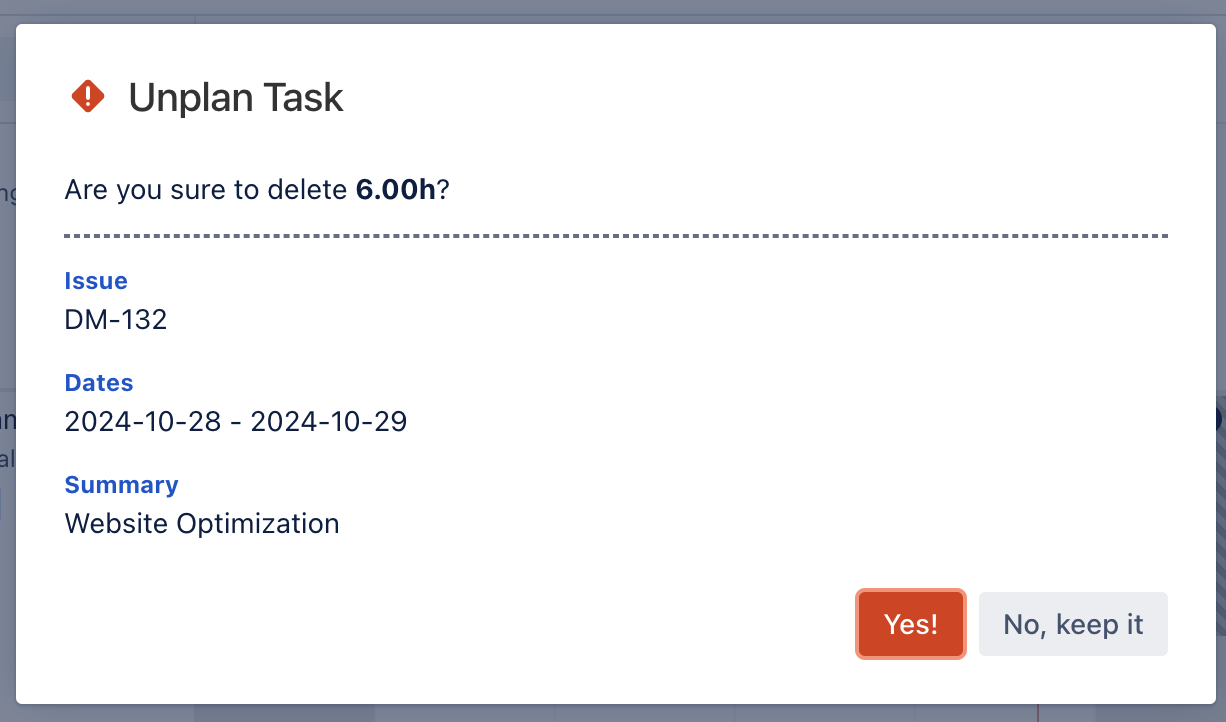

    Screenshot 2024-10-31 at 16.26.55.png

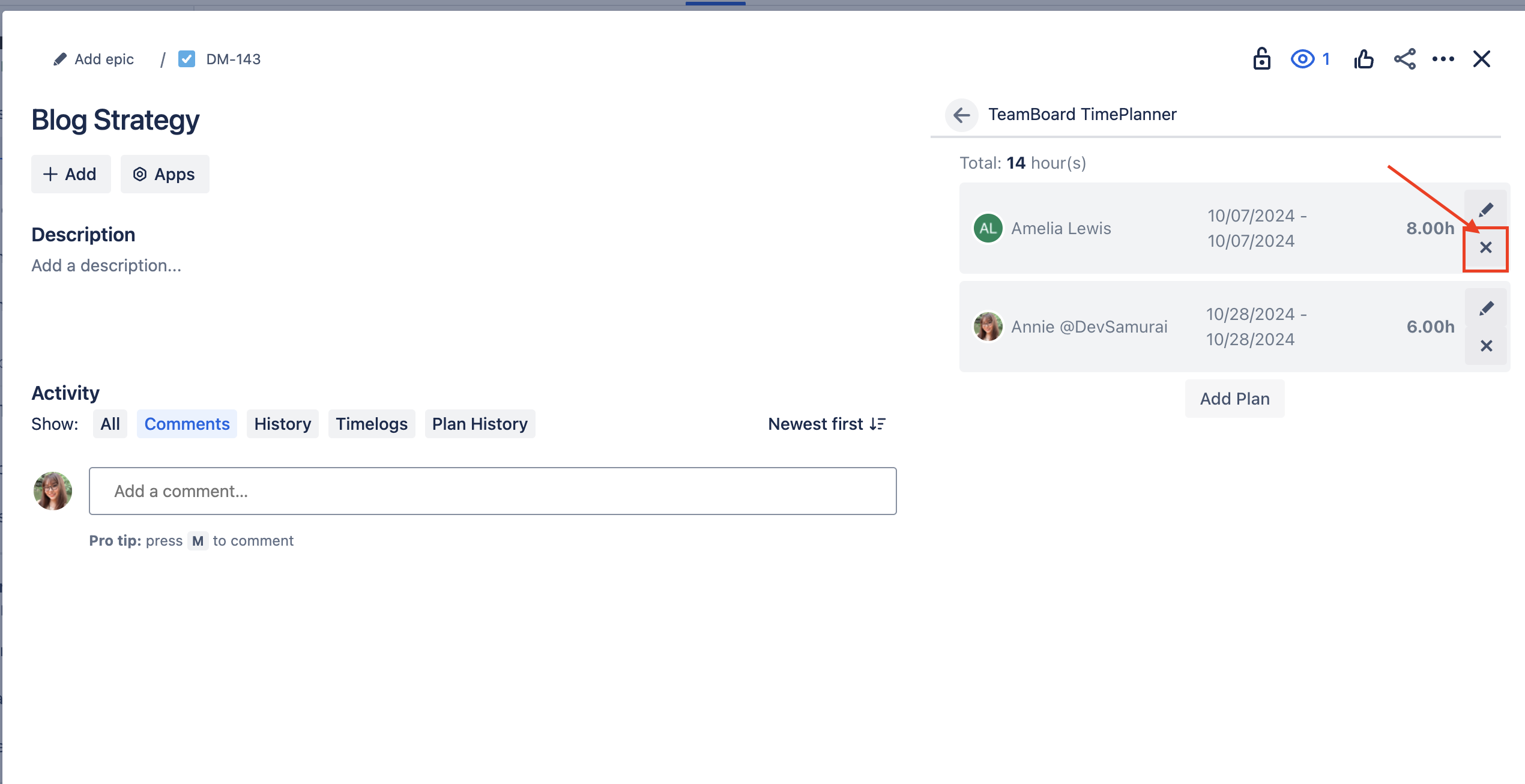

  3. In the Jira Issue Detail view, open the TeamBoard TimePlanner app → To remove a plan from the board, click the X on each plan you want to delete.

Screenshot 2024-11-07 at 16.30.18.png

5. Bulk Task Editing

Bulk editing does not apply to Recurring Tasks or Jira Field Mapping projects.

Bulk action on the Schedule board allows users to make changes to multiple tasks at once.

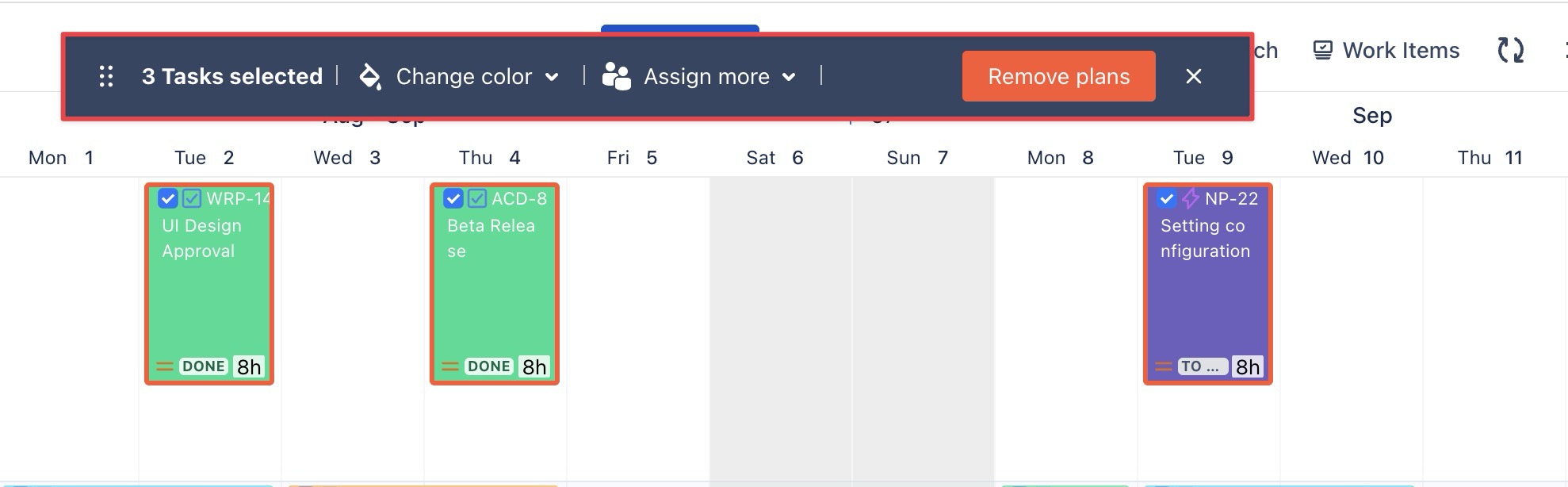

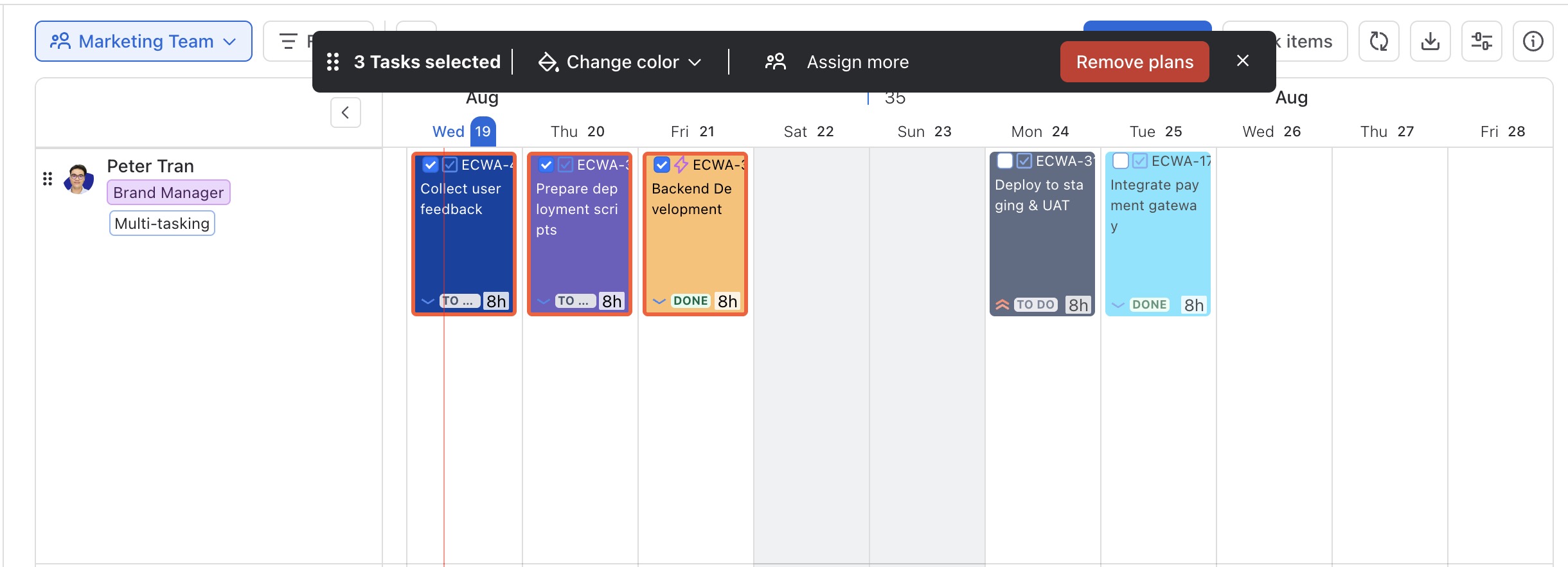

Users can select multiple tasks by checking the box on each task card → When tasks are selected, a bulk action toolbar appears on the board. (The toolbar can be flexibly moved to different positions on the board.)

From here, users can update:

  • Change the task card color

  • Assign tasks for additional members.

  • Unplan tasks.

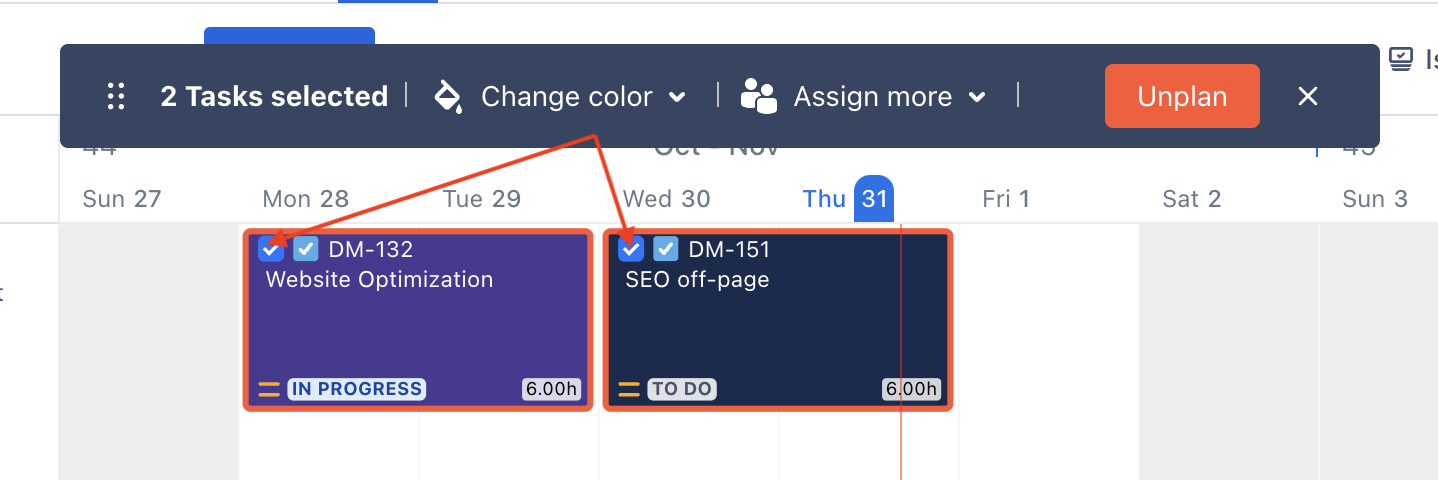

Screenshot 2024-10-31 at 16.17.54.png
