TeamBoard ProScheduler

Progress fields

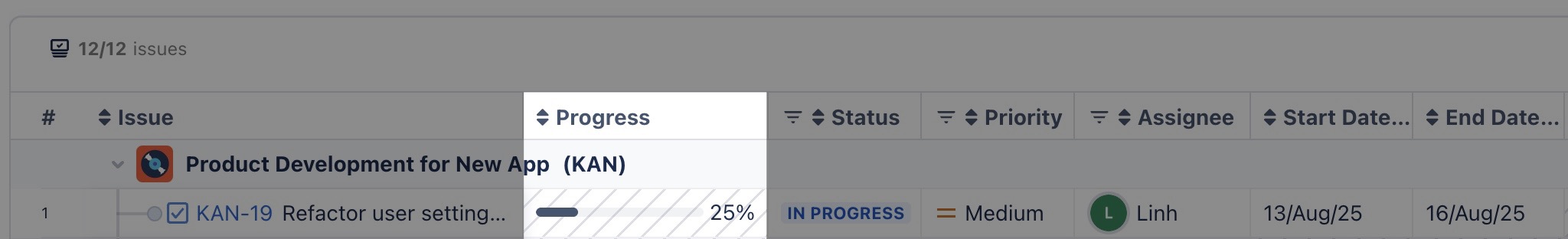

TeamBoard ProScheduler allows you to track progress using three different progress fields:

CleanShot 2025-08-03 at 09.08.05@2x-20250803-021241.jpg
  1. Progress (Teamboard): This field reflects the progress of tasks as calculated and updated within TeamBoard ProScheduler itself.

Learn more: How to configure and track progress in TeamBoard ProScheduler.

  1. Progress: This field reflects the progress of a work item, calculated by Jira using its native time tracking mechanism. It provides an accurate measure of progress based on Jira’s time tracking data.

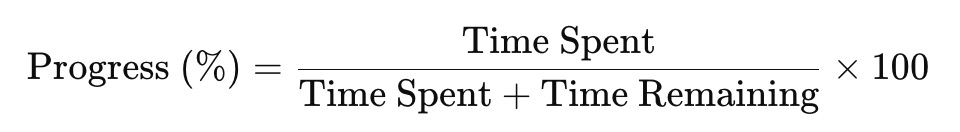

    The calculation uses the following formula:

CleanShot 2025-08-03 at 12.09.28@2x-20250803-050932.jpg


Example

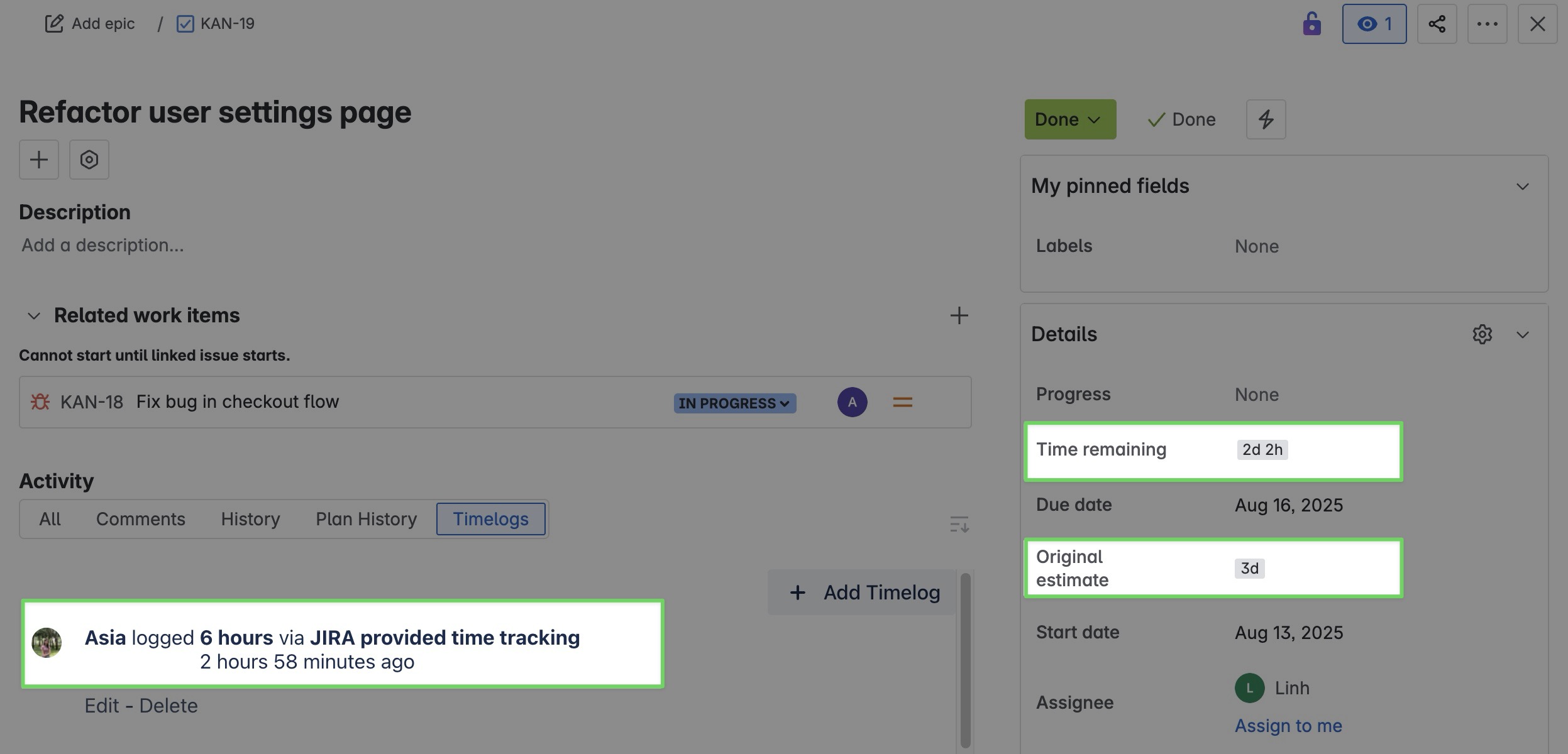

A Jira work item has the following details:

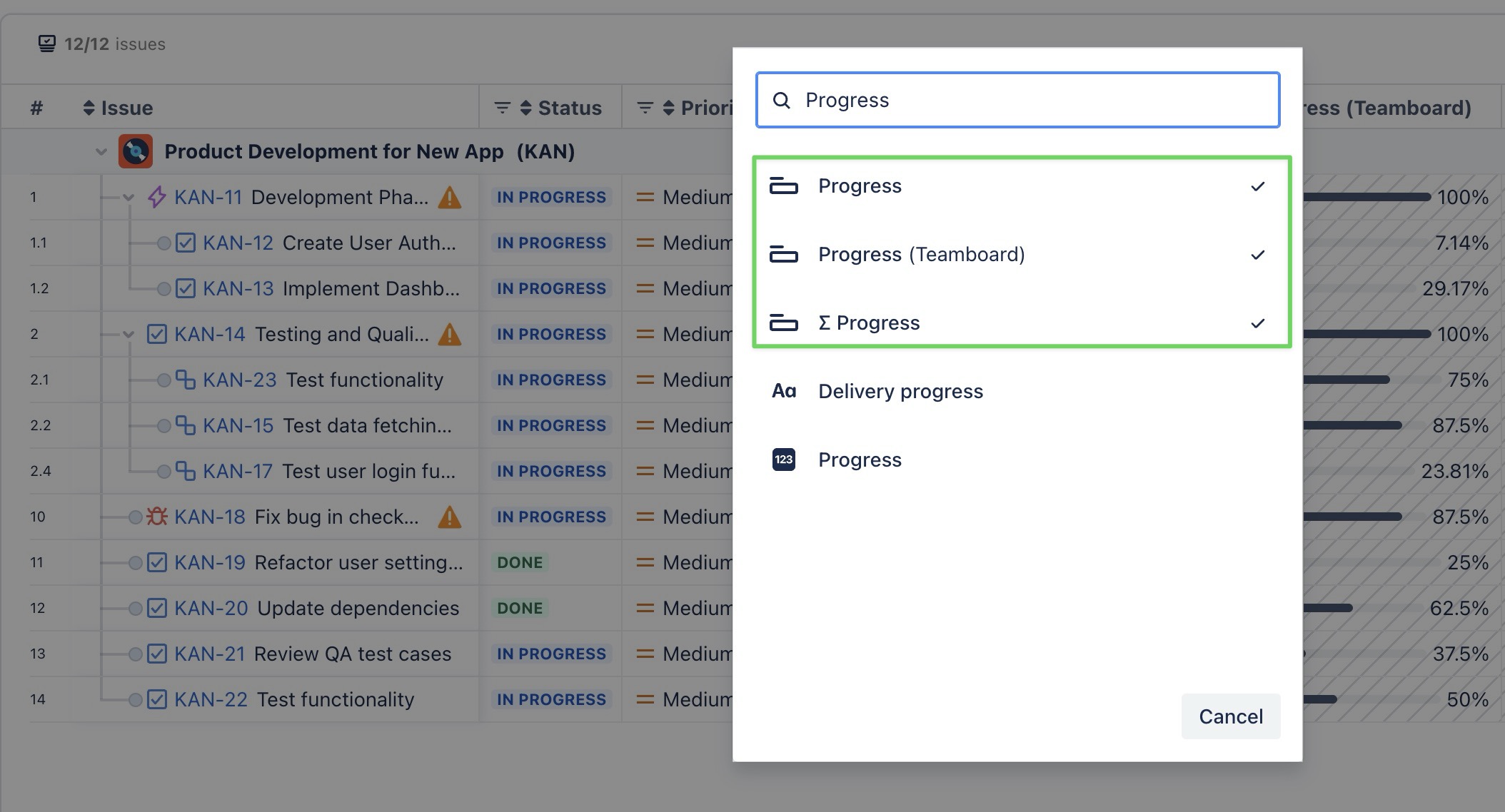

CleanShot 2025-08-03 at 12.02.54@2x-20250803-050423.jpg
  • Original Estimate: 3 days (24 hours)

  • Time Spent: 6 hours

  • Time Remaining: 2 days 2 hours (18 hours)

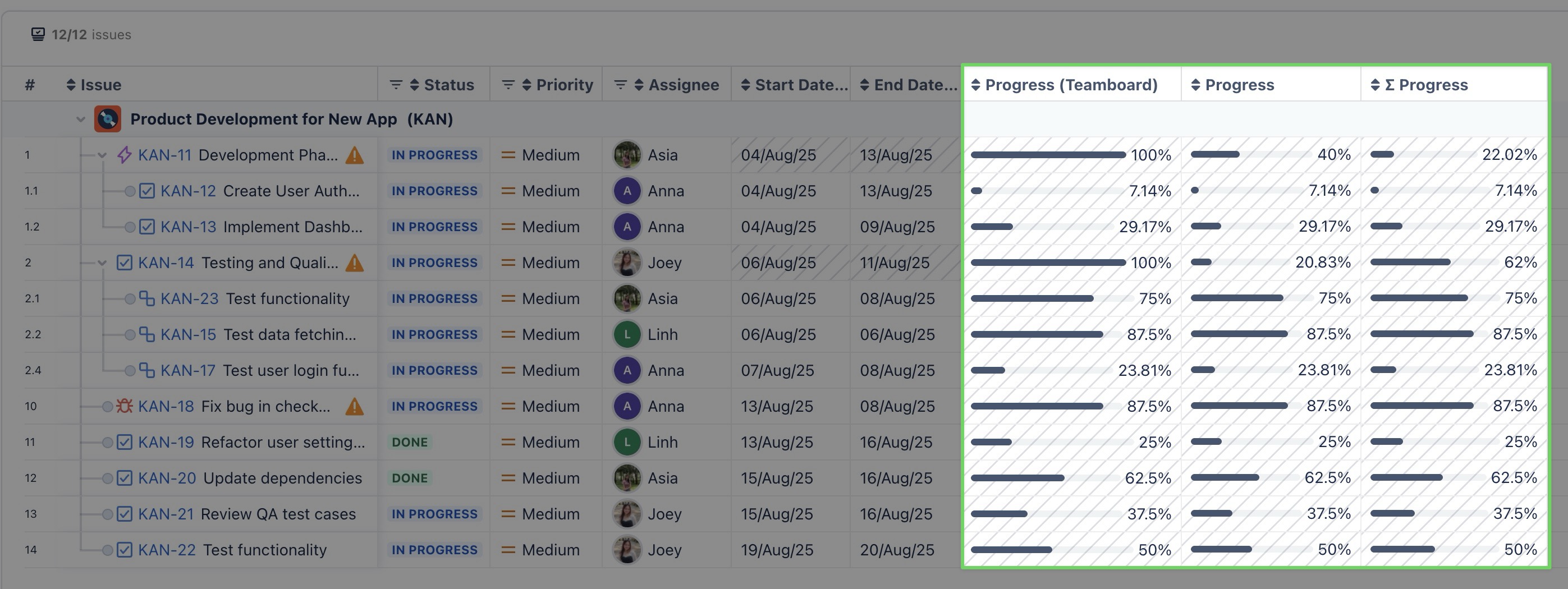

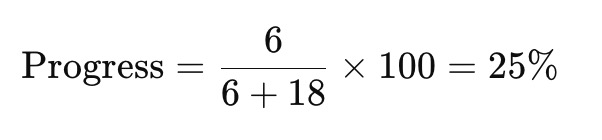

CleanShot 2025-08-03 at 12.11.37@2x-20250803-051140.jpg

So, the Progress field will display approximately 25% complete.

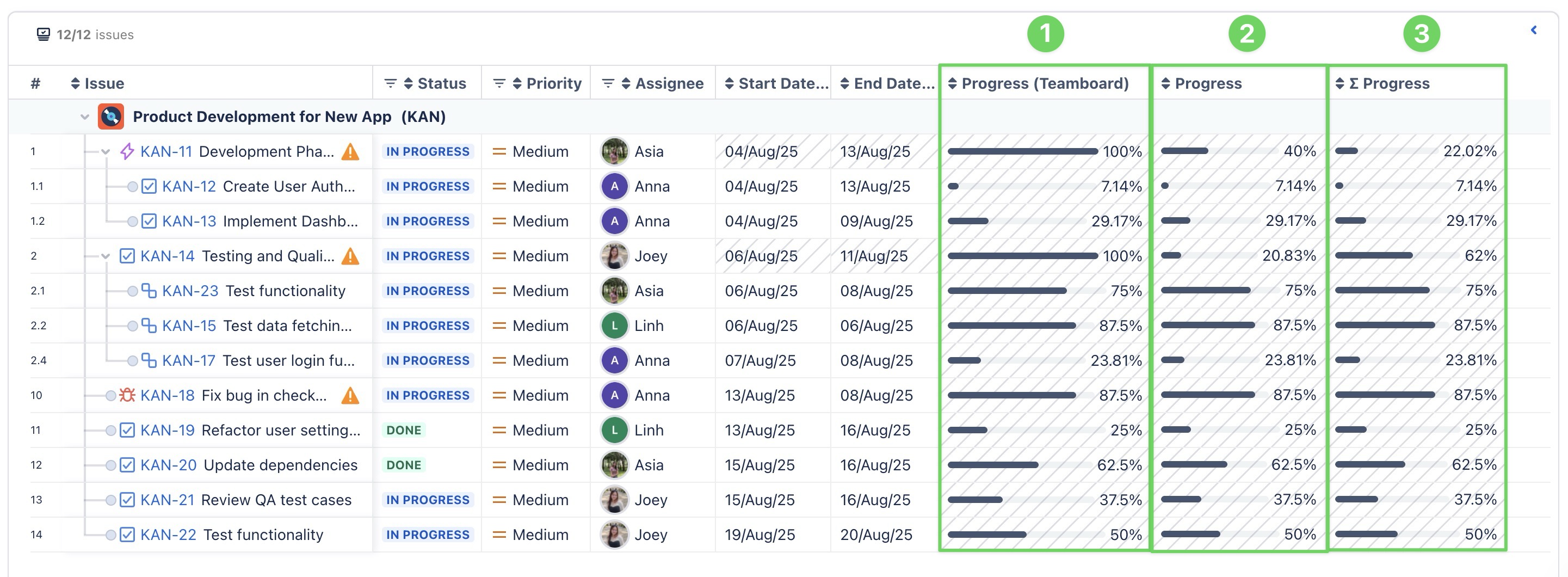

CleanShot 2025-08-03 at 12.13.58@2x-20250803-051429.jpg


  1. ∑ Progress: When a parent work item has linked child work items, Jira calculates the overall progress of the parent by aggregating the time tracking data of both the parent and all its child work items. This approach ensures an accurate representation of progress across the hierarchy.

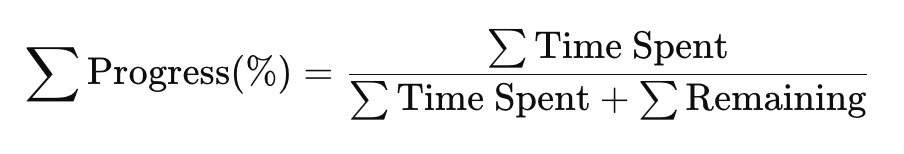

This aggregated progress is calculated using the following formula:

CleanShot 2025-08-10 at 14.39.17@2x-20250810-073920.jpg
Example

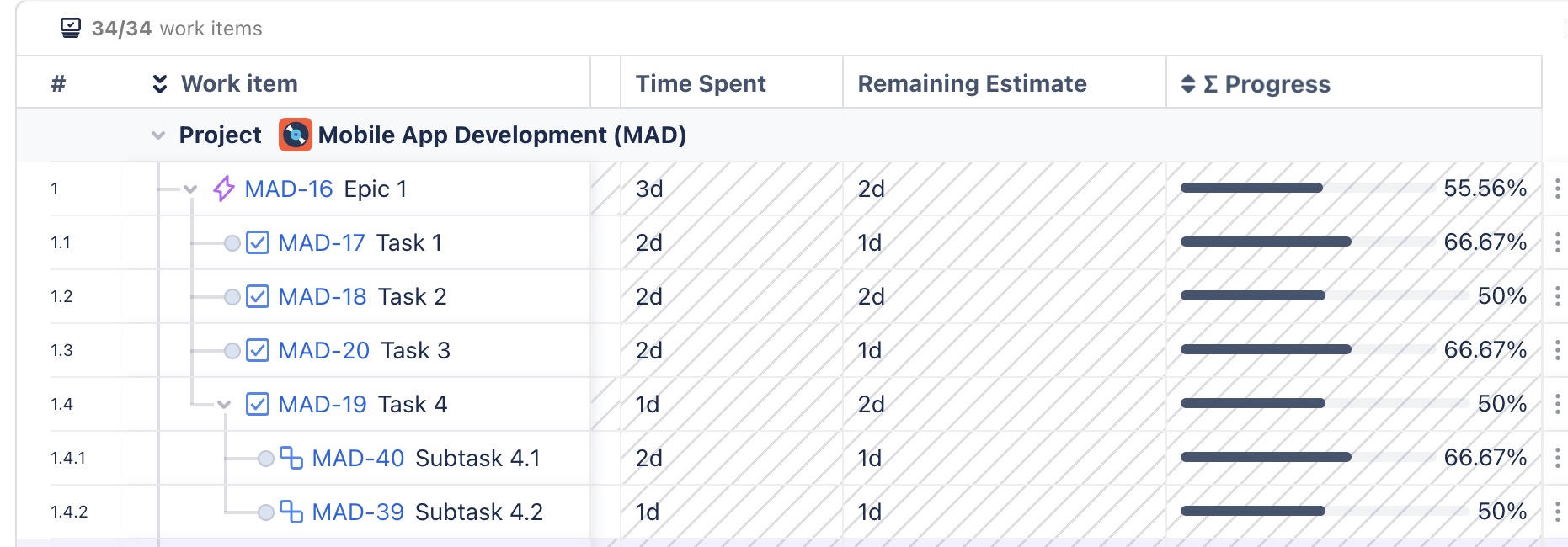

CleanShot 2025-08-10 at 14.19.34-20250810-072158.png

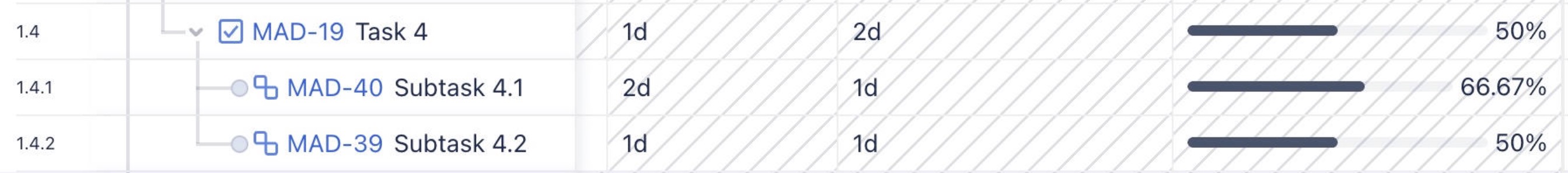

Task 4

CleanShot 2025-08-10 at 14.37.19@2x-20250810-073728.jpg
CleanShot 2025-07-20 at 21.21.08@2x-20250720-142118.jpg

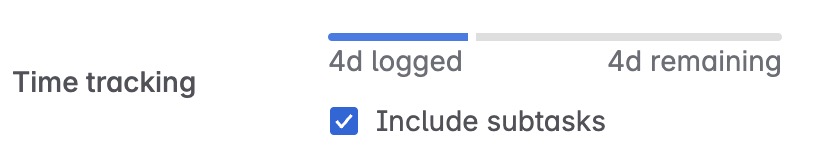

  • Total Time Spent = 1 + 2 + 1 = 4 days (includes Subtask 4.1 and Subtask 4.2)

  • Total Remaining Estimate = 1 + 1 + 2 = 4 days (includes Subtask 4.1 and Subtask 4.2)

  • Progress = 4 / (4+4) = 50%

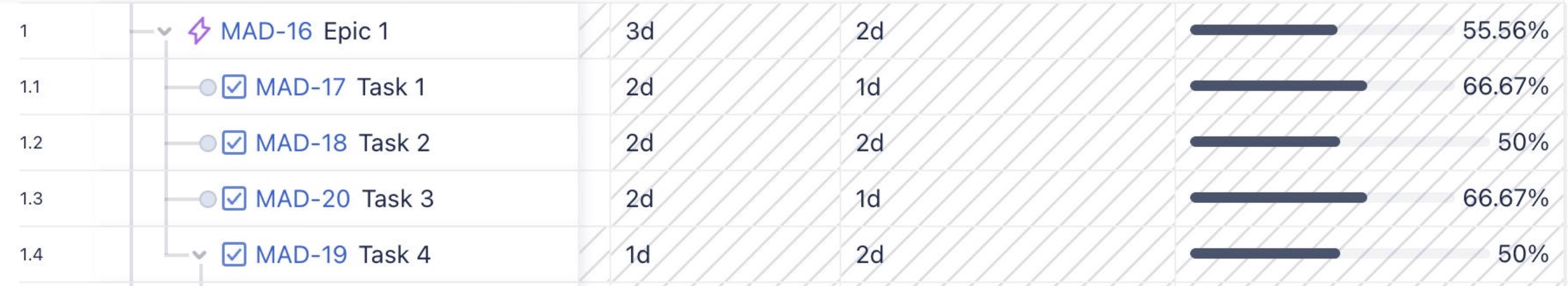

Epic 1:

CleanShot 2025-08-10 at 14.38.05@2x-20250810-073815.jpg
CleanShot 2025-07-20 at 21.32.45@2x-20250720-143249.jpg

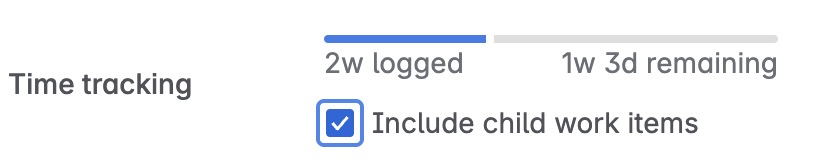

  • Total Time Spent = 1 + 2 + 2 + 2 + 3 = 10 days (includes task 4, task 3, task 2, and task 1)

  • Total Remaining Estimate = 2 + 1 + 2 + 1 + 2 = 8 days (includes task 4, task 3, task 2, and task 1)

  • Progress = 10 / (10+8) = 55.56%

Displaying Progress Fields in the Gantt Table

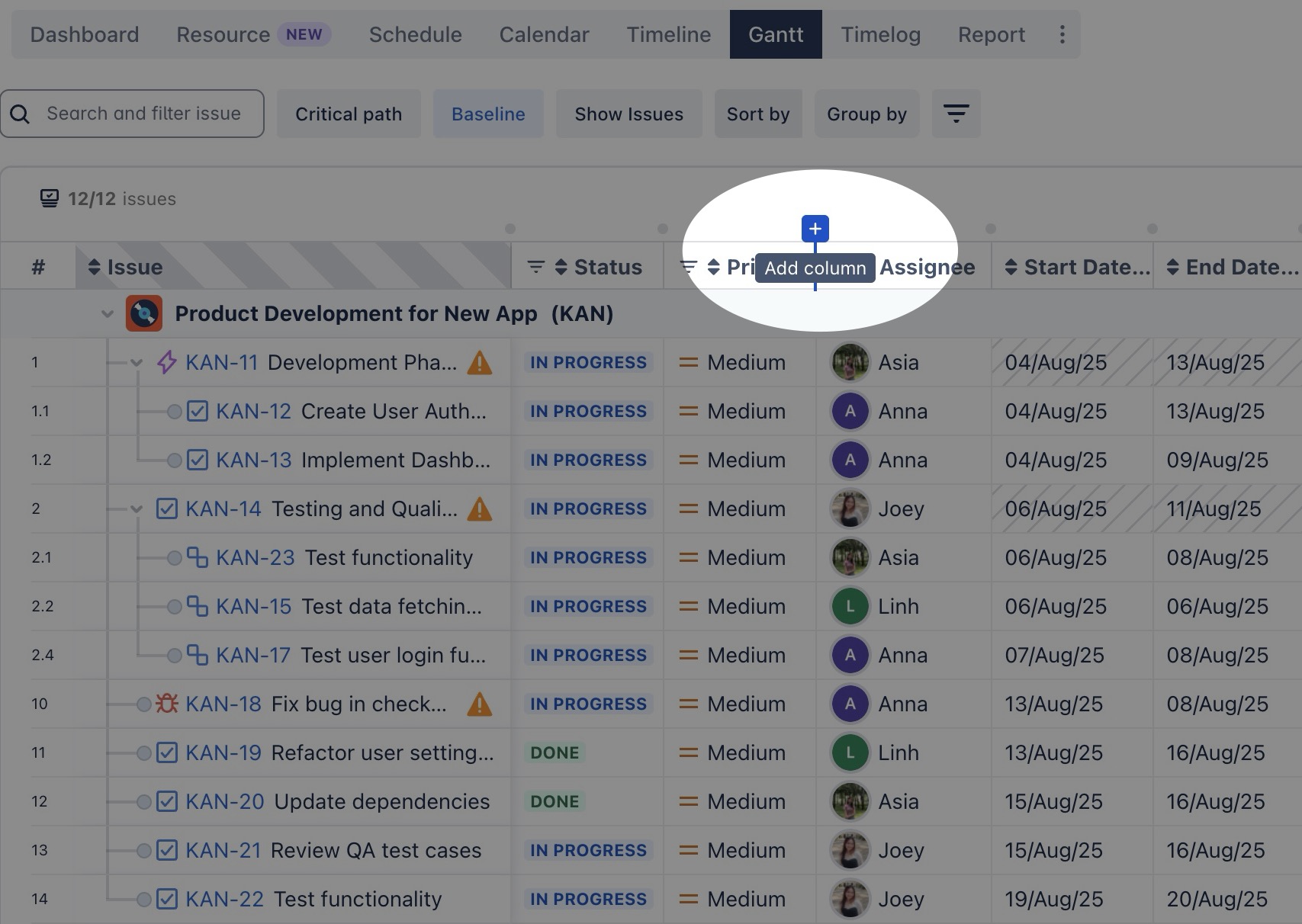

  1. From the Gantt table > click the button that appears on the right side of that column header.

CleanShot 2025-08-03 at 09.29.58@2x-20250803-023029.jpg
  1. In the list menu, you can either search for "progress" or scroll down to find the Progress field.

CleanShot 2025-08-03 at 09.32.42@2x-20250803-023318.jpg
  1. Once you find the Progress field, select it to display it in the table.

CleanShot 2025-08-03 at 09.33.59@2x-20250803-023457.jpg
